Alliance Steel AllianceLok 16 User manual

© Alliance Steel, Inc. 2015
THE NEW AND IMPROVED ALLIANCELOK 16
UNIVERSAL STANDING SEAM ROOF SYSTEM
INSTALLATION GUIDE
TripleLok™ Seam

Page 1
Dwg:
Date:
The New & Improved AllianceLok 16 Roof Systems Installation Guide
June 2015
INDEX
1.0 GENERAL
1.1 Purpose of the Installation Guide...................................................................................................... 2
1.2 Customer’s Responsibility ................................................................................................................ 2
2.0 SAFE ROOF INSTALLATION
2.1 Erector’s Responsibility .................................................................................................................... 3
2.2 OSHA................................................................................................................................................ 3
2.3 Walking & Working on Roof Panels .................................................................................................. 3
2.4 Handling Roof Materials in Strong Winds ......................................................................................... 4
3.0 CHECKING THE STRUCTURE
3.1 Completed and Braced ..................................................................................................................... 5
3.2 Lateral Stability ................................................................................................................................. 5
3.3 Alignment .......................................................................................................................................... 5
4.0 RECEIVING & HANDLING ROOF MATERIALS
4.1 Equipment for Unloading and Lifting................................................................................................. 6
4.2 Material Inventory ............................................................................................................................. 6
4.3 Lifting Roof Panel Bundles ............................................................................................................... 6
4.4 Field Storage of Roof Materials ........................................................................................................ 7
4.5 Handling Individual Roof Panels....................................................................................................... 8
5.0 ROOF INSTALLATION BASICS
5.1 Proper Tools..................................................................................................................................... 9
5.2 Equipment List .................................................................................................................................. 9
5.3 Sealants............................................................................................................................................ 9
5.4 Fasteners.......................................................................................................................................... 10
5.5 Field Cutting Panels and Flashing .................................................................................................... 11
6.0 ROOF PANEL LAYOUT
6.1 Sheeting Direction and Modularity.................................................................................................... 12
6.2 Layout & Checking for Coverage...................................................................................................... 12
6.3 Appearance Considerations.............................................................................................................. 12
7.0 INSPECTION OF ROOF ASSEMBLY DURING INSTALLATION
7.1 Importance of Inspection .................................................................................................................. 13
7.2 Inspection List................................................................................................................................... 13
8.0 STANDARD PARTS
8.1 General ............................................................................................................................................. 16
8.2 Standard Parts Details...................................................................................................................... 17
9.0 ROOF INSTALLATION DETAILS
9.1 General ............................................................................................................................................. 22
9.2 Preparation for Roof Panel Installation ............................................................................................. 23
9.3 Roof Panel Installation...................................................................................................................... 29
9.4 Termination Panel Installation........................................................................................................... 54
9.5 End Dam Installation......................................................................................................................... 62
9.6 Gable Trim Installation ...................................................................................................................... 70
9.7 Rake Transition Trim Installation....................................................................................................... 76
9.8 Ridge Cap Installation....................................................................................................................... 79
9.9 High Eave Transition Trim Installation .............................................................................................. 86
9.10 Eave Gutter Installation .................................................................................................................. 90
9.11 Hip and Valley Installation............................................................................................................... 94
The New & Improved AllianceLok 16 Roof Systems Seaming Guide............................................................ 97
The New & Improved AllianceLok 16 Roof Systems Architectural Details ................................................... 117
The New & Improved AllianceLok 16 Roof Systems Maintenance & Warranty Info .................................... 141
INDEX

Page 2
Dwg:
Date:
The New & Improved AllianceLok 16 Roof Systems Installation Guide
June 2015
1.0 GENERAL
1.1 Purpose of the Installation Guide
This Installation Guide is provided to Alliance Steel,
Inc. (“Alliance”) customers and their erectors as the
recommended procedure for the correct assembly of the
AllianceLok 16 Roof System.
This guide is intended to be used in conjunction with the
project’s Erection Drawings to help plan and organize
the installation of the AllianceLok 16 Roof System. The
Erection Drawings identify the applicable roof conditions
and govern specic part arrangements. This Installation
Guide will help you identify parts, establish the installation
sequence, demonstrate correct assembly, and point out any
areas or procedures requiring special emphasis or attention.
This Installation Guide applies to the standard AllianceLok
16 Roof System. Custom roof conditions, including custom
details and instructions, will be covered by the Erection
Drawings. In case of conict between this Installation
Guide and the Erection Drawings, the Erection
Drawings will have precedence.
1.2 Customer’s Responsibility
The customer is responsible for proper installation of the
roof in accordance with the Erection Drawings and this
Installation Guide, and in accordance with good engineering
and construction practices.
The customer must take the responsibility for selecting
a competent erector, insist that the work be performed
by qualied and experienced standing seam metal roof
installers, insist that the erector take time to study and
understand this guide, then assure that the erector correctly
follows the guide’s instructions.
Alliance does not guarantee and is not liable for the quality
of erection. Alliance is not responsible for building defects
that may be attributed to improper erection or the negligence
of other parties.
Clarification concerning the AllianceLok 16 roof
installation should be directed to the Alliance Customer
Service Department.
Contact the Alliance ofce:
Alliance Steel, Inc.
3333 S. Council Road
Oklahoma City, OK 73179-4410
(405) 745-7500 or (800) 624-1579
GENERAL
1.3 Weather Tightness Warranty Requirements
(if applicable)
Depending upon the type of warranty, Alliance may
require the roof installer to be certied by the manufacturer.
Warranty requirements should be veried on contract with
Alliance.
Alliance must approve in writing all roof penetrations prior
to installation. This includes but is not limited to; Roof Curbs,
Vent Pipes, & Mechanical Equipment. Submittals should
be forwarded to Alliance for review.
It is the customers responsibility to coordinate warranty
inspections with the Alliance warranty department.
Any special applications with regards to the weather
tightness of this roof system should be brought to the
attention of the warranty department at Alliance.

Page 3
Dwg:
Date:
The New & Improved AllianceLok 16 Roof Systems Installation Guide
June 2015
2.0 SAFE ROOF INSTALLATION
2.1 Erector’s Responsibility
The erector of the roof system is responsible for the safe
execution of this Installation Guide. These instructions are
intended to describe the sequence and proper placement
of parts. They are not intended to prescribe comprehensive
safety procedures.
If the erector cannot safely assemble the roof in accordance
with these instructions, it is the responsibility of the erector
to stop the work and contact Alliance to determine alternate
assembly procedures.
2.2 OSHA
The Occupational Safety and Health Act (OSHA) has
promulgated many regulations applicable to the
installation of this or any other roof system. These
regulations, identied as Part 1926, Safety and Health
Regulations for Construction, are available from any
government bookstore. The objective of the OSHA
standards is to protect the worker from injury or illness.
These OSHA regulations should be recognized as job site
requirements and be fully complied with.
Failure to do so may result in substantial nes in the event
of an OSHA inspection. Safe installation practices may
be further dened and made mandatory by state or local
ordinances.
Maintaining good housekeeping on the jobsite is
recognized as being important to both OSHA compliance
and to successful job completion.
2.3 Walking & Working on Roof Panels
Do not walk on the last installed panel run, as the
unsecured edge could collapse under a person’s weight.
When installing clips or making endlap connections, etc.,
stand where the Roof Structural will support your weight.
An approved and safe walking platform should be used
in high trafc areas to prevent the Roof Panel from being
deformed, scratched, or scuffed.
A. PLACING PANELS ON THE STRUCTURE
Do not place bundles of panels on the Roof Structure
without rst verifying the structure will safely support the
concentrated weight of the panels and the weight of the
installation crew. Some Roof Structures may not be
designed to support the weight of a full panel bundle without
additional structure support.
B. WALKING ON ROOF PANELS
Do not use a Roof Panel as a working platform. An
unsecured panel could collapse under the weight of a
person standing between purlins or at the panel end.
C906.200
SAFE ROOF INSTALLATION
Assembled
Sidelap
(Typ.)
Leading Roof Panel
Unassembled
Sidelap
CAUTION — INCORRECT
DO NOT step on leading (unsecured) Roof Panel.
Assembled
Sidelap (Typ.)
Leading Roof Panel
Unassembled
Sidelap
CORRECT
Step ONLY on secured Roof Panels

Page 4
Dwg:
Date:
The New & Improved AllianceLok 16 Roof Systems Installation Guide
June 2015
2.0 SAFE ROOF INSTALLATION
2.3 Walking & Working on Roof Panels (Continued)
C. SAFETY EQUIPMENT
The use of safety equipment for the Roof Panel installation
is recommended at all times during the installation process.
However, when using lanyards, ensure that the clasp, belt
hooks and wire cables are covered in such a manner that
they will not scratch the panel surface if accidentally dragged
along the panel.
D. CREW SIZE
The length of the individual Roof Panels should be
considered when determining the crew size. It is
recommended that under normal conditions, there be

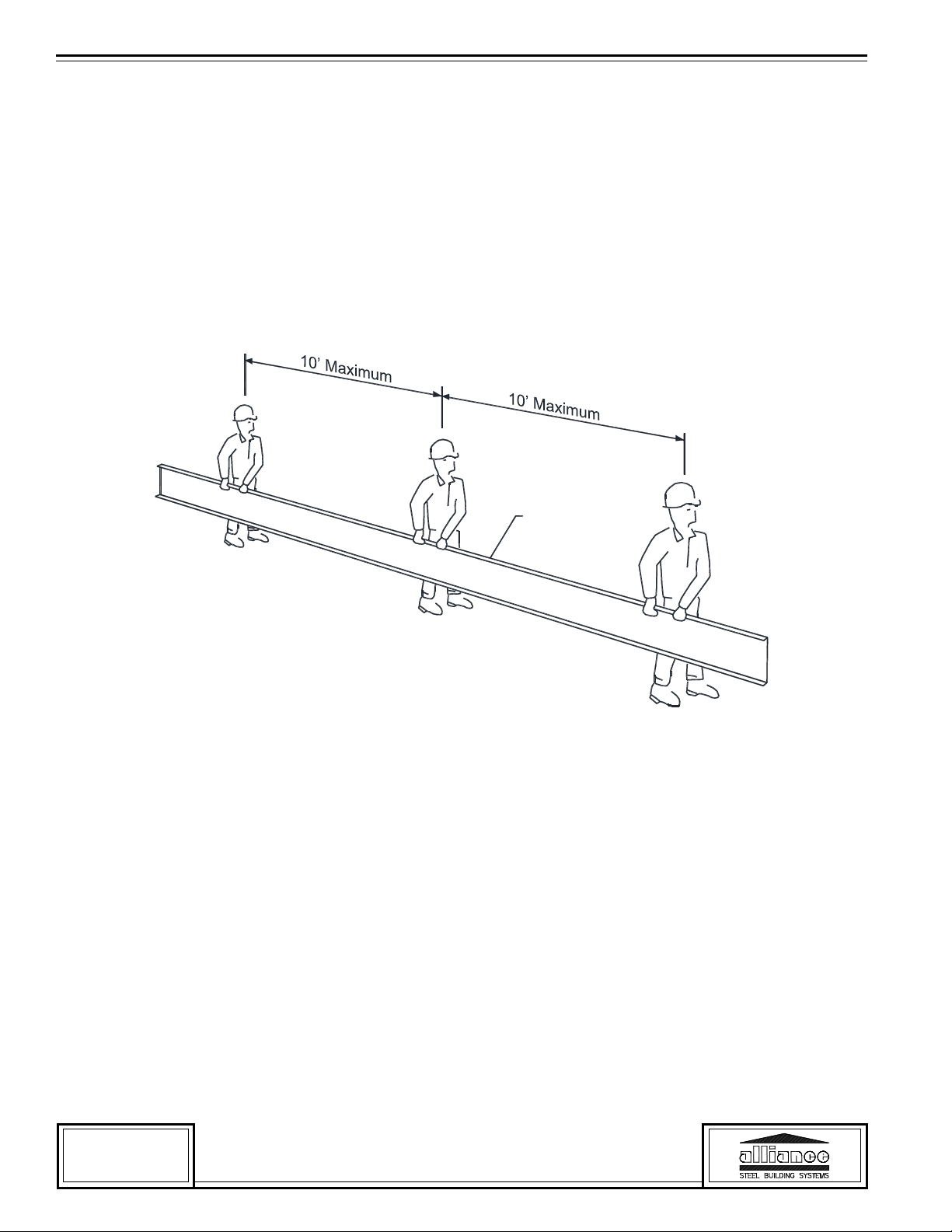

one person for every ten feet of panel length, plus one.
E. PANEL OVERHANG
Do not stand on the end of unsupported (cantilevered)
panels at the eave or ridge. Standing on the cantilever
portion may result in panel collapse.
F. POINT LOADS
When properly supported by the structurals, panels are
designed to support uniform loads, which are evenly
distributed over the panel surfaces. Point loads that occur
in small or concentrated areas, such as heavy equipment,
ladder or platform feet, etc., may cause panel deformation
or even panel collapse.
G. SLICK SURFACES
Panel surfaces and structural steel surfaces are hard,
smooth, and nonabsorbent, which causes these surfaces
to be very slick when wet or covered with snow or ice.
Even blowing sand or heavy dust can make these surfaces
difcult to walk on without slipping.
Unpainted panel surfaces are often coated with oil to
accommodate the panel-fabrication process. Although
designed to wash away or evaporate during normal weather,
the oil on new panels can be extremely slick, especially
during periods of light rain or dew.
Caution must be exercised to prevent slipping and falling
onto the roof surface or even sliding off the roof. Non-slip
footwear is a necessity and non-slip working platforms are
recommended.
H. ELECTRICAL CONDUCTANCE
Metal panels are excellent electrical conductors. A common
cause of injury is the contact of metal panels with power
lines during handling and installation. The location of all
power lines must be noted and, if possible, agged. The
installation process must be routed to avoid accidental
contact with all power lines and high voltage services and
equipment. All tools and power cords must be properly
insulated and grounded and the use of approved ground
fault circuit breakers is recommended.
I. FALSE SECURITY OF INSULATION
Blanket and board insulation blocks the installer’s view of
the ground below the roof. Serious injury can occur when
the installer gets a false sense of security because he
cannot see the ground and steps through the insulation.
J. SHARP EDGES
Some edges of panels and trim are razor sharp and can
cause severe cuts if proper protective hand gear is not
worn. Be careful not to injure others while moving panels
and trim.
2.4. Handling Roof Materials in Strong Winds
Do not attempt to move panels in strong winds. Wind
pressure can easily cause a man to lose balance and fall.
Strong wind uplift on a panel can lift the weight of the man
carrying the panel.
Loose, wind borne panels are very dangerous and can
cause severe injury and damage.
Secure stacks of panels with banding or tie-downs, so
wind will not blow the panels off the roof. Clamp individual
unsecured panels to the Roof Structurals. Clamp or block
panel bundles and accessory crates to prevent them from
sliding down the roof slope.
SAFE ROOF INSTALLATION

Page 5
Dwg:
Date:
The New & Improved AllianceLok 16 Roof Systems Installation Guide
June 2015
3.0 CHECKING THE STRUCTURE
3.1 Completed and Braced
Before placing materials and workers on the Roof
Structure to start roof installation, it must be conrmed that
the structure is designed to accommodate the material and
erection loads as well as the appropriate live loads and
wind uplift loads.
It also must be determined that the structure is complete
and structurally sound with all structural connections and
bracing in place and secure.
3.2 Lateral Stability
The sliding clip method of attaching the Roof Panels to the
Roof Structurals provides only limited lateral stability and
diaphragm bracing to the Roof Structurals.
Before placing materials on the roof and starting the roof
installation, conrm that the necessary roof bracing and
sag angles, strapping or bridging is in place and secured.
3.3 Alignment
Prior to installation, Roof Structurals should be checked
for overall dimensions and evenness of plane. The Roof
Structurals should also be checked to verify the roof system
can be installed without interference. Also, Roof Structurals
nearest the panel endlaps, ridge or high eave should be
checked for correct location to properly accommodate the
roof components.
A. TOLERANCES
To assure the roof system’s correct t-up and designed
weather tightness, the structure must be aligned within the
following tolerances:
Out of Square — The roof system can accommodate
1/8” of sawtooth of the Roof Panel ends at the eave, ridge
and panel splices. This means the allowable out of square
of the rake line relative to the eave line and ridge line is 1/2”
for each 10’ of rake run.
Structure Width and Eave Straightness — The roof
system is designed to accommodate ±2” of overall structure
width error, or ±1” of eave straightness error at each eave.
To assure that the accumulation of the structure width
error and eave straightness error does not exceed the roof
system’s tolerance, the structure width should be measured
from eave line to eave line at each rake, at the rst frame
line from each rake and at each point where there is a
signicant error or change in eave straightness (this usually
occurs at a frame line or at a wind column).
Structure Length and Rake Straightness — The roof
system is designed to accommodate ±2” of overall structure
length error, or ±1” of rake straightness error at each rake.
To assure that the accumulation of structure length error and
rake straightness error does not exceed the roof system’s
tolerance, the structure length should be measured from
rake line to rake line at each eave, at the ridge and at each
point where there is a signicant error or change in rake
straightness (this usually occurs at an end rafter splice).
B. MEASURING
Structure length and width may be measured with a
steel Measuring Tape from the face of the eave or rake
member to the face of the opposite eave or rake member.
The Measuring Tape must be parallel to the relative eave
or rake line and must be stretched taut.
Eave and rake straightness may be determined by
measuring deviations from a string line, which is stretched
taut along the eave or rake line.
C. AESTHETIC ACCEPTANCE
Although these structure alignment tolerances will allow for
reasonable roof component t-up and ease of installation,
the extremes of these tolerances may be aesthetically
objectionable and should be conrmed with the customer
before starting the roof installation.
D. CORRECTIONS
Any structure alignment error, which exceeds the above
stated tolerances, must be corrected before roof installa-
tion can begin. If it is decided that the structure alignment
errors cannot be corrected, alternate roof details may
have to be developed. The alternate details may require
additional materials, modied parts (with additional cost,
fabrication and delivery time) and additional installation
time. Alliance cannot assure the performance of such
alternate details.
CHECKING THE STRUCTURE

Page 6
Dwg:
Date:
The New & Improved AllianceLok 16 Roof Systems Installation Guide
June 2015
4.0 RECEIVING & HANDLING ROOF MATERIALS
4.1 Material Inventory
Your material is carefully inspected and crated before
leaving the plant and accepted by the transportation
company as being complete and in satisfactory condition.
It is the carrier’s responsibility to deliver the shipment intact.
It is the consignee’s responsibility to inspect the shipment
for damages and shortages when it is delivered.
Conducting a material inventory at the time of delivery
is essential. By conducting the materials inventory,
the erector is able to identify any material shortage or
damage and avoid stopping installation later because of
such shortage or damage.
It is imperative that any shortages or damage of the
delivered materials be noted at once and clearly marked
on the bill of lading before signature of acceptance. Notify
Alliance immediately of any conicts. Alliance will not be
responsible for shortages or damages unless they are
noted on the bill of lading.
In the case of packaged components (such as clips,
fasteners and sealants, etc.), the quantities are marked on
their container and should be checked against the bill of
materials. Alliance must be notied of any shortages or
concealed damage within 15 days of delivery.
4.2 Equipment For Unloading and Lifting
Hoisting equipment is necessary to unload and position
the panels and accessory crates for site storage and
installation. The equipment must have sufcient capacity
and reach to place the material where it is required for
efcient installation.
Slings will be required to minimize panel damage. The
recommended slings are nylon straps of 6” minimum width
and of sufcient length to accommodate the panel bundle
girth.
A Spreader Bar will be required for the longer panel crates
to assure correct sling spacing and uniform lifting. The
Spreader Bar must be large enough to handle the maximum
panel bundle weight and length.
A Forklift is handy for unloading and placing shorter panel
and accessory crates.
4.3 Lifting Roof Panel Bundles
Under normal conditions, panel crates less than 35’ long
can be lifted with two slings spaced at third points. Panel
crates longer than 35’ can be lifted with three or more slings
located at quarter points using a Spreader Bar to achieve
correct sling spacing for uniform lift.
Slings should be located under the cross boards. Loads
should always be checked for secure hook-up, proper
balance, and lift clearance. Tag lines should be used if
necessary to control the load during lifting, especially if
operating in the wind.
Panel crates less than 25’ long may be lifted with a Forklift
only if the forks are spread at least 5’ apart and blocking
is used to prevent panel damage by the forks.
C906.201 RECEIVING AND HANDLING ROOF MATERIALS
Spreader Bar
Panel Bundle
Equal Spaces
Web Slings
5’ Minimum
Panel
Bundle
Forklift
Fork
Blades

Page 7
Dwg:
Date:
The New & Improved AllianceLok 16 Roof Systems Installation Guide
June 2015
4.0 RECEIVING & HANDLING ROOF MATERIALS
4.4 Field Storage of Roof Materials
Upon acceptance of the shipment, the customer or his
representative is responsible for proper handling storage
and security of the roof materials. Alliance is not liable for
damage or loss of materials at the job site.
The Roof Panel bundles should be stored on the job site
in accordance with the following recommendations:
a. Store panels in a protected area, out of standing
water and drifting snow, etc.
b. Elevate panels with blocking to allow air circulation
under the bundle.
c. Slope panels for drainage of moisture from the
panels.
d. As necessary, cover panels with waterproof tarp,
allowing for air circulation (do not wrap tarp under
panel crate or restrict air movement).
e. Inspect panels daily for moisture accumulation.
f. If panel bundles contain moisture, the panels should
be dried and re-stacked. Use care in re-stacking
to avoid damage to panels.
g. Opened or re-stacked panel bundles should be
secured to prevent wind damage.
When moving panel bundles, extreme caution should be
taken to prevent damage to the panel edges. Uncrated
panels should be supported at each end and at 10’ spaces.
All bundles or loose panels on the roof should be banded
to the Roof Structurals at the end of each workday. On
steep roofs, provisions should be taken to prevent panels
and panel crates from sliding off the roof. Be sure to set
panel bundles on the roof in the proper direction for the
installation sequence.
Trim and accessories should be stored in a secure area
and protected from damage, weather, and theft. Fasteners,
sealants, closures, etc. should be stored out of the weather
and protected from contamination.
C906.202
RECEIVING AND HANDLING ROOF MATERIALS
Stack bloking so bundle
is sloped for drainage
Panel Bundle
Tie-downs located
over blocking
Blocking

Page 8
Dwg:
Date:
The New & Improved AllianceLok 16 Roof Systems Installation Guide
June 2015
4.0 RECEIVING & HANDLING ROOF MATERIALS
4.5 Handling Individual Roof Panels
To lift individual panels, lift one side of the panel by the
seam letting it hang naturally to prevent buckling. Pick-up
points should not be more than 10’ apart. Do not pick-up
panels by the ends only, or in a at position.
If the individual panels are to be lifted to the roof by hand
line, the common method is to use the Vice Grip “C” clamps.
Position the clamps on the at of the panel as close as
possible to one edge so the panel is lifted in a vertical
position. The jaws of the Vice Grips must be padded to
prevent damage to the panel surface. The clamps should
be uniformly spaced, no more than 10’ apart and the hand
lines must be pulled in unison so that uneven lifting does
not buckle the panel. Be sure the clamps are tight on the
panel and the line is secure to prevent dropping the panel
which can result in personal injury and property damage.
C906.203 RECEIVING AND HANDLING ROOF MATERIALS

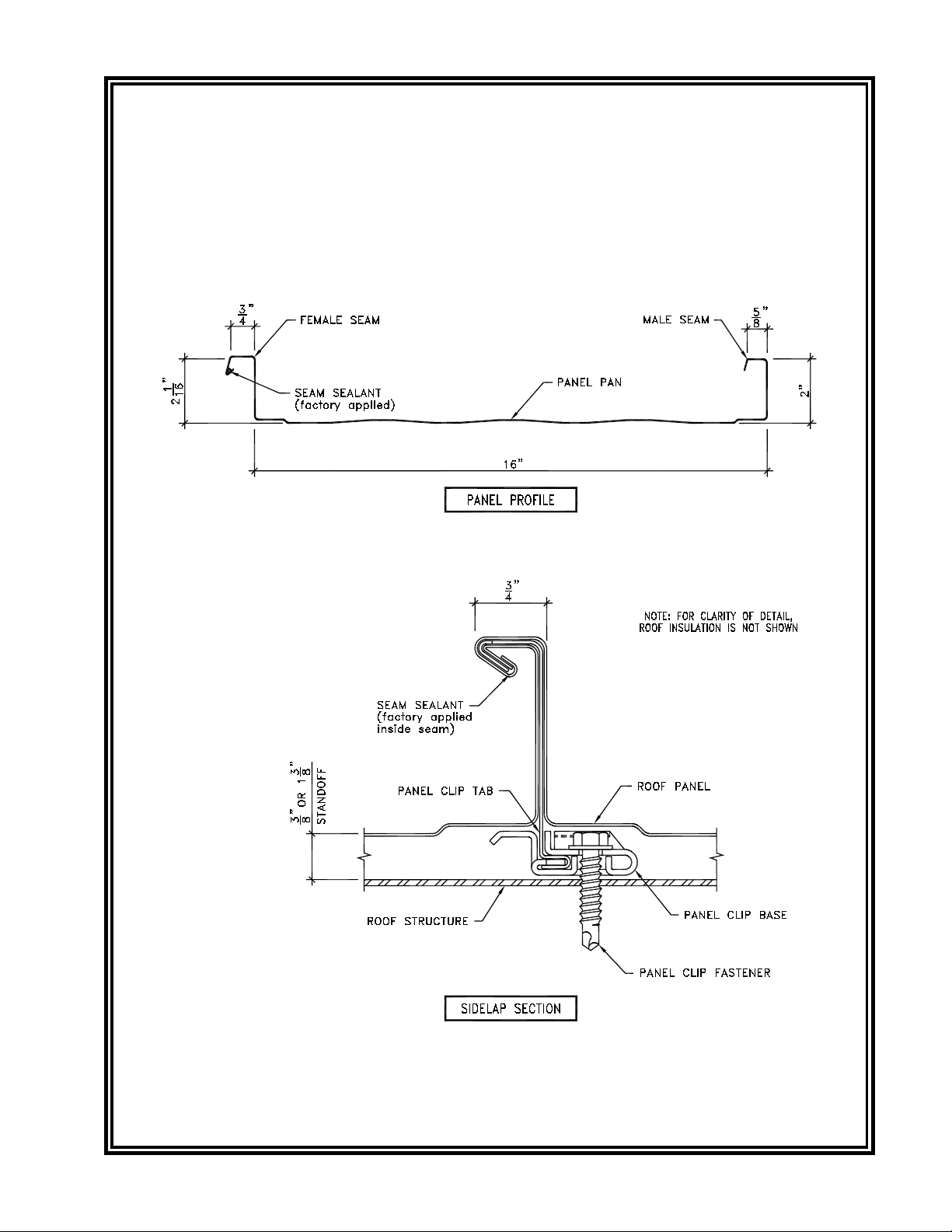

Roof Panel

Page 9
Dwg:
Date:
The New & Improved AllianceLok 16 Roof Systems Installation Guide
June 2015
5.1 Proper Tools
Before starting paneling, be sure that the proper equipment
and tools are on hand. The tools must be in good operating
condition and operators should adhere to safety precautions
at all times.
Improperly operating tools, too few tools, inadequate
power source, or other equipment deciencies slow down
the installation process. The cost of inefcient working is
usually greater than the cost of providing good equipment.
5.0 ROOF INSTALLATION BASICS
5.2 Equipment List
The following tools and equipment should be considered for
efcient installation of the AllianceLok 16 Roof Panel. Actual
tools and equipment required may vary due to variations in
building type and construction.
This list should not be interpreted as a limitation to your
inventory of installation equipment.
*PC Seam Clamp — Minimum of (2) required
*PC Motorized Seaming Machine
*ESE #812 Manual Seaming Tool
Screw Guns — Designed for use with self-drilling screws
Socket Extensions — 6” extension for screw gun
Hex Socket Heads — 5/16” and 3/8”, magnetic
Drill Motor — 1/4” capacity
Drill Bits — Assortment
Sheet Metal Cutter — or power shears or nibbler
“C” Clamps — vise grip, sheet meal type
Pop Rivet Tool — 1/8” capacity
Sheet Metal Shears — left and right cut
Steel Measuring Tape — 12’, 50’, 100’
Nylon String Line
Chalk Line
Brooms
Marking Pen
Caulk Guns — for 1/10 gallon sealant tubes
Power Source and Extension Cords — capable of handling
the total equipment requirements, including 20-amp
seamer machine, without power drop due to extension
cord length.
*These tools are specically designed for the AllianceLok
16 Roof Panel and are available from the Alliance.
5.3 Sealants
A. TEMPERATURE EFFECTS
Temperature extremes must be considered during
installation of the roof due to the sensitivity of sealants.
The recommended installation temperature range is 20º
F to 120º F. At colder temperatures, the sealant stiffens
resulting in loss of adhesion and compressibility. At hotter
temperatures, the sealant becomes too soft for practical
handling. On cold but sunny days, the panel’s surface may
become warm enough to accept the application of a heated
sealant even though the air temperature is below 20º F.
When overnight temperatures fall below freezing, the
sealant should be stored in a heated room so it will be warm
enough to use the following day. On hot days, the sealant
cartons should be stored off the roof in a cool and shaded
area. While on the roof, sealant rolls should be kept shaded
until actual use.
In very cold weather, it is recommended that the fasteners
be tightened slowly and only tight enough that the sealant
is in full contact with the panel or trim. Then on the next
sunny day, complete the tightening process after the sun
warms the panel and trim surfaces.
B. CONTAMINATION
To assure proper adhesion and sealing, the sealant
must have complete contact with adjoining surfaces.
Contaminants such as water, oil, dirt and dust prevent
such contact. The panel and trim surfaces must be dry
and thoroughly cleaned of all contaminants. Before
applying Tape Sealant, the sealant should be checked for
contaminants. If the sealant surfaces are contaminated, it
must not be used.
During cool weather, condensation or light mist can
accumulate on the panel and trim surface and not be easily
noticed. It is recommended that sealants always be kept
under protective cover and that the panel and trim surfaces
be wiped dry immediately before installation.
Tape Sealant is provided with a protective paper to
reduce contamination. Incomplete removal of the
protective paper will prevent the sealant’s adhesion to the
panel or trim surfaces. Always check that the protective
paper is completely removed. Do not remove the protective
paper until immediately before the panel or trim is installed
over the sealant.
ROOF INSTALLATION BASICS

Page 10
Dwg:
Date:
The New & Improved AllianceLok 16 Roof Systems Installation Guide
June 2015
5.0 ROOF INSTALLATION BASICS
5.3 Sealants (Continued)
C. COMPRESSION
To assure proper adhesion and seal, the Tape Sealant must
be compressed between the panel and trim surfaces with
rm and uniform pressure. In most cases, the required
pressure is applied by the clamping action of screws
pulling the adjoining surfaces together. However, the Tape
Sealant’s resistance to pressure becomes greater in cold
weather.
During cold weather, the fasteners must be tightened
slowly to allow the sealant time to compress. If the
fasteners are tightened too fast, the fastener may strip out
before the sealant compresses adequately, or the panel
or ash may deform in the immediate area of the fastener,
leaving the rest of the sealant insufciently compressed.
D. INSIDE CORNERS
An inside radius, such as where the panel at meets a
rib, is usually the most critical area to seal. A common
mistake for the installer, is to bridge the sealant across the
inside radius. When the lapping panel or trim is pushed
into place, the bridged sealant is stretched and thinned.
The sealant may then be too thin to adequately seal this
critical area.
When Tape Sealant is applied at an inside radius, it is
recommended that the sealant be folded back on itself,
then push the sealant fold into the radius.
5.4 Fasteners
A. SCREW GUN
Use torque control Screw Guns for driving self-drilling
screws. 2000-2500 RPM Screw Gun speeds are necessary
to attain efcient drilling speeds. High tool amperage (4 to
7 AMP) is required to achieve the proper torque for secure
fastening.
B. SOCKETS
Use good quality Sockets. Good tting Sockets reduce
wobble and stripping of the screw heads, especially the
alloy and capped heads. They also minimize objectionable
paint chipping and scufng on colored screws and minimize
damage to the protective coating on unpainted screws.
Magnetic Sockets collect drill shavings, which will build up
and eventually prevent the Socket from seating properly
on the screw heads. One method of removing the drill
shavings is to roll up a ball of Tape Sealant and push the
Socket into the sealant.
When the Socket is removed from the sealant, most of the
drill shavings will remain embedded in the sealant thereby
cleaning the Socket. This process should be repeated as
often as needed to keep the Socket clear of drill shavings.
C. SOCKET EXTENSION
A 4” or 6” Socket Extension is recommended for installing
the Panel Clip screws. With the extension, the screw can
be driven straight down without tilting the screw gun to
clear the panel or clip. Since Socket Extensions are slow
to wear out, it is usually more cost effective to purchase
Socket Extensions and good quality Sockets rather than
purchase Sockets with built-in extensions.
D. INSTALLATION
Before starting the screw, the materials to be joined must be
pressed together with foot or hand pressure. The pressure
must be maintained until the screw has drilled through all
the materials and the threads have engaged.
C906.204 ROOF INSTALLATION BASICS
Roof Panel
Sealant
Endlap
Void
Void
Critical:
Do not allow the
sealant to bridge
across inside radii
creating voids
Roof Panel
Endlap
Fold the sealant
and push the fold
into the radius
Sealant
INCORRECT CORRECT

Page 11
Dwg:
Date:
The New & Improved AllianceLok 16 Roof Systems Installation Guide
June 2015
5.0 ROOF INSTALLATION BASICS
5.4 Fasteners (Continued)
Most self-drilling screws require 20 pounds of pressure to
maintain the drilling action and to start the thread cutting
action. Also, applying such pressure before starting the
Screw Gun will usually prevent tip walking or wandering.
If too little pressure is applied, the drill point may not cut
into the metal and the point will heat up and become dull.
If the pressure is too heavy, the bottom material may be
deected away, causing a standoff condition, or the drill tip
may be broken or split.
Screws must be held perpendicular to the panel or trim
surface during starting and driving.
For proper seating of the fastener-sealing washer, the panel
or trim surface must be clean and drill shavings must be
removed from under washers before seating. The fastener
must be driven perpendicular to the panel surface so that
the washer can seat level without warping or cupping.
Do not over drive screws. Over driving can strip the threads
and/or damage the sealing washer. Use Screw Gun with
torque control set to function properly for the combination
of fastener size, hole size and material thickness.
The fastener should be driven tight enough to uniformly
compress the washer but not so tight that the washer splits
or rolls out from under it’s metal dome. The recommended
procedure is to tighten the fastener until the sealing washer
just starts to visually bulge from under the metal dome.
As a good installation practice, all roof installers should
carry approved oversized screws. Upon stripping or
breaking a screw, the screw must be immediately removed
and replaced with the appropriate oversized screw. Do not
defer the screw replacement to be remembered and xed
later, or to be found by the clean-up crew. The majority of
such screws will be overlooked until the customer complains
of leakage.
5.5 Field Cutting Panels and Trim
A. ABRASIVE SAW PROBLEMS
Abrasive Saws (circular saws with friction disks) are not
recommended for cutting Roof Panels or trim. Abrasive
Saws create high heat that may burn away the protective
cladding from the panel edge, causing the edge to rust.
Also, Abrasive Saw dust contains ne, hot steel particles,
which accumulate on panel and trim surfaces where they
rust and can cause staining and rusting of those surfaces.
Rust caused by Abrasive Saw damage or abrasive dust
particles may be excluded from warranty claims.
B. SHEARING METHODS
It is recommended that panels and trim be cut with Shears
to provide a clean, undamaged cut. On shear cut edges,
the protective cladding extends to the edge of the cut and
is often wiped over the edge to further protect the base
metal.
Whenever possible, t the material so that the factory cut
edge is exposed and the eld cut edge is covered.
When eld cutting complex shapes, it is usually easier to
cut out a 1” wide strip using both left and right hand Shears.
The 1” cutout provides clearance to smoothly cut the ats
and the clearance to work the Shears around tight corners.
When making repetitive cuts (such as cutting panels at a
hip condition) it is recommended that a template be made
from a piece of drop-off panel or trim to provide fast and
accurate marking of the eld cut. When using panel material
for the template, cut off the top portion of the panel ribs so
that the template is easily laid onto the panel being marked.
C. MARKING PANELS
Avoid marking the panels for cutting, etc., in a manner that
will leave visible markings and stains, etc., on the nished
roof surface. Use chalk or felt tip ink markers. Do not use
graphite (lead) pencils on unpainted panel surfaces, the
graphite can cause rusting of the surface.
ROOF INSTALLATION BASICS

Page 12
Dwg:
Date:
The New & Improved AllianceLok 16 Roof Systems Installation Guide
June 2015
Caution: Failure to maintain panel coverage width within
the specied tolerance can cause faulty Roof Panel seams
which can result in seaming difculty or in severe cases
reduction in roof performance specications.
For proper t-up between the panel, sealant and closures or
endlap parts, the panels must be held to the width dimension
of the panel, as designated on the Erection Drawings, within
a 1/16” width tolerance per panel.
The accumulated coverage (start panel to nish panel)
tolerance is determined by the ability to keep the panels
parallel and to correctly t and assemble the nish rake
condition.
If the roof has conditions such as xed location penetrations,
parapets, re walls, etc., the accumulated panel coverage
may require tighter tolerances for proper t-up and weather
tightness of the roof system.
6.0 ROOF PANEL LAYOUT
6.1 Sheeting Direction and Modularity
Although the AllianceLok 16 Roof System is designed
so it can be installed in either direction (left to right or
right to left), there may be roof conditions which require a
specic sheeting direction. Check the Erection Drawings to
determine if a specic sheeting direction is required.
Panels with factory swagged ends must be installed with
the swag at the downslope end. Swagged panels can only
be installed in the left to right direction.
The recommended installation sequence is to complete
each panel run from eave to ridge before starting the next
panel run. This sequence will help ensure straight runs
and allow the insulation to be installed immediately ahead
of each panel run.
During installation of the roof, considerations must be
made for maintaining panel modularity. By maintaining
panel modularity, the Roof Panel sidelap and seam can
be properly assembled, the proper roof coverage can be
obtained and the standard perimeter parts will t properly
without necessity of eld modications or reordering of
parts, etc.
6.2 Layout & Checking for Coverage
Recommended for all roofs, but a must for large or
complex roofs, is to make a layout of the actual structure
(eld measured as described in section 3.3) so that the
Roof Panel start and stop dimensions can be laid out to
accommodate any structural misalignments.
When the optimal start and finish dimensions are
determined, a string line should be set to precisely locate
the leading edge of the start panel. After the start panel is
secured and engaged with the next panel, the start panel
seam will be the reference line for checking accumulated
panel coverage.
Panel coverage is always checked at the eave, ridge,
and end splices so that non-parallel seam (or dogleg)
conditions can be detected and corrected before they
become objectionable. The coverage check should be done
with a Measuring Tape held taut and measured to the same
side of the seam and always parallel to the eave to prevent
any measuring error.
Every four to six panel runs should be checked for panel
modularity. This will assure that the panels are maintaining
a straight line and proper coverage is being maintained.
If the panels are off module, they should be corrected by
equal adjustments of the next four to six panel runs.
6.3 Appearance Considerations
Although the above stated coverage tolerance will provide
for reasonable ease of installation and water tightness,
such visible conditions as non-parallel panel seams, dogleg
of the panel seam at the end splices, non-parallel nish
panel width, and mismatch of panel seams across the
ridge, may be objectionable and should be conrmed with
the customer before continuing roof installation.
ROOF PANEL LAYOUT

Page 13
Dwg:
Date:
The New & Improved AllianceLok 16 Roof Systems Installation Guide
June 2015
7.0 INSPECTION OF ROOF ASSEMBLY DURING INSTALLATION
7.1 Importance of Inspection
During the roof installation, all areas of the roof system
assembly must be frequently inspected to ensure the
correct assembly in accordance with the Erection Drawings
and this Installation Guide.
Failure to assemble the roof system correctly will result
in roof performance problems that may require costly
corrective work, roof replacement, and performance and
damage claims etc. Also, incorrect installation may void
the performance and material warranties.
7.2 Inspection List
A. ERECTION DRAWINGS
Check that the Erection Drawings are available at the job
site and have been reviewed for difference with the actual
job conditions and differences with the Installation Guide.
Also, conrm that the drawings are the latest issue with
the latest revisions and additions. Drawings will be labeled
Erection Set.
B. ROOF LAYOUTS
Check that the roof start and nish dimensions have been
correctly determined based on the Erection Drawings and
the actual structural conditions.
C. BEFORE INSTALLING ROOF PANELS
Check that the structural misalingments were corrected in
accordance with Section 3.0 of this Installation Guide.
Check that the correct Eave and Rake Plates and Eave
Trim are in place before installing the Roof Panels.
Check that the Roof Panel elevation provided by the panel
clip height and insulation system matches the Eave and
Rake Plate elevation.
D. PANEL LENGTH
Check that the installed Roof Panels have the correct
overhang at the eave and endlaps and have the correct
hold back at the ridge or high eave in accordance with the
Erection Drawings.
E. EAVE SEAL
Check that the Tape Sealant is in the correct position on
top of the Eave Trim and that the Eave Pigtail Sealants are
correctly placed. Check that the Roof Fasteners penetrate
the center of the Tape Sealant and into the Eave Plate.
Check that the fasteners are not loose or stripped.
Check that the Tape Sealant is in complete contact with
the Roof Panel and Eave Trim without any voids or gaps.
Conrm that the Roof Panel and Eave Trim are clean and
dry during installation and that the sealant is not wet or
otherwise contaminated.
F. ENDLAP SEAL
Check that the Roof Panel endlaps are correctly
assembled and that the lapping panels are tightly nested
without visible gaps.
Check that the sealant is in the correct position and is in
complete contact with the lapped panels without any voids
or gaps, especially at the radius between the panel at and
the vertical legs of the panel. Conrm that the panels are
clean and dry during installation and that the sealant is not
wet or otherwise contaminated.
Check that the Pigtail Sealant is in the correct position and
seals the endlap seam notches.
Check that the Cinch Strap fasteners (Endlap Fasteners)
penetrate through the center of the sealant and into the
Back-Up Plate. Check that the fasteners are not loose
or stripped.
Check that the panel surfaces above and below the endlap
are not bowed down causing water ponding and debris
accumulations.
G. RIDGE SEAL
Check that the End Dams are correctly assembled.
Check that the sealant is in the correct position and is in
complete contact with the End Dam and the Roof Panel
without any voids or gaps. Conrm that the End Dam and
Roof Panels are clean and dry during installation and the
sealant is not wet or contaminated.
Check that the End Dam fasteners (Endlap Fasteners)
penetrate through the center of the sealant and into the
Back-Up Plate. Check that the fasteners are not loose or
stripped.
Check that the Tube Sealant is installed along the back of
the End Dam as necessary to seal any voids around the
panel seam area.
INSPECTION OF ROOF ASSEMBLY

Page 14
Dwg:
Date:
The New & Improved AllianceLok 16 Roof Systems Installation Guide
June 2015
7.0 INSPECTION OF ROOF ASSEMBLY DURING INSTALLATION
7.2 Inspection List (Continued)
H. RAKE SEAL
Check that the Termination Zee is correctly assembled with
the splices correctly oriented for downhill watershed.
If there are Roof Panel endlaps, check that the Tape Sealant
at the endlap contacts the sealent at the Termination Zee
sealant or that a Pigtail Sealant is applied for that purpose.
Check that the sealant is in the correct position above the
Roof Panel.
Check that the Termination Zee sets fully on the sealant
and that the sealant is in complete contact with the Roof
Panel and the zee without any voids or gaps. Conrm that
the Roof Panel and zee are clean and dry during installation
and that the sealant was not wet or contaminated.
Check that the Termination Zee fasteners (Roof Fasteners)
penetrate the center of the sealant and into the Rake Plate.
Check that the fasteners are not loose or stripped.
I. PANEL CLIP ATTACHMENT
Check that the Panel Clips are correctly and tightly tted to
the panel without any distortion or damage of the clip tab.
On sliding clips, check that the clip tab is centered on the
clip base between the centering tabs.
Check that the clips are located along each panel sidelap
at each Roof Structural or at the locations specied on the
Erection Drawings.
Check that the Panel Clip Fasteners are of the type, size,
length, nish and quantity-per-clip as specied on the
Erection Drawings.
Check that the Panel Clip Fasteners are not loose or
stripped. In the case of multi-layered construction, verify
that the fasteners penetrated and engaged the specied
structural member.
J. SIDELAP
Check that the panel sidelaps are on module (held within
the 1/16” panel width tolerance) and are assembled so
that the male and female panel edges and Panel Clips are
properly nested together prior to seaming.
Check that the full length of each sidelap seam is correctly
seamed.
Check that the factory installed sidelap sealant is in the
correct position without voids or interruptions and is not
damaged, wet or otherwise contaminated.
Check that the accumulated coverage will allow proper t
and assembly of the End Dams and nish rake condition
and any other critical t conditions such as penetrations,
parapets, etc.
K. TRIM AND PENETRATIONS
Check that all trim (including penetrations) are correctly
assembled and tightly fitted. Check that the required
sealants are correctly positioned and in complete contact
with the adjoining surfaces without voids or interruptions.
Conrm that the sealants and adjoining surfaces are clean
and dry during installation.
Check that the trim splices are correctly lapped, sealed
and fastened.
Check that the trim is sufciently pitched to shed water and
eliminate ponding areas, especially at the critical splices,
endlaps and corners.
Check that the fasteners are of the specied type, size,
length, nish and spacing. Check that the fasteners are
not loose or stripped. Check that the sealing washers are
in full contact with the trim surface and not distorted, split
or otherwise damaged.
Along the rakes, high eave transitions, xed penetrations,
etc., check that the trim is not constrained and will allow
for the roof’s expansion/contraction movement.
L. SURFACE CONDITIONS
Damaged roof system surfaces are subject to corrosion
and performance problems and may void the material and
performance warranties.
Check that the panel and trim surfaces are not being
subjected to abusive conditions such as careless handling
of panels and trim, excessive roof traffic, abrasive or
contaminated footwear, rough handling of materials, tools
and equipment, contact with abrasive materials or residue,
etc.
INSPECTION OF ROOF ASSEMBLY

Page 15
Dwg:
Date:
The New & Improved AllianceLok 16 Roof Systems Installation Guide
June 2015
7.0 INSPECTION OF ROOF ASSEMBLY DURING INSTALLATION
7.2 Inspection List (Continued)
Check that the panel and trim surfaces are not being
subjected to exposed metal objects and materials left on
the roof such as tools, material drop-off, fasteners, wire,
staples, drill and nibbler chips, saw and le particles, etc.
In the process of rusting, these materials will absorb the
panel’s protective coating thus leaving the panels exposed
to rusting.
Check that the panels and trim are not being subjected to
long term wet conditions such as standing water, consistent
sources of steam, mist, spray, dripping or runoff, wet debris,
wet insulation or other moisture holding material.
Check that the panels and trim are not subjected to direct
contact or runoff from corrosive materials such as copper
pipes and trim, uncured cement, treated lumber anti-icing
chemicals, strong solvents or other corrosive materials.
Check that Graphite Pencils were not used to mark on
unpainted surfaces. The graphite marks can cause rusting.
Check that the roof materials are not subjected to damaging
heat such as Cutting Torches, Abrasive Saws, etc.
M. UNSPECIFIED MATERIALS
Use of the wrong materials may cause installation and
performance problems and may void the performance and
material warranties.
Check that all installed roof system materials, especially
sealants and fasteners, are only those which are provided
or specied by Alliance for your specic project and are
used only as specied on the Erection Drawings and this
Installation Guide.
Alliance cannot be responsible for the performance of roof
materials that are not provided, specied or approved by
Alliance.
N. WARRANTY CONSIDERATIONS
If Alliance is to provide a weather tightness warranty for
your project Alliance requires that the Roof Curbs be pre-
approved by Alliance.All Roof Curbs should be compatible
with the Roof Panel. The Roof Curbs should have male and
female side ribs and water diverters at the upslope side of
the Roof Curb. Contact Alliance for approved Roof Curb
manufacturers.
INSPECTION OF ROOF ASSEMBLY
All Pipe Penetration Covers must have sealant (by others)
between the top of the Rubber Boot and Vent Pipe. Secure
boot to pipe with Stainless Steel Draw Band (by others).

Page 16
Dwg:
Date:
The New & Improved AllianceLok 16 Roof Systems Installation Guide
June 2015
8.0 STANDARD PARTS
8.1 General
The following details provide a basic description and
graphic illustrations of the standard roof assembly parts.
The purpose of these details is to assist the erector in the
correct selection and identication of parts.
Because of the many variations in conditions, it is important
that you review the job conditions to identify the specic
parts required for your job.
Review the Erection Drawings for any special parts or parts
which are different from the standard parts shown in these
details. If differences exist, the Erection Drawings take
preference.
For proper t-up, sealing and fastening, and to help ensure
the roof assembly’s weathertightness, structural capability,
durability and appearance, the correct parts must be used.
Do not use parts other than those specied on the
Erection Drawings.
STANDARD PARTS

Page 17
Dwg:
Date:
The New & Improved AllianceLok 16 Roof Systems Installation Guide
June 2015
16”
2”
15 3/4”
8.0 STANDARD PARTS
TERMINATION ZEE
• 24 gauge Steel
• Painted or Galvalume Finish
• 10’ - 2” length
Part No. TZ-100A (Specify nish)
ROOF PANEL (16” wide panel)
• 24 gauge Steel
• Painted or Galvalume Finish
• Flat, striated, or beaded pan
• Factory notched for endlap
• Factory punched holes
Part No. AL-16
(Specify nish, pan pattern & length)
END DAM (for 16” wide panel)
• 24 gauge Steel
• Painted or Galvalume Finish
• Factory punched holes
Part No. ED-216 (Specify nish)
8.2.1 ROOF PANELS, CLOSURES & CHANNEL
BACK-UP CHANNEL
• 16 gauge Galvanized Steel
Part No. BP-172
16”
2”
72”
5/16”
3”
1 1/4”
1 1/4”
2”

Page 18
Dwg:
Date:
The New & Improved AllianceLok 16 Roof Systems Installation Guide
June 2015
3 3/8”
4 5/16”
Base
Tab
2 3/8”
4 5/16”
Base
Tab
3 3/8”
3 1/4”
CINCH STRAP (for 16” wide panel)
• 18 gauge Stainless Steel
• Factory punched holes
Part No. CS-116
8.0 STANDARD PARTS
FIXED CLIP (for 0” stand-off)
• 20 ga. Galvanized Steel
Part No. FC 10200
FLOATING CLIP (for 3/8” stand-off)
• 20 ga. Galvanized Steel, Tab
• 16 ga. Galvanized Steel, Base
Part No. MC 1203
FIXED CLIP (for 3/8” stand-off)
• 20 ga. Galvanized Steel
Part No. FC 10203
FLOATING CLIP (for 1 3/8” stand-off)
• 20 ga. Galvanized Steel, Tab
• 16 ga. Galvanized Steel, Base
Part No. MC 1213
FIXED CLIP (for 1 3/8” stand-off)
• 20 ga. Galvanized Steel
Part No. FC 10213
8.2.2 PANEL CLIPS & CINCH STRAP
2”
3 1/4”
2 3/8”
3 1/4”
15 3/4”
1 1/4”

Page 19
Dwg:
Date:
The New & Improved AllianceLok 16 Roof Systems Installation Guide
June 2015
FLOATING EAVE/RAKE PLATE (for 3/8” stand-off)
• 16 gauge, 50 ksi Galv.
• 10’-0” length
• Factory punched slots
Part No. E/RP100
FLOATING EAVE/RAKE PLATE (for 1 3/8” stand-off)
• 16 gauge, 50 ksi Galv.
• 10’-0” length
• Factory punched slots
Part No. E/RP200
8.0 STANDARD PARTS
8.2.3 EAVE/RAKE PLATES, TAPE SEALANT
& RIVETS
BLIND RIVET (for Trim joints)
• Aluminum
• 1/8” dia. x 3/16” length
Part No. BR1
Head
Rivet Body
Mandrel
Part No. LS-100
TAPE SEALANT (for Trim & End Dams)
• 3/16” x 7/8” Butyl Tape Sealant
• 40’ roll
POP RIVET (for use at Hip/Valley with low clip)
• Steel
• 3/16” dia. x 3/8” length
Part No. PR1
Head
Rivet Body
Mandrel
Part No. LS-200
ENDLAP TAPE SEALANT (for panel end
laps)
• 5/32” x 1 1/4” Butyl Tape Sealant
• 30’ roll
7/8”
3/16”
Protective Backing
(Release Paper)
Sealant
1 1/4”
5/32”
Protective Backing
(Release Paper)
Sealant
1 7/16”
1 3/8”
1 1/16”
3/8”
1 13/16”
1 13/16”
Table of contents
Popular Air Conditioner manuals by other brands

Carrier
Carrier 38AU 16 Series Installation, Start-Up and Service Instructions

Samsung
Samsung AVXC1 series installation manual

Mitsubishi Electric
Mitsubishi Electric city multi PLFY-P-VCM-E2 installation manual

Insignia
Insignia NS-AC14PWH8 user guide

Saunier Duval
Saunier Duval SDH 31-026 NW installation manual

YMGI
YMGI M2 SERIES Installation instruction
