XIA UltraLo-1800 Operating instructions

XIALLC
UltraLo‐1800Alpha
ParticleCounter
SiteRequirements&Planning
Version:0.4
Friday,February15,2013

UltraLo‐1800AlphaParticleCounterXIALLCPage2
TableofContents
I.SitePreparationTasks...........................................................................................................................3
A.InstrumentOverview........................................................................................................................3
B.InstallationOverview........................................................................................................................3
1.Sitepreparationprocess...............................................................................................................3
C.Selectthesite....................................................................................................................................3
1.Spacerequirements......................................................................................................................3
2.Gasrequirements..........................................................................................................................5
3.Layoutrequirements.....................................................................................................................6
4.Requiredclearances......................................................................................................................7
5.Mountingholelocations...............................................................................................................8
6.Dimensionsandweights...............................................................................................................9
7.Electricalrequirements...............................................................................................................10
D.Prepareforinstallation...................................................................................................................11
1.Safetyandmaterials...................................................................................................................11
E.Receivingandinspectingthesystem..............................................................................................12
1.ShippedContents........................................................................................................................12
2.Inspectshippingcontainersfordamage.....................................................................................12
3.Shippingcontainerdimensions...................................................................................................12
II.Checklists............................................................................................................................................13
A.SpaceandLayoutchecklist.............................................................................................................13
B.Gaschecklist....................................................................................................................................13
C.Electricalchecklist...........................................................................................................................13
D.Systemreceiptandinspection........................................................................................................14

UltraLo‐1800AlphaParticleCounterXIALLCPage3
B
C
A
I. SitePreparationTasks
A. InstrumentOverview
TheUltraLo‐1800isastate‐of‐the‐artalphaparticlecountingsystemthatusesagas‐filledionization
chamberandpulseshapeanalysistoachievethelowestpossiblebackgroundsandshortestpossible
countingtimes.
Theinstrumentistobeusedonlybytechnologiststrainedbothinlaboratorytechniquesand
procedures,andintheuseoftheinstrument.Thecustomerisresponsibleforvalidationofanyresults,
andcompliancewithanyrequirementsthatpertaintotheirproceduresandusesoftheinstrument.
B. InstallationOverview
Beforethesystemarrivesatyourlocation,pleaseprepareyoursitefortheinstallationprocess
accordingtotheinstructionsthatfollow.IfanXIALLCrepresentativewillbepresenttohelpinstallthe
instrumentandassociateddevices,yoursitemustbepreparedpriortotheirarrival.
1. Sitepreparationprocess
1. Reviewthisguide
2. Selecttheinstallationsite
3. Meetrequirements(gas,electrical,network)
4. Stockthesite
5. Receiveandinspectthesystem(shipment)
6. Movesystemtoinstallationsite
C. Selectthesite
1. Spacerequirements
a) Systemcomponents
Theshipmentincludesthefollowingcomponents:
A. Countermodule
B. Supportmodule
C. ThinkPadcontrollaptop
D. CablesandTubing(notshown)

UltraLo‐1800AlphaParticleCounterXIALLCPage4
b) Setuprequirements

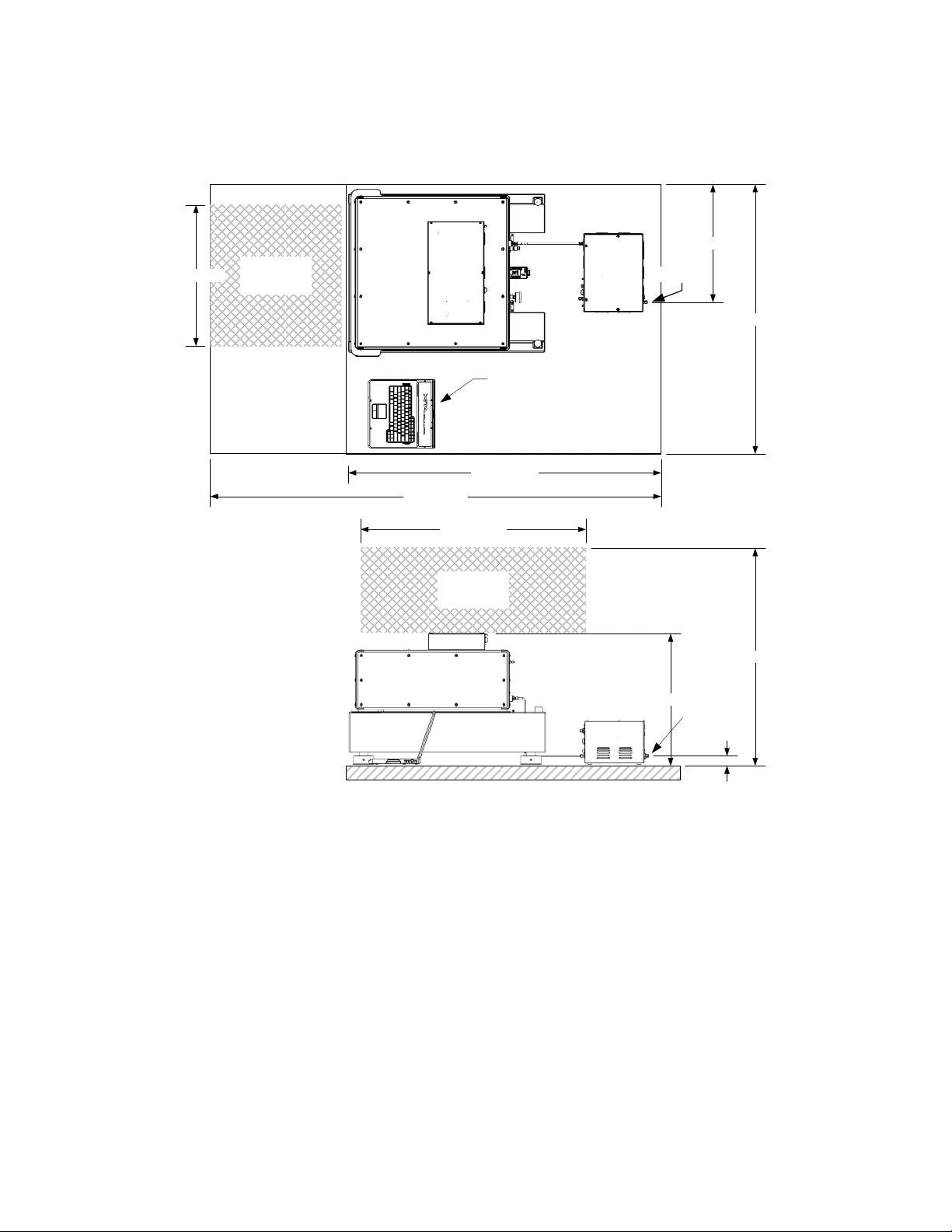

AtypicalsetupisshownbelowinFigure1.
60.0 (152 cm)
27.0 (69 cm)
95.0 (241 cm)
65.0 (165 cm)
Req’d
Clearance
Laptop can be placed
elsewhere, but must be
within 6 feet (1.8m) of
counter.
Req’d
Clearance
46.0 (117 cm)
Gas Inlet
24.0 (61 cm)
1.8 (4.6 cm)
Gas Inlet
50.0 (127 cm)
26.0 (66 cm)
Figure1:SpaceRequirements
Fordetailsonspacerequirements,see‘Dimensionsandweights’onpage8.Foradditional
informationonnecessaryclearances,see‘Requiredclearances’onpage7.Fordetailsonthelocationof
thegasinlet(andassociatedtolerance),see‘GasInletLocation’onpage5.

UltraLo‐1800AlphaParticleCounterXIALLCPage5
2. Gasrequirements
TheUltraLo‐1800requiresasourceofpure,dryArgongas–ideally,thegasprovidedisboilofffrom
atankofliquidArgon.Allmetaltubing(i.e.copperorstainless)shouldbeusedwhenrunningthegas
fromthesourcetanktotheUltraLo‐1800,andtheplumbingsystemshouldbefreefromleaks.Thegas
pressureattheinputtotheUltraLo‐1800isrequiredtobe21psi(150kPa)±5%.
ThegasinputfittingontheUltraLo‐1800isaSwagelok‐typeconnector:P/NSS‐400‐61,andrequires
¼”ODmetaltubing.AllnecessaryfittinghardwareissuppliedwiththeUltraLo‐1800system.The
installationprocessforthegastubeandfittingisstraightforward.IfanXIALLCrepresentativeispresent
duringsysteminstallation,theywillperformthisinstallationstep.
Figure2:GasInputInterface(Imagefromswagelok.com)
a) GasInletLocation
ThelocationofthegasinputfittingiscalledoutinFigure1.Priortothescheduleddateof
installation,thegastubingmustberunfromthegassourcetothesiteofinstallation,andterminateat
thespecifiedgasinletlocation.Theterminationofthe¼”metaltube(atthegasinletlocation)shallbe
runinsuchamannerastoprovideapproximately10”ofplay(inalldirections)forfinalalignmentduring
systeminstallation.
b) Summary:
Requirement(atinputtoUltraLo)Specification
GasArgon
Pressure21psi(150kPa)±5%
Tubing1/4"ODmetaltube
LocationAscalledoutinFigure1,±10”alldirections
c) Gassupplyandconsumption:
OurrecommendationistouseadewarofliquidArgon,andplumbtheboiloffgastothecounter.In
regardstogasconsumption,theUltraLo‐1800hastwodefinedflowrates;‘normal’(3.5LPM)and
‘purge’(15LPM).Whenyouinsertanewsample,thesystemrunsatthepurgerateforabout45
minutes,afterwhichtheflowisautomaticallythrottleddowntothenormalrateforthemeasurement.
Yourgasconsumptionwilldependonhowmanytimesyouinsertnewsamples.Forreference,the
countersatXIArunoffof230literliquiddewars.Onecounterrunningdailymeasurements(averagingat
least1purge/day)willconsumethedewarinabitovertwoweeks.
