BAC S1500E Quick start guide

S1500E Open Cooling Towers
XES1500E Open Cooling Tower
RIGGING AND INSTALLATION INSTRUCTIONS
RS1500Ev02EN

About Rigging and Installation
The BAC equipment should be rigged and installed as outlined in this bulletin.
These procedures should be thoroughly reviewed prior to the rigging and operation to acquaint all personnel with
the procedures to be followed and to assure that all necessary equipment will be available at the jobsite.
Be sure to have a copy of the unit certified drawing available for reference. If you do not have a copy of this drawing
or if you need additional information about this unit, contact the local BAC Balticare representative. His name and
phone number can be found on the BAC website: www.BaltimoreAircoil.eu. The model type and serial number of
your equipment are indicated on the unit nameplate.
Recommended Maintenance and
Monitoring Programme
Checks and Adjustments Start-Up Weekly Monthly Quarterly Every 6
Months
Annually Shutdown
Hot water basin X X
Nozzles X X
Cold Water Basin and Basin Strainers X X
Operating level and make-up X X
Blow down X X
Sump heater Package X X
Belt tension X X
Drive alignment X X
Drive System X X
Locking Collar X
Rotation of fan(s) and pump(s) X
Motor voltage and current X X
Unusual noise and/or vibration X X
Inspections and Monitoring Start-
Up
Weekly Monthly Quarterly Every 6
Months
Annually Shutdown
General condition X X
Heat transfer section and drift eliminators X X
Combined Inlet Shields X X
Hot Water Basin X X
Spray Nozzles X X
Fan shaft & Axial Fan X X
Fan Motor X X
Electric Water Level Control Package (option) X X
TAB test (dip slides) X X
Circulating water quality X X
W W W . B A L T I M O R E A I R C O I L . E U
2

Inspections and Monitoring Start-
Up
Weekly Monthly Quarterly Every 6
Months
Annually Shutdown
System overview X X
Recordkeeping as per event
Lubrication Start-Up Weekly Monthly Quarterly Every 6
Months
Annually Shutdown
Fan shaft bearings X X X
Motor bearings* X X
Adjustable motor base X X X
* only for motors with grease fittings with typical frame size > 200L (>30 kW)
Cleaning procedures Start-Up Weekly Monthly Quarterly Every 6
Months
Annually Shutdown
Mechanical cleaning X X X
Disinfection** (X) (X) (X)
Drain Basin X
** depends on applied code of practice
Notes
1. Water Treatment and auxiliary equipment integrated in the cooling system may require additions to the table
above. Contact suppliers for recommended actions and their required frequency.
2. Recommended service intervals are for typical installations. Different environmental conditions may dictate
more frequent servicing.
3. When operating in ambient temperatures below freezing, the unit should be inspected more frequently (see
Cold Weather Operations in the appropriate Operating and Maintenance Instructions).
4. For units with Belt Drive, tension on new belts must be readjusted after the first 24 hours of operation and
monthly thereafter.
W W W . B A L T I M O R E A I R C O I L . E U
3

Table of Contents
RIGGING AND INSTALLATION INSTRUCTIONS
1 General Information 5
About Engineering and Application Practices 5
Shipping 5
Inspection Before Rigging 5
Unit Weights 7
Anchoring 7
Leveling 7
Connecting Pipework 7
Freeze Protection 8
Bleed Line Installation 8
Safety Precautions 8
Non-walking Surfaces 9
Modifications by others 10
Warranty 10
2 Rigging 11
General Notes 11
Rigging Information 11
Rigging Method for Upper Section & fully Assembled Unit 13
Rigging Method for Lower Section 13
Rigging Method for Single Piece Lift 14
3 Section Assembly 16
Method for Two-Piece Cells 16
4 Optional Accessories Assembly 18
General 18
Clean Out Port 18
5 Inspection Prior to Start-up 20
General 20
6 Further Assistance & Information 21
Balticare 21
More Information 21
W W W . B A L T I M O R E A I R C O I L . E U
4

1 General Information
1 General Information W W W . B A L T I M O R E A I R C O I L . E U
5
GENERAL INFORMATION
About Engineering and Application Practices
This bulletin only refers to the assembly of the unit. To ensure a proper operation, a correct integration of the unit in
the overall installation is mandatory. For good engineering and application practices on layout, levelling,
connecting pipework, etc., please refer to our website:
http://www.baltimoreaircoil.eu/knowledge-center/application-information.
Shipping
BAC cooling equipment is factory assembled to assure uniform quality and minimum field assembly.
The models S15E/XES15E-0809-06x, S15E/XES15E-0812-06x, S15E/XES15E-1012-06x, S15E/XES15E-1212-
07x and S15E/XES15E-1218-07x are shipped in one single section. All other S15E models are shipped in two
sections (upper and lower) due to shipping height restrictions.
For the dimensions and weights of a specific unit or section, refer to the certified drawing.
Caution
DO NOT COVER UNITS WITH PVC ELIMINATORS OR FILL WITH A PLASTIC TARPAULIN.
TEMPERATURE INCREASE DUE TO SUN RADIATION COULD DEFORM THE FILL OR
ELIMINATORS.
Inspection Before Rigging
When the unit is delivered to the jobsite, it should be checked thoroughly to ensure all required items have been
received and are free of any shipping damage prior to signing the bill of lading.
The following parts should be inspected:
• Sheaves and belts
• Bearings
• Bearing supports
• Fan motor(s)
• Fan Guards
• Fan(s) and fan shaft(s)
• Wet Deck Surface with integral drift eleminators
• Water distribution system
• Strainers
• Float valve assembly
• Combined Inlet Shields
• Interior / exterior surfaces
S1500E
XES1500E
1

• Mating surfaces between sections / modules
• Miscellaneous items
An envelope with check-list is stored in a wooden no nail crate or a plastic container which is placed in the lower
section. For safety reasons, access doors / panels may be sealed with bolts. The following table specifies which
wrench is required to open them.
Wrench to open access door
17 mm
Required wrenches to open access door
The wooden no nail crate / plastic container also contains miscellaneous parts such as gasket, hardware and
accessory items.
At temperatures below -10°C the butyl sealer tape might loose it's flexibility. We recommend to store the sealer
tape in a heated room before using it during rigging at freezing temperatures.
Caution
BE SURE TO REMOVE ALL MISCELLANEOUS ITEMS FROM THE PAN BEFORE THE UNIT IS
ASSEMBLED.
The hardware is packed in a plastic container and located inside the lower section of the unit.
The plastic container is fixed with straps to the overflow connection behind the combined inlet shields (CIS).
Hardware Location
If the unit is equipped with an internal platform, the plastic container is fixed to the ladder of this platform
W W W . B A L T I M O R E A I R C O I L . E U
6

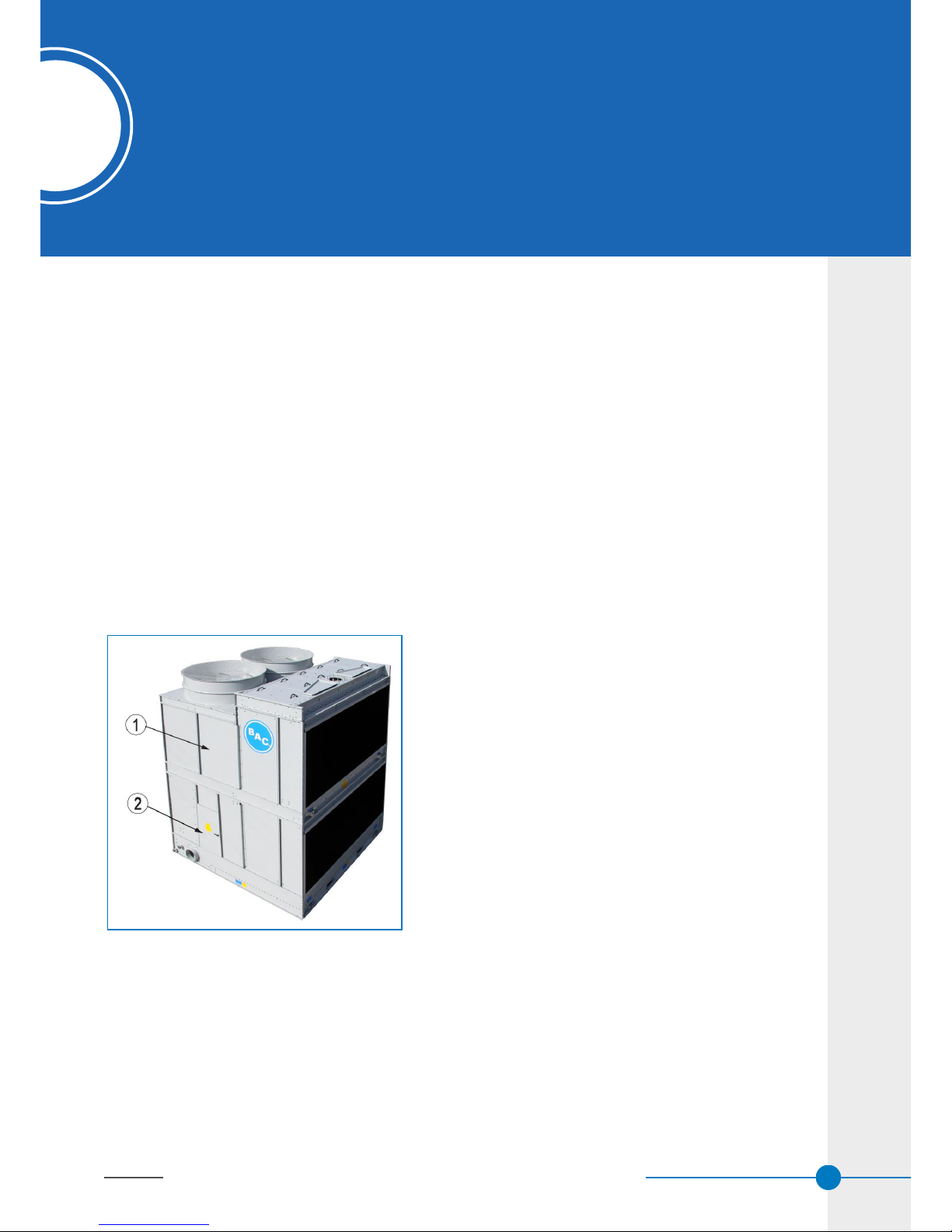

Hardware Location for unit with internal platform
Unit Weights
Before rigging any BAC equipment, the weight of each section should be verified on the unit certified drawing.
These weights are approximate and should be confirmed by weighing before lifting when available
hoisting capacity provides little margin for safety.
Caution
BEFORE AN ACTUAL LIFT IS UNDERTAKEN, ENSURE NO WATER, SNOW, ICE OR DEBRIS
HAS COLLECTED IN THE SUMP OR ELSEWHEREIN THE UNIT. SUCH ACCUMULATIONS WILL
ADD SUBSTANTIALLY TO THE EQUIPMENT’S LIFTING WEIGHT.
In the event of extended lifts or where hazards exist, the lifting devices should be used in conjunction with safety
slings placed under the unit.
Anchoring
The unit must be properly anchored in place.
Refer to the suggested support details on the certified drawing for locations of the mounting holes. Anchor bolts
must be provided by others.
Holes suitable for 20 mm bolts are provided in the bottom flange of the lower section for bolting the unit to the
support beams.
Leveling
The unit must be level for proper operation and ease of piping.
Support beams must also be level as shims should not be used between pan and support beams to level the unit.
Connecting Pipework
All piping external to BAC cooling equipment must be supported separately.
W W W . B A L T I M O R E A I R C O I L . E U
7
1 General Information
1 General Information

In case the equipment is installed on vibration rails or springs, the piping must contain compensators to eliminate
vibrations carried through the external pipework.
Suction pipe sizing should be done according to good practice, which may for larger flows require larger pipe
diameters than the outlet connection. In such cases adapter pieces need to be installed.
Freeze Protection
These products must be protected against damage and/or reduced effectiveness due to possible freeze-up by
mechanical and operational methods. Please refer to the BAC Product & Application Handbook or contact your
local BAC Balticare representative for recommended protection alternatives.
Bleed Line Installation
On all open cooling towers, install a bleed line with valve between the system circulating pump discharge riser and
a convenient drain. Locate the bleed line in a portion of the riser piping that drains when the pump is off.
The bleed valve should always be open when the unit is in operation, unless the bleed rate is automatically
controlled by a water treatment system.
Safety Precautions
All electrical, mechanical and rotating machinery constitutes a potential hazard, particularly for those not familiar
with its design, construction and operation. Accordingly, adequate safeguards (including use of protective
enclosures where necessary) should be taken with this equipment both to safeguard the public (including minors)
from injury and to prevent damage to the equipment, its associated system and the premises.
If there is doubt about safe and proper rigging, installation, operation or maintenance procedures, contact the
equipment manufacturer or his representative for advice.
When working on operating equipment, be aware that some parts may have an elevated temperature. Any
operations on elevated level have to be executed with extra care to prevent accidents.
AUTHORIZED PERSONNEL
The operation, maintenance and repair of this equipment should be undertaken only by personnel authorized and
qualified to do so. All such personnel should be thoroughly familiar with the equipment, the associated systems
and controls and the procedures set forth in this and other relevant manuals. Proper care, personal protective
equipment, procedures and tools must be used in handling, lifting, installing, operating, maintaining and repairing
this equipment to prevent personal injury and/or property damage. Personnel must use personal protective
equipment where necessary (gloves, ear plugs, etc...)
MECHANICAL SAFETY
Mechanical safety of the equipment is in accordance with the requirements of the EU machinery directive.
Depending upon site conditions it also may be necessary to install items such as bottom screens, ladders, safety
cages, stairways, access platforms, handrails and toe boards for the safety and convenience of the authorized
service and maintenance personnel.
At no time this equipment should be operated without all fan screens, access panels and access doors in place.
When the equipment is operated with a variable fan speed control device, steps must be taken to avoid operating
at or near to the fan's «critical speed».
For more information consult your local BAC Balticare representative.
W W W . B A L T I M O R E A I R C O I L . E U
8

ELECTRICAL SAFETY
Each motor associated with this equipment should be installed with a lockable disconnect switch located within
sight of the equipment. No service work should be performed on or near the fans, motor, drives or inside the
equipment unless motors, heaters etc. are electrically isolated.
Each fan associated with this equipment should be installed with a lockable disconnect switch located within sight
of the equipment.No service work should be performed on or near the fans unless motors are electrically isolated.
LIFTING
Caution
FAILURE TO USE DESIGNATED LIFTING POINTS CAN RESULT IN A DROPPED LOAD
CAUSING SEVERE INJURY, DEATH AND/OR PROPERTY DAMAGE. LIFTS MUST BE
PERFORMED BY QUALIFIED RIGGERS FOLLOWING BAC PUBLISHED RIGGING
INSTRUCTIONS AND GENERALLY ACCEPTED LIFTING PRACTICES. THE USE OF
SUPPLEMENTAL SAFETY SLINGS MAY ALSO BE REQUIRED IF THE LIFT CIRCUMSTANCES
WARRANT ITS USE, AS DETERMINED BY THE RIGGING CONTRACTOR.
LOCATION
All cooling equipment should be located as far away as possible from occupied areas, open windows or air intakes
to buildings.
Caution
EACH UNIT SHOULD BE LOCATED AND POSITIONED TO PREVENT THE INTRODUCTION
OF DISCHARGE AIR INTO THE VENTILATION SYSTEMS OF THE BUILDING ON WHICH THE
UNIT IS LOCATED OR THOSE OF ADJACENT BUILDINGS.
For detailed recommendations on BAC equipment layout, please see the BAC Application Handbook EU-
Edition, the BAC website: www.baltimoreaircoil.eu or contact your local BAC-Balticare Representative.
LOCAL REGULATIONS
Installation and operation of cooling equipment may be subject to local regulations, such as establishment of risk
analysis. Ensure regulatory requirements are consistently met.
Non-walking Surfaces
Access to and maintenance of any component needs to be performed in accordance with all local applicable laws
and regulations. If the proper and required access means are not present, temporary structures need to be
foreseen. Under no circumstance can one use parts of the unit, that are not designed as an access mean, unless
measures can be taken to mitigate any risks that might occur from doing so.
W W W . B A L T I M O R E A I R C O I L . E U
9
1 General Information
1 General Information

Modifications by others
Whenever modifications or changes are made by others to the BAC equipment without written permission of BAC,
the party who has done the modification becomes responsible for all consequences of this change and BAC
declines all liability for the product.
Warranty
BAC will guarantee all products to be free from manufactured defects in materials and workmanship for a period of
12 months from the date of shipment. In the event of any such defect, BAC will repair or provide a replacement.
For more details, please refer to the Limitation of Warranties applicable to and in effect at the time of the
sale/purchase of these products. You can find these terms and conditions on the reverse side of your order
acknowledgement form and your invoice.
W W W . B A L T I M O R E A I R C O I L . E U
10

2 Rigging
2 Rigging W W W . B A L T I M O R E A I R C O I L . E U
11
RIGGING
General Notes
1. Units that ship in multiple sections can be assembled on the ground first before being lifted to their final
position. (see "Single Piece Lift" in the following table).
2. Spreader bars of the full width of the section must be used between the lifting cables to prevent damage to the
section.
3. For extended lifts or where hazards exist, it is recommended to use the lifting devices in conjunction with
safety slings placed under the unit.
4. The proper rigging sequence for units is to lift the lower section into place, apply sealer to the pan where the
upper section will be located (See "Section Assembly""Method for Two-Piece Cells" on page16) and then lift
the upper section into place.
5. Lifting devices have been provided on all sections. The tables below give the preferred method for rigging each
section of a unit.
Rigging Information
Unit sections
1. Upper Section
2. Lower Section
S1500E
XES1500E
2

Model
Number
N° of
lower
sections
N° of
upper
sections
Upper Section Lower Section Singl e Piece Lift
Rigging
Method
W1
(mm)
W2
(mm)
Min.
"H"
(mm)
Rigging
Method
W1
(mm)
W2
(mm)
Min.
"H"
(mm)
Rigging
Method
W1
(mm)
W2
(mm)
Min.
"H"
(mm)
S15E/XES15E-0809-06x FULLY
ASSEMBLED - - - - - - - - A 2400 1200 3400
S15E/XES15E-0812-06x FULLY
ASSEMBLED - - - - - - - - A 2400 1200 3400
S15E/XES15E-1012-06x FULLY
ASSEMBLED - - - - - - - - A 3000 1500 3400
S15E/XES15E-1012-09x 1 1 A 3000 1350 2700 B 3000 1500 2100 C 3000 1500 4600
S15E/XES15E-1012-10x 1 1 A 3000 1350 2700 B 3000 1500 2400 C 3000 1500 4900
S15E/XES15E-1018-09x 1 1 A 3000 1350 2700 B 3000 1500 2100 C 3000 1500 4600
S15E/XES15E-1018-10x 1 1 A 3000 1350 2700 B 3000 1500 2700 C 3000 1500 5200
S15E/XES15E-1212-07x
FULLY
ASSEMBLED - - - - - - A 3600 1800 3700
S15E/XES15E-1212-09x 1 1 A 3600 1800 2700 B 3600 1700 2100 C 3600 1800 4600
S15E/XES15E-1212-10x 1 1 A 3600 1800 2700 B 3600 1700 2400 C 3600 1800 4900
S15/SE3Z15E-1212-11x 1 1 A 3600 1800 2700 B 3600 1700 2700 C 3600 1800 5200
S15E/XES15E-1212-11x 1 1 A 3600 1800 2700 B 3600 1700 3400 C 3600 1800 5800
S15E/XES15E-1218-07x
FULLY
ASSEMBLED - - - - - - A 3600 1800 1800
S15E/XES15E-1218-09x 1 1 A 3600 1800 2700 B 3600 1700 2100 C 3600 1800 4600
S15E/XES15E-1218-10x 1 1 A 3600 1800 2700 B 3600 1700 2700 C 3600 1800 5200
S15E/XES15E-1218-11x 1 1 A 3600 1800 2700 B 3600 1700 3000 C 3600 1800 5500
S15E/XES15E-1218-12x 1 1 A 3600 1800 2700 B 3600 1700 3400 C 3600 1800 5800
Rigging Method
W W W . B A L T I M O R E A I R C O I L . E U
12

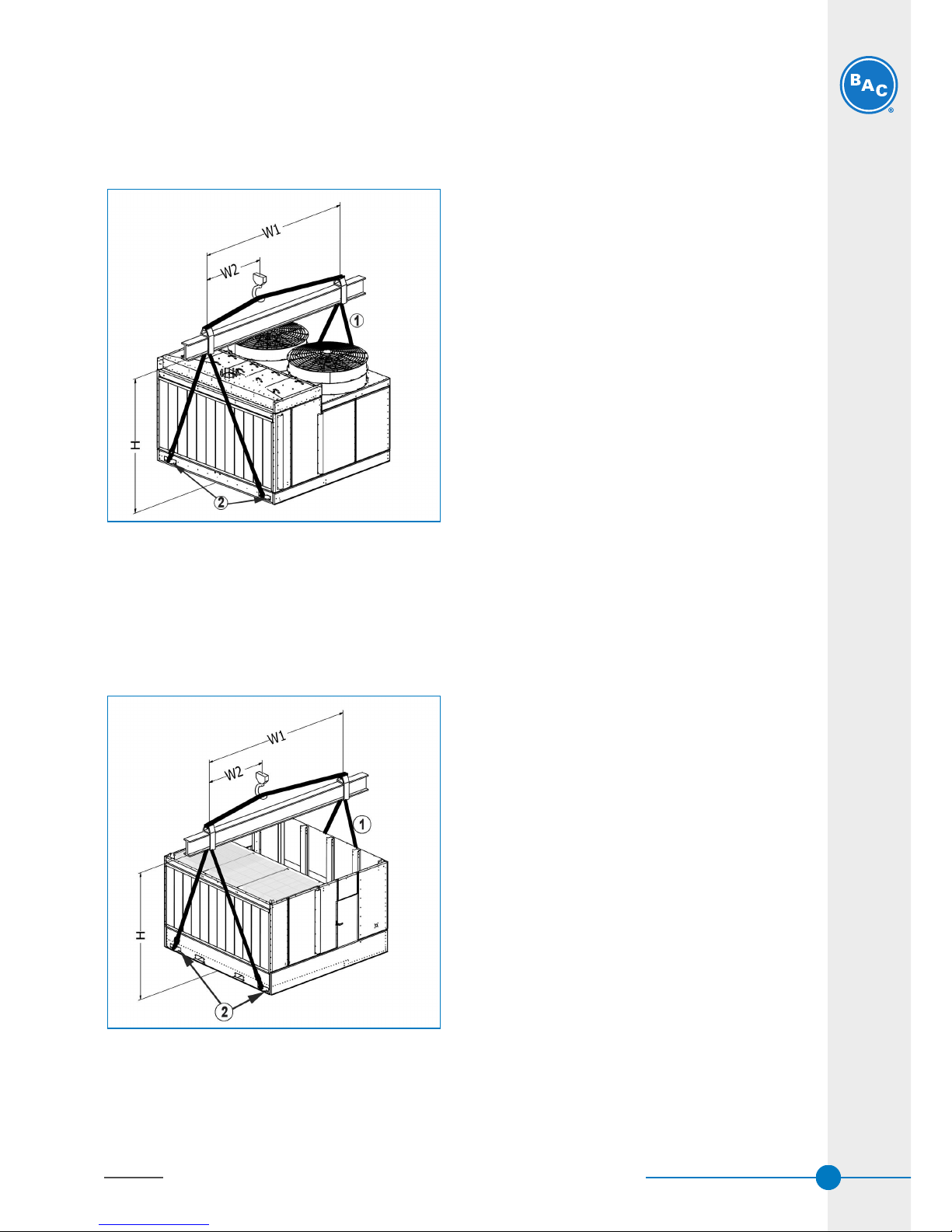

Rigging Method for Upper Section & fully Assembled
Unit
RIGGING METHOD A
1. Lifting cable
2. Lifting ears
Rigging Method for Lower Section
RIGGING METHOD B
1. Lifting cable
2. Lifting ears
W W W . B A L T I M O R E A I R C O I L . E U
13
2 Rigging
2 Rigging

Caution
DO NOT USE TIE DOWN BUCKLE FOR LIFTING AND LIFTING EARS FOR TIE DOWN
PURPOSE.
Rigging Method for Single Piece Lift
RIGGING METHOD C
1. Lifting cable
2. Lifting ears
Pay attention to the difference in lifting ear and tie down buckle on the lower section.
For units boxsize 08x09, 08x12, 10x12, 12x12 pay attnetin to the difference in lifting ear and tie down buckle on the
fan side of the unit (opposite to air intake).
The lifting ear is to be used to unload unit from truck. It is designed for upward force.
The tie-down buckle is only to be used to tie down (secure) unit onto truck for transport. It is designed for
downward force only.
W W W . B A L T I M O R E A I R C O I L . E U
14

Position tie down buckle and Lifting ear on lower section
1. Proper use of Tie down buckle is shown on logo
2. Proper use of Lifting ear is shown on logo
W W W . B A L T I M O R E A I R C O I L . E U
15
2 Rigging
2 Rigging

W W W . B A L T I M O R E A I R C O I L . E U
SECTION ASSEMBLY
Method for Two-Piece Cells
1. Position the lower section on the supporting steel and bolt in place.
2. Remove any protective wood from the top horizontal flanges of the lower section. Wipe down the flanges to
remove dust, dirt or moisture that may have accumulated during shipment and storage.
3. Install butyl sealer tape, supplied with the unit, on the mating flanges of the lower section in a continuous line
over the centre line of the tapper holes. At each corner, allow 2 to 3 cm overlap. Do not stretch sealer tape.
4. Sealer applied to the end flanges of a single cell section unit and to the end and centre flanges of two cell units
must be continuous.
Installation of tape sealer
1. Bolt M10
2. Flat tape sealer laid over punch line around unit perimeter
3. Flatwasher, lockwasher and nut
4. Section assembly guide
16
S1500E
XES1500E
3
3 Section Assembly
3 Section Assembly

5. Remove the skid from the middle section. Lift the middle section and position it over the lower section so that
the flanges of the section are about 50 mm above the lower section. Dot not let the section swing and damage
the sealer.
Use at least four drift pins (see figure) in the fastening holes located on the long sides of the sections to align
the top section to the bottom section. To avoid incorrect alignment, refer to the below drawing for the position of
the fastening holes to be used. Use additional drift pins in the middle of the unit if required, to align long panels.
(See Figure "Usage of drift pin to align the screw holes")
Make sure all holes from upper section and lower section are properly aligned before lowering the top section
completely to the bottom section.
Position of the fastening holes to be used.
1. Fastening hole
2. Drift pin position
3. The distance between the fastening hole in which the drift pin is inserted and the corner should be at least 30cm
4. Usage of additional drift pin for long sides
Caution
WHEN LOWERING A SECTION, ENSURE NOTHING CAN BE TRAPPED BETWEEN THE
UPPER AND LOWER FLANGES.
Usage of drift pin to align the screw holes
6. Using the bolts, drive bolts down through the upper section and into the lower section. Start next to lifting ear
towards centre of unit. Continue to install the bolts using the drift pin to align the holes until all holes are filled
with bolts.
W W W . B A L T I M O R E A I R C O I L . E U
17
3 Section Assembly
3 Section Assembly

W W W . B A L T I M O R E A I R C O I L . E U
OPTIONAL ACCESSORIES ASSEMBLY
General
1. All required installation instructions for optional accessories are stored in the wooden no nail crate / plastic
container which is placed in the lower section. See "Inspection Before Rigging" on page5- picture "Hardware
Location".
2. Refer to the unit certified drawing for installation sequence of optional accessories.
3. Sealing methods are the same as for the upper section.
4. The platform, ladder and railing is packed on a separate skid. The assembly hardware is packed in a plastic
container and strapped to the platform, ladder or railing itself.
Hardware Location for platform, ladder & railing
Clean Out Port
Due to transport width limits, the cover flanges of the clean out port are mounted with flanges towards the inside
(1). On site, the cover can be placed with flanges to the outside for easy access to hardware (2).
18
S1500E
XES1500E
4
4 Optional Accessories Assembly
4 Optional Accessories Assembly

Clean out port cover mounted for transport
Final installation of clean out port cover
W W W . B A L T I M O R E A I R C O I L . E U
19
4 Optional Accessories Assembly
4 Optional Accessories Assembly

W W W . B A L T I M O R E A I R C O I L . E U
INSPECTION PRIOR TO START-UP
General
Prior to start-up, the following services, which are described in detail in the Operating and Maintenance Manual
(see Table "Recommended Maintenance and Monitoring Programme" on page 2) must be performed.
Proper start-up procedures and scheduled periodic maintenance will prolong the life of the equipment and ensure
trouble-free performance for which the unit is designed.
20
S1500E
XES1500E
5
5 Inspection Prior to Start-up
5 Inspection Prior to Start-up
This manual suits for next models
1
Table of contents
Other BAC Air Conditioner manuals
Popular Air Conditioner manuals by other brands

Samsung
Samsung AW05F05EA Owner's instructions

Mitsubishi
Mitsubishi Mr.Slim PKA-A-GA installation manual

Haier
Haier HW-18LMA03(T3) Operation manual

Bosch
Bosch Climate 5000 MS 42 OU installation instructions

Toshiba
Toshiba RAV-SM2244DTP-TR Service manual

Mitsubishi Electric
Mitsubishi Electric BRANCH BOX PAC-MKA52BC installation manual
