Zonecheck 450 User manual

ZC450-IB-09/13-01 US
Instruction Booklet
Zonecheck 450


Zonecheck® 450
Copyright
This instruction booklet is property of Project Fire Products Ltd and must not be used or copied without
its written permission.
Information
While every effort has been made to ensure that the information contained within this document is
correct, Project Fire makes no guarantee for completeness or accuracy. Project Fire Products Ltd reserves
the right to change product specifications, designs and standard equipment without notice and without
incurring obligation.
Zonecheck is a registered product name of Project Fire Products Ltd. European patent No. 0907833.


Contents
01 Pre-checks
02 Installation
03 Commissioning
04 Testing
05 Orientation
06 Typical connection
07 Key-switch
08 Wiring
09 Dimensions
10 Specification
11 Troubleshooting
12 Important information
13 Warranty

Pre-checks
Before you install Zonecheck follow these simple steps.
1. Open the box and remove all packaging
2. Check you have the correct size manifold
3. Check that you have the correct model for your site (right or left handed).
4. Check that there is a key-switch and key in the box.
5. Inspect the product to make sure it hasn’t been tampered with. If you have any
queries please contact your supplier.
01

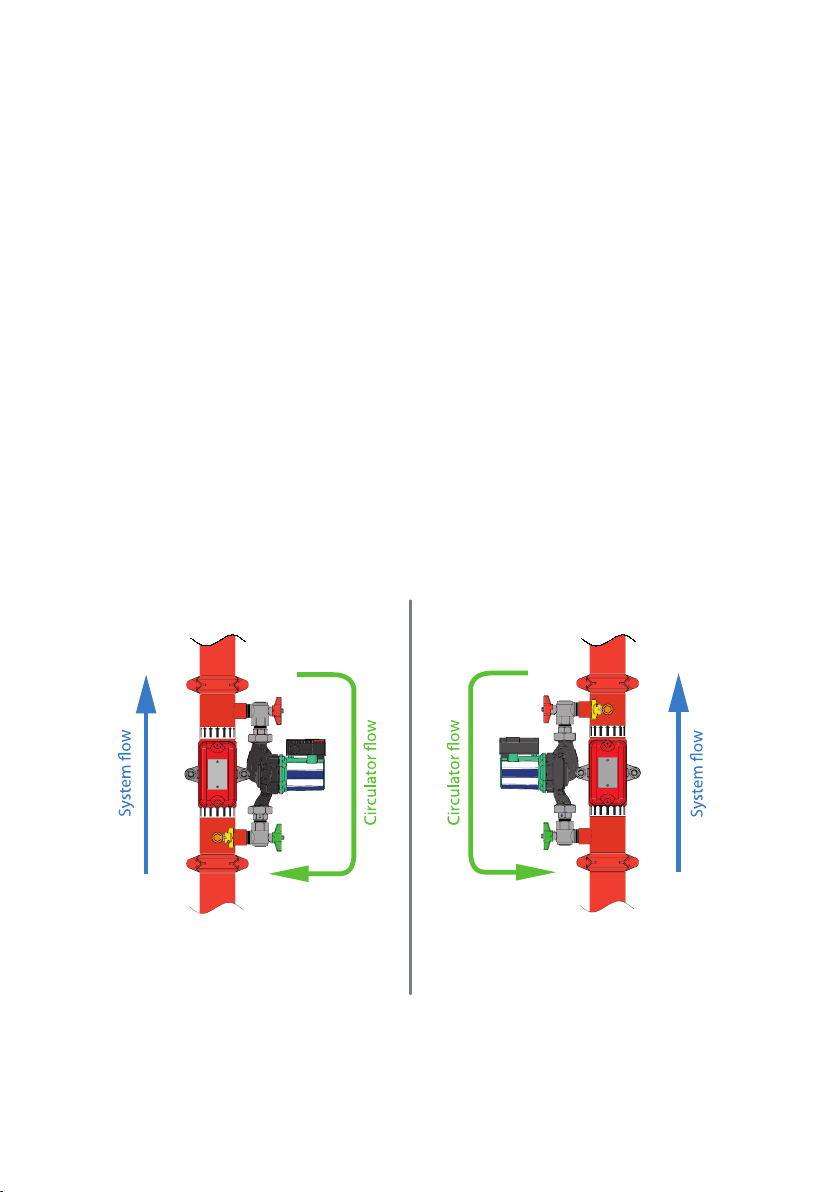

View from above
Left handed
View from above
Right handed

02
Installation
Zonecheck should be installed by a competent fire sprinkler installer and wired up by a qualified electrician.
1. Contact building management to inform them of the proposed works.
2. Isolate and drain down selected zone.
3. Orientate the Zonecheck in accordance with the diagrams in this booklet.
4. Install the Zonecheck with two approved grooved couplings (not supplied).
5. Double check that the sprinkler flow arrows on Zonecheck are facing the correct
direction (see diagrams included in this booklet).
6. Fit the key-switch to the wall in a suitable location that is easy to reach from floor
level.
7. Wire the Zonecheck pump and flow-switch to the key-switch in accordance with
the diagrams in this booklet.
8. Wire the flow-switch to the appropriate fire-detection panel in accordance with
the diagrams in this booklet.
9. Wire the appropriate power supply to the key-switch.
Proceed to Commissioning instructions.
DO NOT ATTEMPT TO RECONFIGURE.
TAMPERING WILL VOID THE WARRANTY!

03
Commissioning
1. Contact the centre control room to authorise a flow-switch test.
2. Ensure the Zonecheck red and green valves are in the open position (see fig 1).
3. Now remove access plug (air vent) on the end of the Zonecheck pump .
4. Using an appropriate screwdriver turn the shaft clockwise and anti-clockwise to check

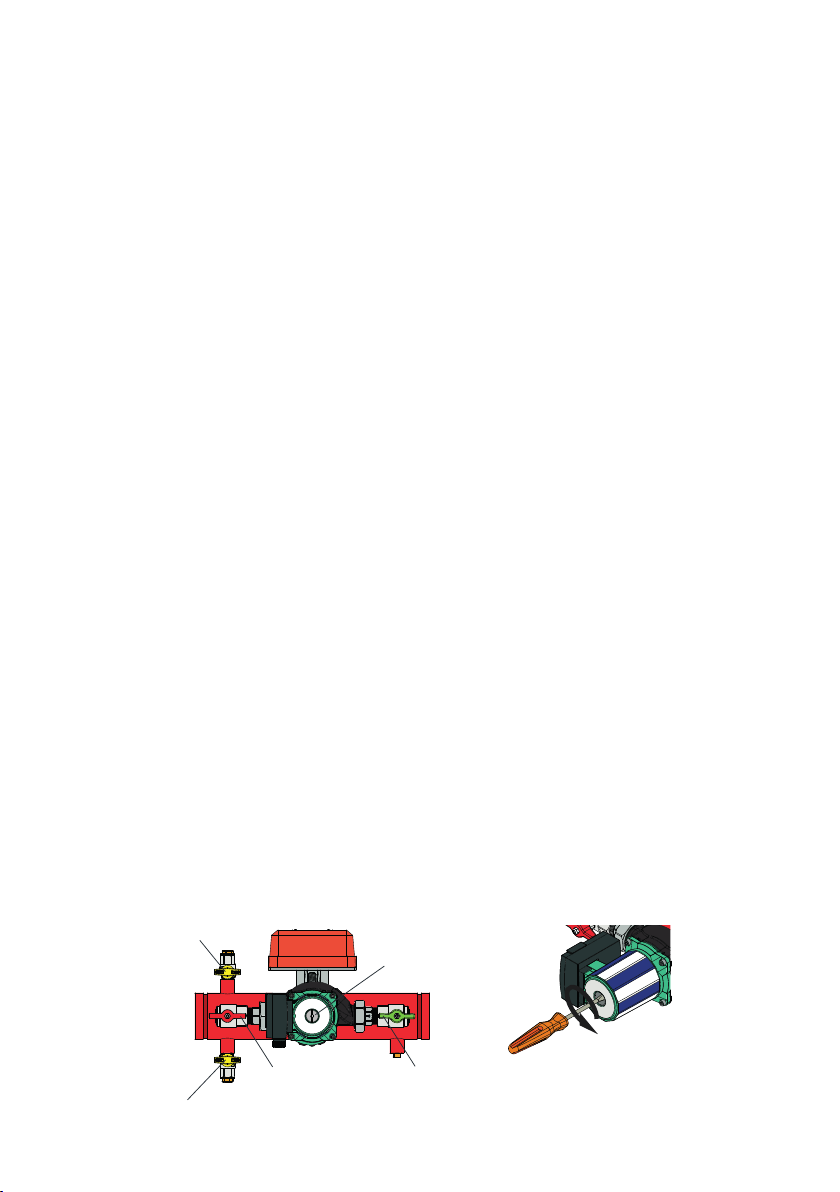

the free movement of the shaft and impeller (see fig 2), replace the access plug.
5. Attach hosepipe to yellow vent valve (see fig 1) on the Zonecheck. Now carefully open
the vent valve on the Zonecheck unit to remove the air from the Zonecheck pipework,
allow water to drain to make sure all air is bled from the unit. Then close vent valve and
replace plug.
6. Now connect a hosepipe to the test valve at the furthest point on the zone or use the
yellow test/drain valve provided on the Zonecheck unit (see fig 1).
7. Discharge water through the hose (this is a once only commissioning test).
8. Ensure the ‘water flow’ LED is illuminated on the key-switch (make sure the key-switch’s
power supply is on) this could take up to 30 seconds.
9. Now close the test/drain valve as appropriate.
10. Now turn the Zonecheck key-switch to ‘self test’ and check the ‘pump’and ‘water flow’
LEDs are illuminated (this may have a maximum delay of 30 seconds).
11. Confirm with the centre control room that they have received their test signal.
12. Turn the key-switch key to‘standby’ and remove key.
13. Fix operating instructions to wall, preferably next to the key-switch. Also place the
Zonecheck Isolation valve location sticker in a suitable position to let others know
where the unit is.
14. Ensure that the end user is instructed on how to carry out a routine test.
15. Fill in & hand over a completion certificate. Make sure that building management are
made aware when the system is back online.
Test/drain valve
Access plug
Inlet valve
Vent valve
Fig 1 Fig 2

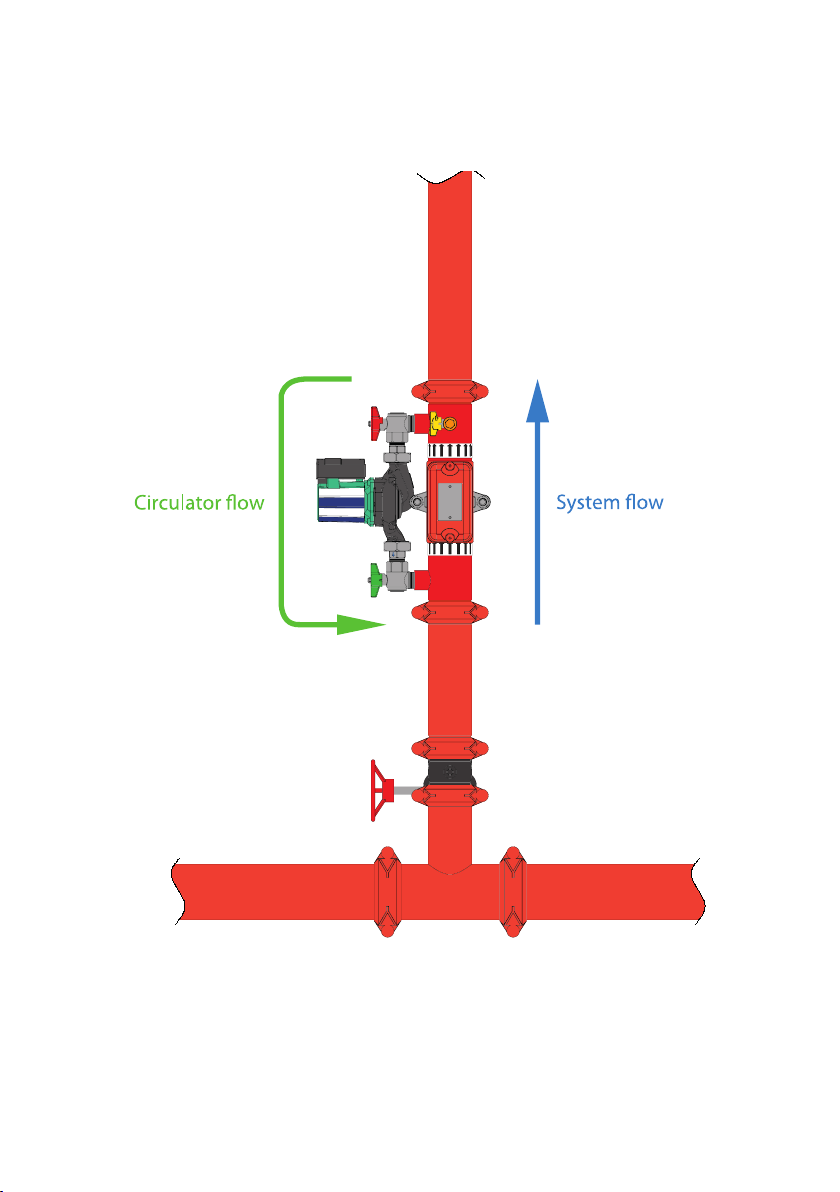

Outlet valve

04
Testing
Test one Zonecheck
1. Insert the key into the key-switch and turn to self test (the pump light will
activate) (see fig 1).
2. When the flow-switch operates, the water-flow light will activate (please
wait for up to 30 seconds for the flow-switch to operate).
3. Return to ‘standby’ position and remove the key.
Test a group of Zonechecks
1. To test all the Zonechecks in the group, insert the key into the key-switch
and turn to group test (see fig 1).
2. Look at the central fire control panel to confirm simultaneous activation of
all the flow-switches within the group.
3. Return to ‘standby’ position and remove the key.
CONTACT CENTRAL
MONITORING STATION OR
APPROPRIATE FIRE SAFETY
PERSONNEL PRIOR TO
TESTING
When test is complete turn key back to the ‘standby’ position.
120 V,AC~, 60Hz
SELF
TEST
WATER
FLOW
GROUP
TEST
Project Fire Products Limited tel +44 (0)1889 271271
Fig 1

Orientation
05
Plan view
Side view
Pump not horizontalFlow-switch on underside of pipe
Remember:
• The pump direction-of-flow arrow faces the opposite direction to the system flow.
• The red & green stripes on the pump cartridge are always horizontal.
• Do not position the flow-switch on the underside of the pipe.
• For vertical flow applications, only mount flow-switch where up-flow conditions exist.

06
Typical connection
A typical multi-occupancy Zonecheck Installation. For an example of a typical riser installation visit our website:
www.projectfire.co.uk
View from above
Zone Valve

The interconnect points should not be wired in a multi- occupancy sprinkler
installation. In a multi- occupancy premises where tenants have fire alarm panels
interfaced with the fire protection system, this key-switch should be wired for total
independence.
Note: Determine a suitable low level accessible location to fix the key-switch within
5m (commissioning cable length) of the Zonecheck.
Single Occupier Only
A single occupier, when the Zonecheck units are wired in parallel via interconnect,
can test all of the units by turning the key-switch to group test.
Single occupier may exclude the Zonecheck key-switch and wire a relay circuit to
activate each Zonecheck from a central control panel.
Pump-L
Pump-N
AC-N
AC-L
GND
Interconnect -
Interconnect +
WF Input
WF Input
Pump
Power
Supply
Flow-
switch

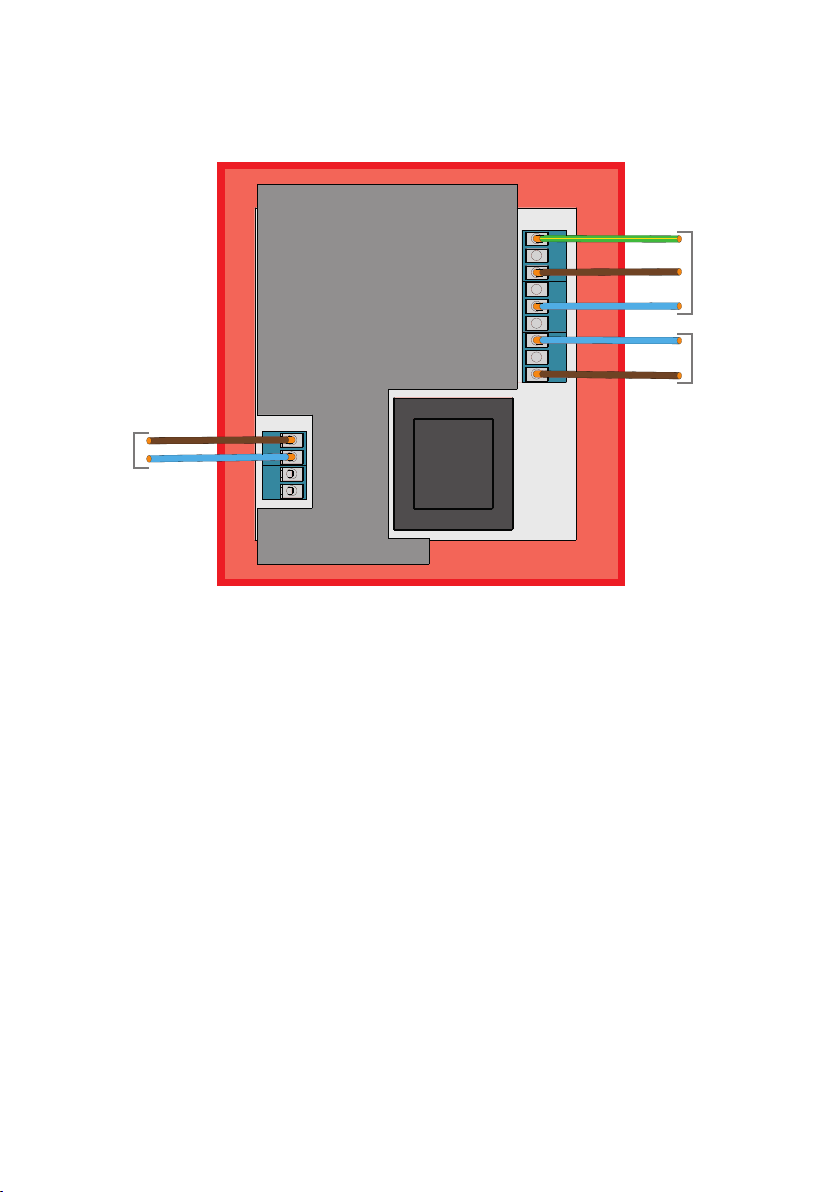

Typical Key-switch wiring layout
Key-switch
07

08
Typical Zonecheck and flow-switch water flow alarm circuit wiring diagrams.
Single Occupier
Multiple Occupier
A single occupier, when
the Zonecheck units
are wired in parallel via
interconnect, can test all
of the units by turning
the key-switch to“Group
Test”.
Single occupier - One
fire alarm panel for all
Zonechecks installed.
Multi occupier -
individual fire alarm
panel for each tenant/
occupier.
Pump
AC
AC
GND
Interconnect
WF input
B
Com
B
Com
Pump
L
N
+
-
LN
Fire alarm panel
Key-switch
Flow-switch
Pump
E
G
Main electric circuit board
+
-
Interconnect
Key-switch
2
Key-switch
3
Pump
AC
AC
GND
Interconnect
WF input
B
Com
B
Com
Pump
L
N
+
-
LN
Fire alarm panel
Key-switch
Flow-switch
Pump
E
G
Main electric circuit board
+
-
+
-
Interconnect +
-
Wiring

09
Dimensions

Working Pressure Rating.......................................................
Operating Temperature Range...........................................
Pipe Diameter...........................................................................
Approvals......................................................................................
Water, 12 bar (175 psi) maximum
0°C - 49°C (32°F – 120°F)
50, 65, 80, 100, 150 & 200 mm (2, 2½ 3, 4, 6 & 8“)
LPCB, UL, FM and VdS
Zonecheck
The ‘Standby’ mode will not give any false alarms when fitted in conjunction with an approved water flow
alarm device.
Circulation Pump
Operating Voltage...................................................................
Full Load Current.....................................................................
Power Rating.............................................................................
IP Rating.....................................................................................
WP Rating...................................................................................
Capacitor...................................................................................
1~120v 60Hz
1.63A
185 W maximum
IP44
12 bar (175 psi)
5.0 µF/400 VDB
Key-switch
Mounting...................................................................................
Type...............................................................................................
Operating Voltage..................................................................
Internat Consumption.............................................................
Operation Modes....................................................................
LED Operation:
Standby (Ready state)..............................................................
Test Initiation:...........................................................................
Flow Switch Activation:.........................................................
Flush-mounting
ZCK-1E
Single-phase 220 V, 50 Hz
7.5 W Maximum
Self-test: Wired locally
Group test: Interconnected
No LED
‘Pump’ LED (green)
‘Water Flow’ LED (green)
Flow-switch
Type.............................................................................................
Contact Rating...................................................................................
IP Rating.....................................................................................
Contacts.....................................................................................
Triggering Flow Rate...................................................................
Working Pressure...................................................................
Time Delay.................................................................................
WFDE
10A @ 125/250 VAC; 2.5 A at 24 VDC
IP54
2 change-over contacts
30–57 l/min
17.25 bar (250 psi) maximum; 16 bar (VdS)
0 - 30 s
Specifications
10

1. Attach hosepipe to yellow vent valve on the
Zonecheck.
2. Carefully open the vent valve on the Zonecheck
unit to remove the air, allow water to drain to
make sure all air is bled from the unit.
3. Close vent valve and replace plug.
4 Close the red valve and the green valve
on Zonecheck®.
5 Remove the access plug (air vent) and vent the
circulator until water drains from the vent.
6 Insert a flat headed screwdriver and rotate the
propeller shaft several times by turning the
screwdriver. Replace the access plug ensuring the
‘O’ ring’s seal is maintained.
7 Open the red valve and the green valve
on Zonecheck®.
Only pump light on.
Pump runs hot and
does not operate the
flow-switch.
No lights on key-switch. Open the key-switch and check the wiring against the
wiring diagram. Confirm the power supply has been
connected properly.
1. Check the red & green Zonecheck valves are open.
2. Check Zonecheck has been installed facing the
correct way.
3. Remove the plastic lid from the flow-switch, push and
hold the trigger with your finger for 30 seconds. If
the water-flow light (on the key-switch) operates see
below. If not check the wiring against the diagram.
Troubleshooting
Zonecheck should be troubleshooted by a competent fire sprinkler installer and wiring checked by a qualified
electrician.
11

12
Important Information
• Ensure Zonecheck is installed both mechanically and electrically commissioned
and tested prior to leaving site.
• Ensure protection to Zonecheck is employed whenever there is an extended
period from installation to commissioning.
• If the Zonecheck could be wired when the sprinkler system zone is drained down
then it is vitally important that the Zonecheck red and green valves are left in the
closed position, to ensure the motor is not accidentally run dry and damaged.
(Please ensure the commissioning engineer is aware of the closed Zonecheck
valve status).
• Always use a flat faced wrench for Zonecheck commissioning.
• The suggested location for the key-switch is at low level, adjacent to the fire
alarm panel.
• Fix operating instruction to wall, preferably next to key-switch.
• Each Zonecheck is factory assembled and tested. Do not attempt to reconfigure.
Tampering will void the warranty.
• Maximum working pressure - 12 bar (175 psi), test pressure - 18 bar (260 psi).
• Use Zonecheck flow-switch testers in wet-pipe systems only. Do not use in dry
pipe, deluge, or pre-action systems.
• Only activate the Zonecheck key-switch when the valves are opened and the
sprinkler system is full.

13
Three Year Warranty
Project Fire Products warrants its
enclosed Zonecheck flow-switch tester
to be free from defects in materials
and workmanship under normal use
and service for a period of three years
from date of manufacture. Project
Fire Products makes no other express
warranty for this flow-switch tester.
No agent, representative, dealer or
employee of the Company has the
authority to increase or alter the
obligations or limitations of this
warranty. The Company’s obligation
of this Warranty shall be limited to the
repair or replacement of any part of the
flow switch tester, which is found to be
defective in materials or workmanship
under normal use and service during
the three-year period commencing
with the date of manufacture. After
phoning Project Fire’s number, 01889
271271 for a Return Authorization
number, send defective units postage
prepaid to Project Fire, Pasturefields
Industrial Estate, Pasturefields Lane,
Hixon, Staffs, ST18 0PH. Please include
a note describing the malfunction and
suspected cause of failure. The Company
shall not be obligated to repair or replace
units, which are found to be defective
because of damage, unreasonable use,
modifications, or alterations occurring
after the date of manufacture. In no
case shall the Company be liable for any
consequential or incidental damages
for breach of this or any other Warranty,
expressed or implied whatsoever, even
if the loss or damage is caused by the
Company’s negligence or fault.


ph 763-391-0990
fx 763-391-7668
cel 612-991-9791
8730 Jefferson Highway, Osseo, Minnesota 55369, USA www.gviflow.com
GLOBAL VISION INC.
Table of contents
Popular Test Equipment manuals by other brands

OSTBERG
OSTBERG HERU S Series installation instructions

Keysight Technologies
Keysight Technologies U9361G quick start guide

Rohde & Schwarz
Rohde & Schwarz R&S RTO Series Getting started

Murideo
Murideo Fox & Hound manual

Agilent Technologies
Agilent Technologies 8922M user guide

Fluke
Fluke 6100B user manual
