KUDOS ultimate 700 User manual

1Issue 01 JUNE.21
Please read these instructions throughout before installing as incorrect tting will invalidate the guarantee.
If you are unsure about these instructions please contact Barwick Bathroom Distribution LLP 01274 687555.
HEALTH & SAFETY WARNING
DUE TO THE WEIGHT & SIZE OF THE GLASS PANEL(s) A MINIMUM OF TWO PERSONS ARE REQUIRED
TO MOVE AND INSTALL THIS ENCLOSURE
For the wall post and xings use only warm soapy water and damp cloth/ sponge
on a regular basis. After cleaning please rinse with clean water to remove any
residue.
Do not use abrasive scouring powders, chemicals or aerosol cleaners - these may
result in damage to the surfaces, in particular, the plated component parts.
The glass panels are pre-treated with a protective coating on the inside surfaces
only. Whilst this makes cleaning the glass easier and helps prevent the build up of
harmful lime-scale and soap deposits, the glass still needs to be maintained on a
regular basis. We recommend the use of a detergent and aroma free glass cleaner
(A 50/50 mix of white vinegar and water works well)
DO NOT use strong detergents, abrasive cleaners or abrasive scrubbing
equipment for cleaning, these can damage the coating.
DO use a squeegee to remove remaining droplets of water from glass after
showering, any build up of residue can be removed easily using an appropriate
cleaner and agitation from soft cleaning equipment
Cleaning - General
Glass Treatment
Important
Check appearance of all product - any defects must be reported to your retailer
before assembly/installation. Claims for imperfections will only be accepted prior
to assembly/installation.
Any claims made under the terms of the Lifetime Guarantee
must be reported to your retailer within 21 days of the fault occurring
Check the enclosure adjustment sizes are suitable for your installation.
Use care when drilling into the walls to avoid hidden pipes or electric cables.
Check Bath Installation
THESE INSTRUCTIONS ARE TO BE LEFT
WITH THE CONSUMER
Tools Required
Pozi-head Screwdriver Clear Silicone Sealant
7mm Masonry Drill BitSpirit Level Pencil
Bathrim MUST BE LEVEL
in all directions.
Bathscreen must be tted
to waterproof surface e.g.
tiles/shower panels.
Once the walls have
been tiled and before the
screen is installed, the
tiles MUST be silicone
sealed to the bath all
of the way around in
one continuous bead,
as shown. Failure to
follow this instruction
will result in leakage
problems behind the
screen wallpost.

Glass & Component Packs
10BSWPK
1x Wallpost
1x Wallpost End
Cap 1x Glazing seal and
10mm Cushion Seal 1x Screw Holding
3x Rawlplug
3x Pan Hd Screws
10BSWPCS
1x 10mm Glass to Glass Corner Seal
10BSWP700/750/800/900
1x 10mm Glass Panel (700, 750, 800, 900 options) 1x 10mm Glass Trim
10WPGW30 (300mm), 10WPGW50 (500mm)
1x Angle Bracket (300mm or 500mm)
1x Rawlplug
1x Pan Hd Screws
10WPFPFK
1x Rawlplug
1x Pan Hd Screws
1x 3mm Allen Key
1x Top Finial 1x Rail Wall Bracket1x Stabiliser Rail (1000mm)
HacksawScissors
Tape Measure
Drill (Battery or Mains)
BATHSCREEN INSTALLATION INSTRUCTIONS (10mm)
10WPSPFK
1x 3mm Allen Key1x Top Finial 1x Rail Wall Bracket1x Stabiliser Rail (1000mm)

2Issue 01 JUNE.21
Product Sizes and Adjustments
Product
Glass Panel
(nominal size)
Product Code Dimensions (mm)
10mm glass A B C D
700 10BSWP700 653 - 673 648 662 - 682 24
750 10BSWP750 703 - 723 698 712 - 732 24
800 10BSWP800 753 - 773 748 742 - 762 24
900 10BSWP900 853 - 873 848 842 - 862 24
Overall Height = 1634mm (including Top Finial)
Fitting Wallpost to Wall
1. Position wallpost onto Bath so that when the screen is tted, the
glass panel is on the inside edge of the bath rim. Take into account
that the glass panel inside surface will be 8mm from the inside surface
of the wallpost, as shown.
2. Ensure wallpost is vertical using spirit level. Using pencil, mark
position through 3 pre-drilled slots in wallpost onto wall and remove
wallpost.
It is particularly important to position the bathscreen on the inside
edge for the following reasons:
a. To assist in water drainage off the screen and into the bath.
b. For Baths where the inside edge of the rim is higher than that of the
outside edge. (We are unable to guarantee the screen will not leak on
Baths with a rim of this type).
3. Using a 7mm masonry drill bit and drill (or appropriate drill bit if
drilling tiles), drill the 3 holes using the ‘spot’ marks, each hole should
be 45mm in depth.
4. Insert the three ‘8mm Wall Plugs’ into the three holes.
5. Apply a bead of silicone sealant around the bottom & centre holes
made in wall before xing wallpost to wall. Fix wallposts using 3 x
No.8x30 PH S/S Screws provided. Tighten all screws using pozi-head
screwdriver, ensuring the wallpost is vertical.
6. Insert cushion seal to front side of wallpost as shown to the right.
8mm
Outside
A
D
1
B
D
C
2
A
D
D
A
900
MAXIMUM
Important Information Before Installation
To ensure correct drainage of shower water into the bath you should check
the shape of your bath rim prior to tting your bath screen.
Most bath rims will be higher on the outside edge than the inside edge,
commonly referred to as having a “positive fall” however some bath edges
may have a “negative fall” with the inner edge being higher than the outer
edge.
If your bath has a “positive fall” the screen can be tted close to the centre of
the bath rim, however if the rim has “negative fall” then the screen must be
tted to the inner edge of the bath. If uncertain the screen should be tted to
the inner edge of the bath. If not correctly positioned water may track along
the edge of the bath and spill onto the oor at the end of the screen.
Inside
Outside
Outside
Inside
Position of
Screen
Negative
Fall
Outside
Inside
Position of
Screen
Positive
Fall

3Issue 01 JUNE.21

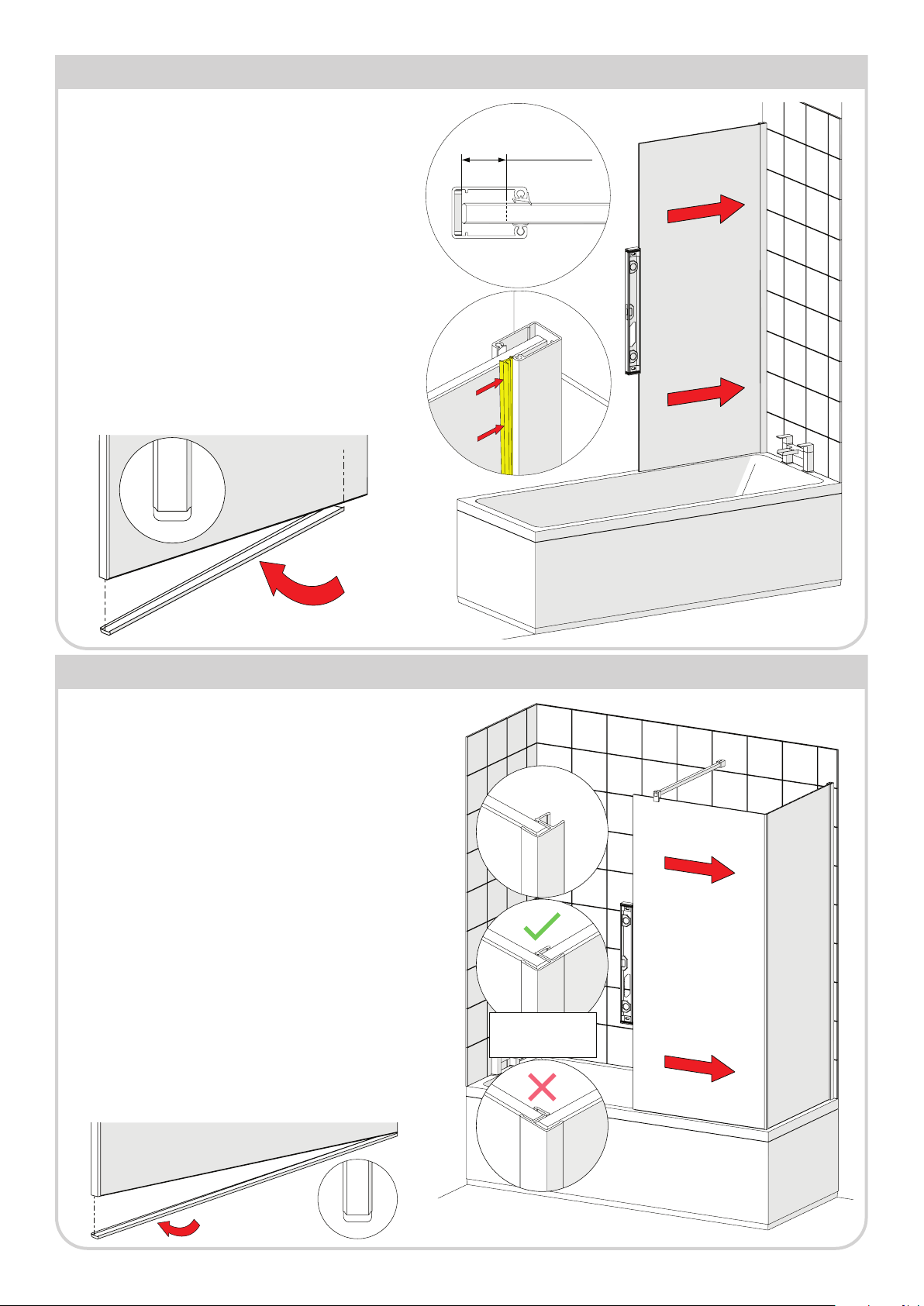

Fitting Glass Panel
1. Take note of label ‘This surface to outside’ this will determine
which is the bottom edge of your installation. Ensure that the glass
surface treated with lifesheld faces INSIDE of shower enclosure
2. Acquire the Glass Trim. Cut 15mm from one end. Peel off a
small length of the bottom trim adhesive tape and apply to bottom of
glass panel 15mm from the end that will be going into the wallpost, as
shown. Continue along length of trim, peeling away the tape as you go,
until the full trim length is adhered to the panel.
Use small upturned edges on bottom trim against chamfered glass edges
to ensure trim is tted centrally.
3. Carefully t glass panel into slot in wallpost, ensuring panel is parallel
to tray edge. Ensure outer edge of in-line panel is plumb vertical, as
shown, using spirit level.
4. Secure panel by inserting glazing seal, starting from top and working
downwards, trim excess length.
If tight, lubricate glazing seal with water. Do not stretch seal when inserting,
beacuse, after cutting to length, the seal will shrink and leave a gap.
20mm
max
glass adjustment
within wallpost
Fitting Glass to Glass Panels
1. Fit wallpost and rst panel (A) to wall, as previously described.
2. Take note of label ‘This surface to outside’ this will determine which is
the bottom edge of your installation. Ensure that the glass surface treated with
lifesheld faces INSIDE of shower enclosure
3. Acquire the Glass Trim. Peel off a small length of the bottom trim adhesive
tape and apply to bottom of glass panel from one end. Continue along length
of trim, peeling away the tape as you go, until the full trim length is adhered to
the panel.
Use small upturned edges on bottom trim against chamfered glass edges to
ensure trim is tted centrally.
4. Fit glass to glass orner seal to edge of second panel (B), ensuring seal is level
with top & bottom of glass panel.
5. Carefully offer up second panel to rst panel, ensuring the tted corner seal
lines up with edge of rst panel at the bottom.
6. Ensuring second panel is square to rst panel, push t corner seal onto
edge of rst panel. Corner seal must be fully inserted onto both panels.
7. Fit front panel component pack to second panel (B). See next page.
If tight, lubricate the corner seal of glass edges with a damp CLEAN cloth to ease
fitment - the water will evaporate over a short period. DO NOT USE silicone
spray or any other substance other than water, these will not fully dry out and will
compromise the grip and rigidty of the joint.
B
AB
BA
Front Panel ‘B’
always in front of
side panel ‘A’
Inside view Inside view

4Issue 01 JUNE.21
1. Position top cover cap over wallpost prole and
press down to secure
Fitting Wallpost Cover Cap
Fitting Front Panel Component Pack
1. Remove 8mm inner pad and t nial to top edge of glass panel and secure in position by tightening screw (to inside face) using 3mm allen key supplied.
2. Carefully slide stabiliser rail through top nial and mark position of rail to back wall - please ensure that rail is both level and square to wall.
3. Find centre of mark to wall, drill and t rawlplug.
4. Fix rail wall bracket to wall using screw provided, ensuring the grub screws facing upwards.
5. Slide rail through top nial and fully into wall bracket, measure length protruding from top nial and cut rail to length using hacksaw. Cut opposite end to tting end
cap.
6. Secure rail by tightening top grub screws in top nial and 2x grub screws in wall bracket using 3mm allen key.
75mm min.
175mm max.
Do not exceed above limits
or it will not be possible to
retro-t a Deetor Panel
during this installation or
at some time later
1
2
4
5
6
End with endcap
3

5Issue 01 JUNE.21

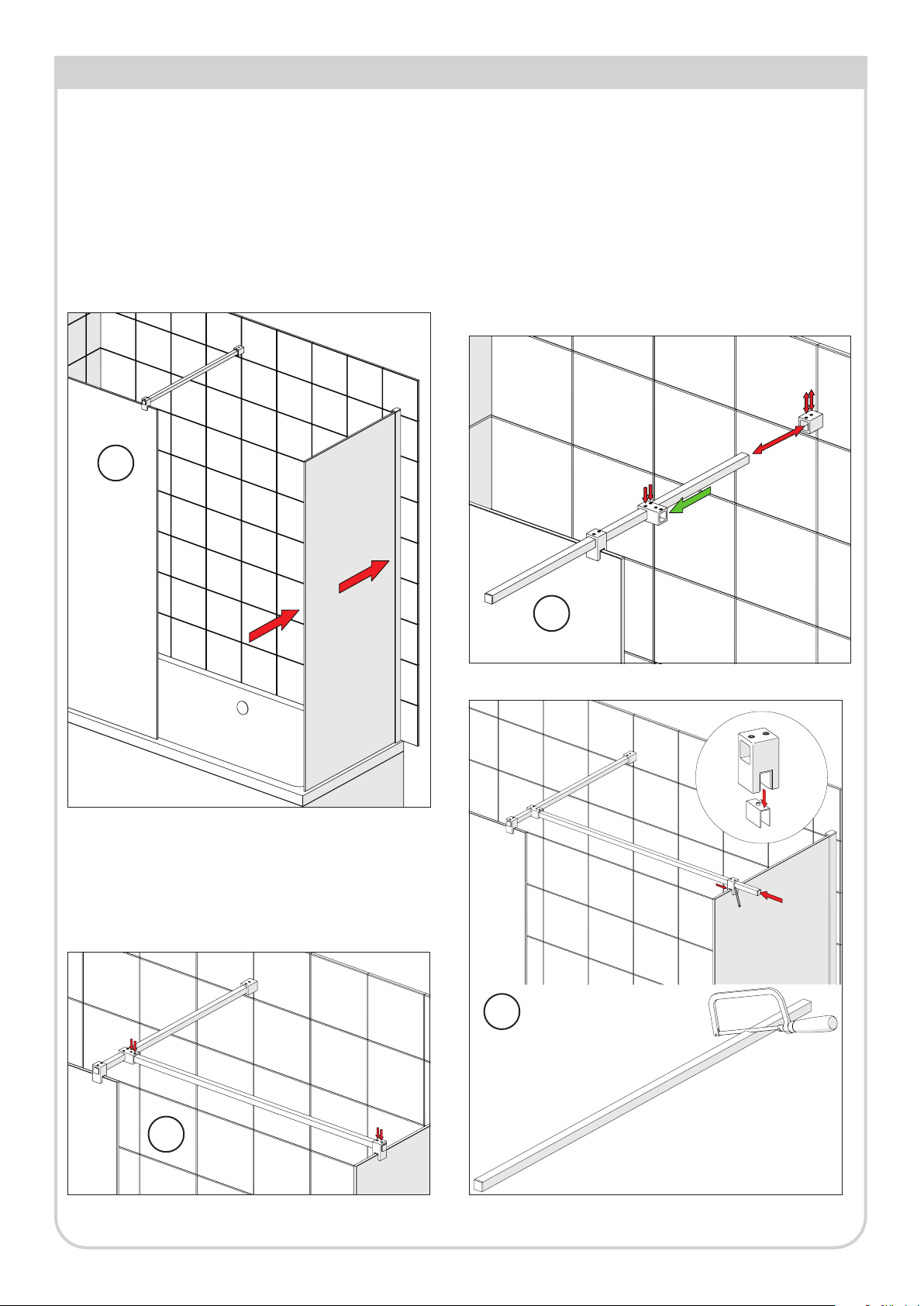

Fitting Side Panel Component Pack
1. Fit 2nd wallpost and 2nd glass panel as described previously.
2. Loosen the front xing rail from the wall bracket. Slide the junction bracket to position required, ensuring grub screws face towards side panel. Tighten with grub
screws in position, using the 3mm allen key.
3. Remove 8mm inner pad and t nial to top edge of side glass panel. Run the rail through into the junction bracket. When straight tighten the top nial with the side
grub screw to the side panel glass. Mark the rail and cut to length if required.
4. Secure rail by tightening top grub screws in top nial and 2x grub screws in juntion bracket using 3mm allen key.
1
2
3
4

6Issue 01 JUNE.21
Apply Silicone Sealant
1. On the Outside seal glass panels to bath, seal wallposts to wall and bath.
2. On the Inside ONLY silicone seal the wallpost to wall through entire height only. DO NOT seal bottom of the wallpost to the bath or the inside of the
panels.
When installed correctly, Kudos guarentee the enclosure will not leak under normal showering use, ie. when the shower head is in it’s normal showering
position. N.B. - Using the shower head to clean/rinse down the enclosure does not constitute normal showering use.
3. Allow 24 hours before using the shower/bath.
Apply a small bead of sealant to top of
corner seal to prevent ingress of dirt
between seal and glass panels
Inside view
Outside view
Outside view
Inside view
