PV-ezRack SolarRoof Pro 2.0 Technical manual

Code-Compliant Planning and Installation Guide V1.0
Complying with Eurocodes 0-9 and VDI 6012
Ver 1.0 / Last Updated - Mar. 2023
SolarRoof Pro 2.0

Installation Guide / SolarRoof Pro 2.0 Installation Guide / SolarRoof Pro 2.0
12
Code-Compliant Planning and Installation Guide V1.0 - Complying with Eurocodes 0-9 and VDI 6012 Code-Compliant Planning and Installation Guide V1.0 - Complying with Eurocodes 0-9 and VDI 6012
Introduction
Complying with all applicable local or national
building codes, including any that may supersede this
manual;
Ensuring that PV-ezRack and other products are
appropriate for the particular installation and the
installation environment;
Using only PV-ezRack parts and installer-supplied
parts as specified by the PV-ezRack project plan.
(substitution of parts may void the warranty and
invalidate the letter of certification);
Recycling: Recycle: according to the local relative
statute.
Removal: Reverse installation process.
Ensure that there are no less than two professionals
working on panel installation.
Ensure the installation of related electrical equipment
is performed by licenced electricians.
Ensuring safe installation of all electrical aspects of
the PV array.
Ensuring that the roof, its rafters/purlins, connections,
and other structural support members can support
the array under building live load conditions;
Ensuring that screws to fix interfaces have adequate
pull-out strength and shear capacities as installed;
Maintaining the waterproof integrity of the roof,
including selection of appropriate flashing;
The installation need to comply with the regulations
of the German Central Association of Roofers (ZVDH)
for work on roofs.
During the installation of supporting system, module
installation shall take full consideration of fire risks.
Please read and understand the solar module
installation manual before system installation.
For more regulations of the German Professional
Association, see:
BGV A1-General rules
BGV A2-Power Systems and Equipment
BGV C22-Construction work
•
•
•
•
•
•
•
•
•
•
•
•
•
•
List of contents
Introduction
System Specifications
Tools & Component
System Overview
Installation Instruction
Alu Hook Installation
01
02
03
04
06
08
The Clenergy PVezRack® SolarRoof Pro 2.0 is a roof-
mounting solution suitable for most residential pitched
roofs. Using our innovative rail, M module, and interface
family, the SRP2.0 delivers a quick, safe, and cost
effective solution for installers.
Please review this manual thoroughly before installing
PVezRack® SolarRoof Pro 2.0. This manual provides:
1) Supporting documentation for building permit
applications relating to PVezRack® SolarRoof Pro 2.0 PV
Module Mounting System,
2) Planning and installation instructions.
The PVezRack® SolarRoof Pro 2.0 parts, when installed
in accordance with this guide, will be structurally sound
and will meet the Eurocodes and VDI 6012 standard.
During installation, and especially when working on the
roof, please comply with the appropriate Occupational
Health and Safety regulations. Please also pay attention
to any other relevant State or Federal regulations.
Please check that you are using the latest version of the
Installation Manual, which you can do by contacting
Clenergy via email on sales@clenergy.com.
- Introduction -
The installer is solely responsible for: Roof Angle 15-60 degrees
Building Height <=12m
Wind Zone Wind zone 1 to wind zone 4
Snow Zone Snow zone 1 to snow zone 3
Max Altitude According to the calculation report
Max Span Width According to the calculation report
Min distance for wood screws from wood edges According to EN 1995-1-1
Manufacture Clenergy Technology Co., Ltd.
Design Standards BS EN 1990:2002 Basis of Structural Design;
DIN EN 1991-1-4. Eurocode 1: Actions on structures - Part 1-4:
General actions - Wind actions;
DIN EN 1991-1-3 : 2004 EUROCODE 1: ACTIONS ON
STRUCTURES - PART 1-3: GENERAL ACTIONS - SNOW LOADS;
VDI 6012 Blatt 1.4 Integration of decentralised and regenerative
energy systems in buildings;
EN 1995-1-1: Eurocode 5: Design of timber structures;
DIN 1055-4:2006:Eurocode3 Design of Steel structures -Part 1- 8:
Design of joints;
DIN 1055-5:2006: Actions on structures-Part5: Snow loads and
ice loads.
All wood fasteners need to follow the local building regulations, e.g. DIN 1052
Only approved and certified wood screws are to be used for roof hook installations
The hooks can only be mounted on the roof rafters but not on the roof lath (the horizontal wood beams that hold
the tiles)
Note:
Snow zone 1, altitude above the sea level up to 500m;
Snow zone 2, altitude above the sea level up to 285m;
Snow zone 3, altitude above the sea level up to 255m;
Wind zone 1, Inland, the height of building less than 12m;
Wind zone 2, Inland, coastal and island of the Baltic Sea; the height of building less than 12m;
Wind zone 3, Inland, coast and islands of the Baltic Sea; the height of building less than 12m;
Wind zone 4, Inland, coast of the North and Baltic Seas and islands of the Baltic Sea; the height of building less than
12m.
System Specifications
- System Specifications -

Installation Guide / SolarRoof Pro 2.0
34
Code-Compliant Planning and Installation Guide V1.0 - Complying with Eurocodes 0-9 and VDI 6012
Angle Grinder with
Stone Disk
Screw Driver
(for M8 Torx Screw and
bolt)
Torque Spanner Tape String & Marker Pen
Spanner
Tools and Components
Tools
Components
EC-M28-46/L50
EC-M28-46/L50/BA
End Clamp 28-46mm
with M module, Length
50mm
IC-M28-46/L50
IC-M28-46/L50/BA
Inter Clamp 28-46mm,
with M module, Length
50mm
ER-R-SRPII/TO/40
Toroda Rail 40
ER-SP-SRPII/TO/40
Splice for Toroda Rail
40, L200mm
ER-I-SRPII/TO/02A
Alu Adjustable Roof
Hook 40-56 with
Toroda rail connection,
wood screw 8*100
EZ-CAP-TO/40/G
Cap for Toroda Rail 40
EZ-GL-TO
Grounding Lug for
Toroda Rail
GC-DT
Grounding Clip
EZ-CC-PV/4
Capilano Cable Clip for
PV Panels for holding 4
cables
Installation Guide / SolarRoof
System Overview
Overview of PV-ezRack SolarRoof Pro 2.0 (Portrait)
A
A
D
D
B
B
E
E
C
C
A. End Clamp B. Inter Clamp C. Toroda Rail 40 D. Splice for Toroda Rail 40
E. Tile interface
A
A
D
D
E
E
B
B
C
C
A. End Clamp B. Inter Clamp C. Toroda Rail 40 D. Splice for Toroda Rail 40
E. Tile interface (90° rotated)
Overview of PV-ezRack SolarRoof Pro 2.0 (Landscape)
- Tools and Components - - System Overview - Code-Compliant Planning and Installation Guide V1.0 - Complying with Eurocodes 0-9 and VDI 6012

56
Precautions during Stainless Steel Fastener Installation
Improper operation may lead to deadlock of Nuts and Bolts. The steps below should be applied to stainless steel nut
and bolt assembly to reduce this risk.
General installation instructions:
(1) Apply force to fasteners in the direction of thread
(2) Apply force uniformly, to maintain the required torque
(3) Professional tools and tool belts are recommended
(4) In some cases, fasteners could be seized over time. As an option, if want to avoid galling or seizing of thread, apply
lubricant (grease or 40# engine oil) to fasteners prior to tightening.
Installation Guide / SolarRoof
Safe Torques
Please refer to safe torques defined in this guide as shown in the figures below. In case power tools are required,
Clenergy recommends the use of low speed only. High speed and impact drivers increase the risk of bolt galling
(deadlock). If deadlock occurs and you need to cut fasteners, ensure that there is no load on the fastener before you
cut it. Avoid damaging the anodized or galvanized surfaces.
Installation Guide / SolarRoof
Modules in Portrait
− The min. distance from the mounting rack to the roof edges is 20cm.
− Assess the horizontal spacing of the Roof Hooks;
− Assess the vertical spacing of the Roof Hooks = approx. 1⁄2 to 3⁄4 of module height;
− Check the allowed max. spacing listed in this installation guide.
Installation Instructions
- System Overview - - Installation Instructions -
Code-Compliant Planning and Installation Guide V1.0 - Complying with Eurocodes 0-9 and VDI 6012 Code-Compliant Planning and Installation Guide V1.0 - Complying with Eurocodes 0-9 and VDI 6012

78
Installation Guide / SolarRoof
Modules in Portrait
− The min. distance from the mounting rack to the roof edges is 20cm.
− Assess the horizontal spacing of the Roof Hooks;
− Assess the vertical spacing of the Roof Hooks = approx. 1⁄2 to 3⁄4 of module height;
− Check the allowed max. spacing listed in this installation guide.
− Always check the installation manual of the PV-Module you use in order to determine the allowed fixing points on
the module frame.
Installation Guide / SolarRoof
Fix the roof hooks to the rafter using M8*100 Torx screw
as shown in the figure on the right following screws
installation guide below:
- Use a 3/8" Torx Socket.
- Use a powered or cordless screw driver.
- Fit the driver bit into the screw and place at the
fastening position.
- Apply consistently firm pressure (end load) to the screw
driver until the screw is fastened.
Note: Only approved and certified wood screws are to be
used for roof hook installations. A predrill 5mm dia. hole
is needed and the distance between the screw to rafter
edge is 3×d (screw dia.)
The hook can be installed only on the roof rafter but not
on the tile lath.
The roof hook must not press against the roof tile. If
necessary, pack the roof hook.
Determine the positions of the roof hooks according to
your plans. Remove the roof tiles at the marked positions
or, if possible, simply push them up slightly.

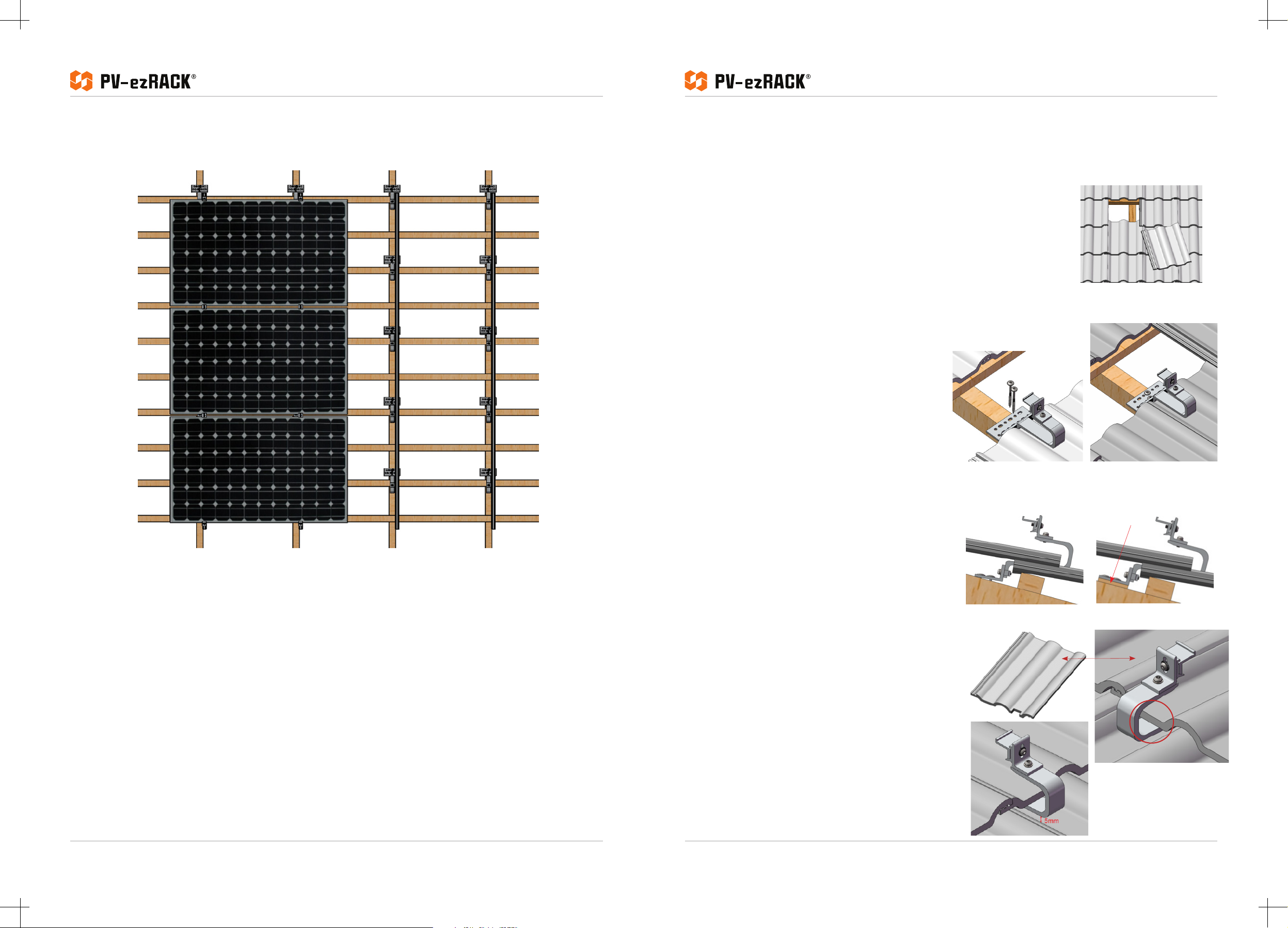

Alu Hook Installation
If necessary, use an angle grinder to cut a recess in the
tile covering the Roof Hook at the point where the Roof
Hook extends so that the tile lies flat on the surface. If
grooved tiles are used, it will also be necessary to cut a
recess in the lower tile.
5mm spacing between the lower side of arm and tile is
recommended as shown in the figure on the right.
INCORRECT CORRECT
Pad
- Installation Instructions - - Alu Hook Installation -
Code-Compliant Planning and Installation Guide V1.0 - Complying with Eurocodes 0-9 and VDI 6012 Code-Compliant Planning and Installation Guide V1.0 - Complying with Eurocodes 0-9 and VDI 6012

Installation Guide / SolarRoof Pro 2.0 Installation Guide / SolarRoof Pro 2.0
910
Code-Compliant Planning and Installation Guide V1.0 - Complying with Eurocodes 0-9 and VDI 6012 Code-Compliant Planning and Installation Guide V1.0 - Complying with Eurocodes 0-9 and VDI 6012
Caution! Do not use fitted roof hooks as a ladder, as this
extreme point load could damage the tile below.
To connect several rails together, slide half of the splice into the rear side of the rail, until it’s stuck and fixed by the
Connection Clip. Then slide the next rail into the splice and get it fixed.
The installation location of the splice is as shown in the figure below.
Place the rails on the Upper Clamp for L Bracket, and fasten the M8 Torx screw loosely with Torx L-key or the equivalent.
The recommended torque is 14N•m.
Please refer to the figures on the right for adjustments.
The adjustable range are shown in the figure below.
78-98 mm
46-56 mm
73 mm
141 mm
3 mm
L1: min.1/6 of the rail span
L2: max.5/6 of the rail span
Rail Installation
- Alu Hook Installation - - Alu Hook Installation -

Installation Guide / SolarRoof Pro 2.0 Installation Guide / SolarRoof Pro 2.0
11 12
Code-Compliant Planning and Installation Guide V1.0 - Complying with Eurocodes 0-9 and VDI 6012 Code-Compliant Planning and Installation Guide V1.0 - Complying with Eurocodes 0-9 and VDI 6012
Note: If PV modules are installed in landscape, the
rail need to running parallel to the rafter, as shown
in the figure on the right.

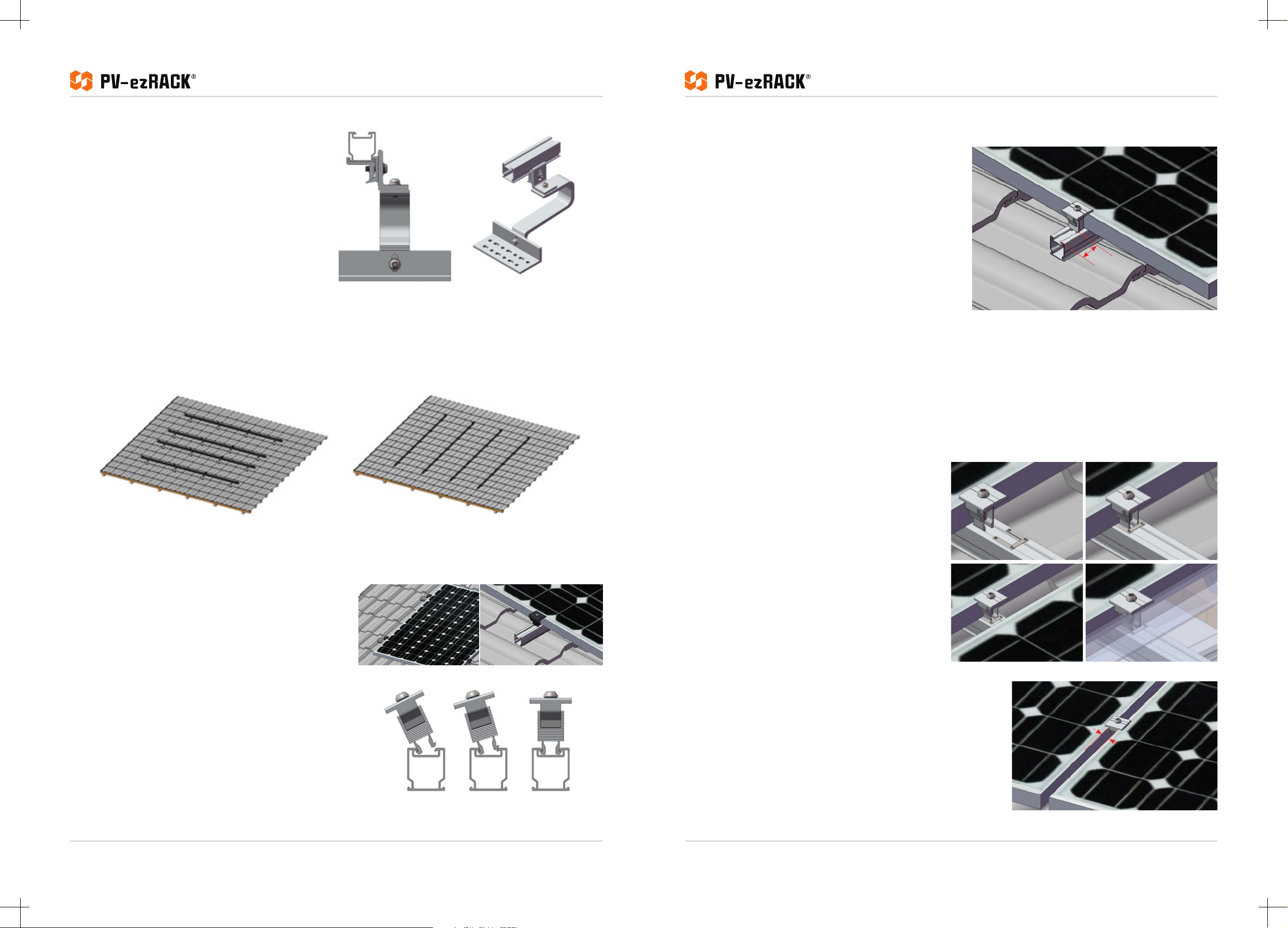

Place PV Modules on rails, fix with end clamps and
inter clamps. Click the M-module of the clamps
into the top channel of rail as shown in the figures
on the right.
Step 1 Place the first PV Module on Rails according
to your plan and apply the End Clamps to fix it
and then fasten lightly using Torx L-key or the
equivalent as shown on the right figure.
Incline
modules in portrait modules in landscape
Click in Press down
PV Module installation
Notes:
The distance L from end clamp to the end of the rail shall
be over 10mm.
Step 2 Slightly lift the PV Module and slide Inter
Clamps and Grounding Clips into position. The teeth on
Grounding Clip will automatically align when the Inter
Clamp is properly installed as shown on the right figures.
Step 3 loosely place the next framed PV Module into
the other side of the Inter Clamp and Grounding Clip as
shown on the right figure.
Important Notes:
- To fix the Grounding Clip properly, ensure the frames
of PV Modules are completely pressed against the Inter
Clamp and Grounding Clip. Visually check that Grounding
Clips are positioned properly.
- Grounding Clips are intended for SINGLE USE ONLY!
- Only fasten the bolts down when the position of PV
Module is finalized. (Only slightly tighten bolts to keep PV
Modules in place prior to the final check)
Step 4
Maintain 20mm vertical gap and 20mm horizontal gap
between the two adjacent rows of PV Modules.
You can use two Inter Clamps to separate two PV
Modules, and remove after installation as shown on the
right figure.
Double check if all PV Modules are fixed properly.
Fasten all the screws tightly with the recommended
torque 14N•m.
L
20mm
Verify Maximum Rail End Overhang
Rail end overhang should be not over 40% of the interface spacing. For example, if the interface spacing is 1500mm,
the Rail end overhang can be up to 600mm only.
The rail installation are completed as shown in the figures below.
- Alu Hook Installation - - Alu Hook Installation -

Installation Guide / SolarRoof Pro 2.0 Installation Guide / SolarRoof Pro 2.0
13 14
Code-Compliant Planning and Installation Guide V1.0 - Complying with Eurocodes 0-9 and VDI 6012 Code-Compliant Planning and Installation Guide V1.0 - Complying with Eurocodes 0-9 and VDI 6012
PV module installation is completed as shown on the right figures.
Grounding System
Accessories Installation
Grounding Lug installation
Slide the W module into the top channel of rail, and fasten the
M8 Torx screw tightly with recommended torque of 14N·m.
Insert the copper wire into the grounding lug and fasten the
M8 Torx screw tightly with recommended torque of 8N·m as
shown on the right figures.
Cable clip installation
Clamp the cable clip on the edge of PV modules. Insert the cables into the holes of cable clips as shown on the right
figures.
- Alu Hook Installation - - Alu Hook Installation -

15
Installation Guide / SolarRoof
Code-Compliant Planning and Installation Guide V1.0
A Clenergy Technologies Company
Clenergy
999-1009 Min’an Rd,
Huoju Hi-tech Ind. Dev. Zone
Xiang’an District 361101, Xiamen,
Fujian, China
Phone: +86 592 311 0088
Email: sales@clenergy.com
Web: www.clenergy.com
@Clenergy
@Clenergy_global @ClenergyClub
@Clenergy
@ClenergyGlobal / @ClenergyClub / @ClenergyAUS / @ClenergyThailand
Table of contents
Other PV-ezRack Solar Panel manuals
