Orbinox ALUMINUM STOP LOG SA User manual

INSTALLATION, OPERATION AND
MAINTENANCE MANUAL
ALUMINUM STOP LOG “SA”

IOM MANUAL
SA ALUMINUM STOP LOG
www.orbinox.com
EDITION 12/2017
IOM-SA
1. INTRODUCTION .................................................................................................................................................... 2
2. EQUIPMENT MAIN COMPONENTS......................................................................................................................... 3
3. HANDLING AND STORAGE.................................................................................................................................... 4
4. INSTALLATION....................................................................................................................................................... 5
4.1. EMBEDDED IN CONCRETE (IN THE CHANNEL RECESS)........................................................................................ 5
4.2. FACE MOUNTED (IN EXISTING CHANNEL WITHOUT RECCESSES) ....................................................................... 6
4.3. WALL MOUNTED (AT THE END OF THE CHANNEL) ............................................................................................. 8
5. START-UP AND COMMISSIONING ....................................................................................................................... 10
6. OPERATION ........................................................................................................................................................ 11
7. MAINTENANCE................................................................................................................................................... 12
7.1. CLEANING AND LUBRICATION ........................................................................................................................ 12
7.2. SEAL REPLACEMENT: HORIZONTAL AND BOTTOM SEAL................................................................................... 13
7.3. SEAL REPLACEMENT: VERTICAL SEAL................................................................................................................ 14
8. TROUBLESHOOTING............................................................................................................................................ 15
9. ANNEX: CIVIL WORK TOLERANCES...................................................................................................................... 16
1. INTRODUCTION
This manual describes the recommended procedures for installation, operation, maintenance and safety
precautions for the following Orbinox equipment:
oSA Aluminum Stop Log
Please read thoroughly all the instructions in the manual prior to installation, and contact an Orbinox
representative in case of any questions.
The manual makes reference to the “General Arrangement Drawing” (GAD). The GAD is the drawing that is sent
to and approved by the customer prior to the production of the stop log. The manual shall be used in conjunction
with the GAD.
Orbinox assumes no responsibility or liability if the gate is not installed, operated and maintained in strict
accordance to the procedures described in this manual.

IOM MANUAL
SA ALUMINUM STOP LOG
www.orbinox.com
EDITION 12/2017
IOM-SA
2. EQUIPMENT MAIN COMPONENTS
ITEM
DESCRIPTION
1
FRAME
2
LOG
3
VERTICAL SEAL
4
BOTTOM SEAL
5
LATERAL GUIDE
6
LOG LOCKING SYSTEM
7
SEAL AND GUIDE LOCKING SYSTEM
8
INTERMEDIATE SEAL

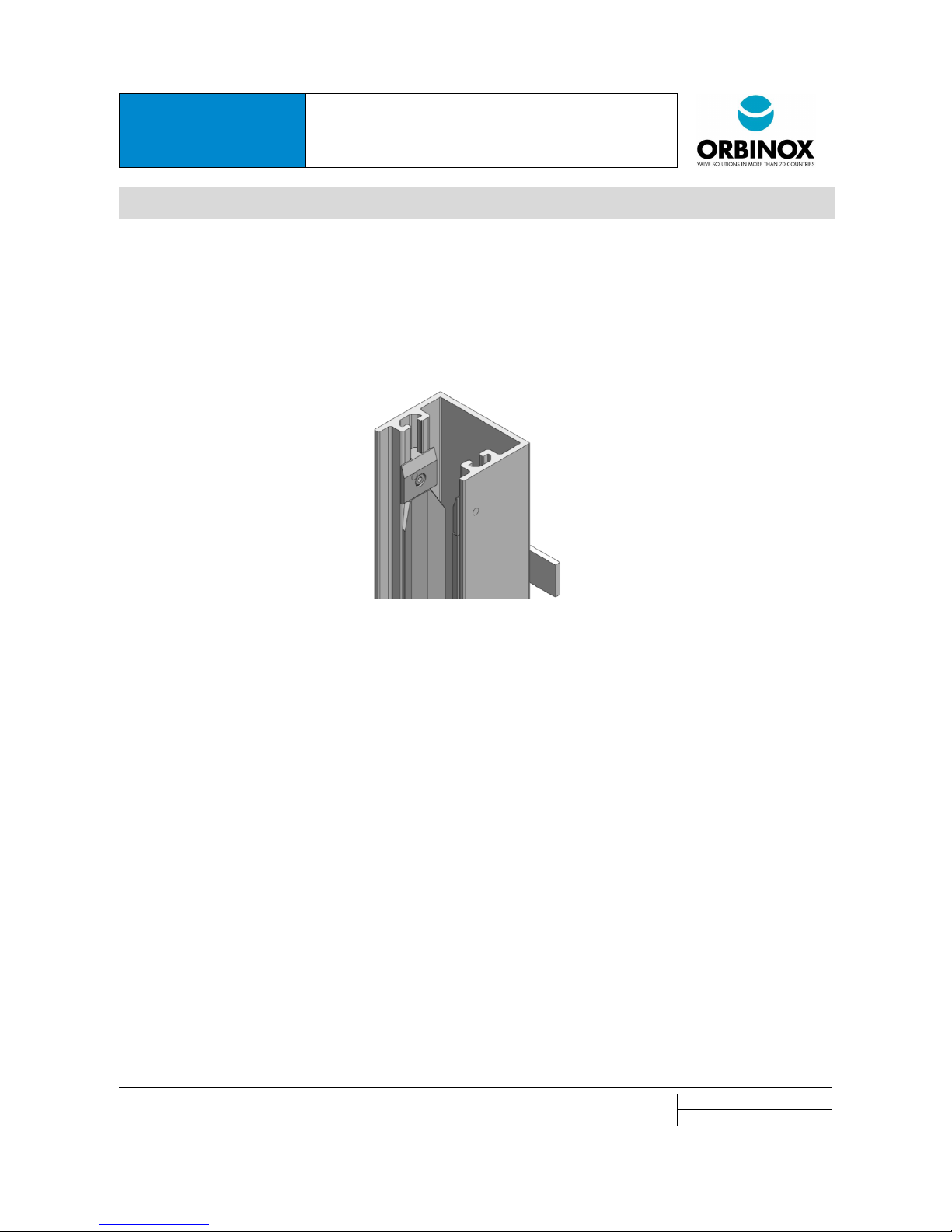

Figure 1: SA Stop Log

IOM MANUAL
SA ALUMINUM STOP LOG
www.orbinox.com
EDITION 12/2017
IOM-SA
3. HANDLING AND STORAGE
Handling
Standard safety procedures shall be followed to prevent personal injury or equipment damage.
The equipment shall be lifted from the main frame. For bigger gates, the frame comes with hoist rings specially
arranged for handling purposes.
Never lift the gates in the inverted position or from the log.
Storage
Check the equipment on delivery and report back to Orbinox any missing components within 3 days from receipt
of the equipment. Orbinox will not accept responsibility for loss or damage to any equipment which has occurred
after this period.
Some gates might be packed with wooden strips (or tensioning steel beams) between both frame guides. Do not
remove the strips/beams before the gate has been properly installed in order to avoid any damage or distortion to
the frame.
Equipment shall be stored in a dry, clean and even area on a raised even wood surface to prevent distortion of
the frame. Do not stack Stop Logs.

IOM MANUAL
SA ALUMINUM STOP LOG
www.orbinox.com
EDITION 12/2017
IOM-SA
4. INSTALLATION
This section describes the different installation methods (See section 4.1 to 4.3). Please refer to the GAD to identify
the installation method that is applicable to the purchased equipment.
The concrete construction shall be flat, level and plumb, and shall be in accordance to DIN 18202 or equivalent
ACI 117-06 standard (see Section 9). If necessary, use non-shrink grout in order to meet the specified standard.
The minimum concrete strength shall be 25 MPa (3,600 PSI).
The following procedures are general installation guidelines. Please refer to the notes on the GAD for specific
information about the installation method and the required materials (type, size and quantity of anchor bolts,
construction sealant, etc.). Always follow the anchor bolt and construction sealant manufacturers’ installation
instructions. Note that, typically, construction sealant requires dry concrete surfaces for its application.
Note that as standard, installation materials such as anchor bolts, hex-bolts and construction sealant are not
supplied with the equipment, unless otherwise specified.
4.1.EMBEDDED IN CONCRETE (IN THE CHANNEL RECESS)
Step 1: Initial assessment
Check that the concrete wall meets the requirements described in Section 4.
Verify that all installation materials specified on the GAD are available. Wooden wedges are used to center and
level the gate in the recess prior to embedding it in concrete.
Step 2: Frame alignment in the recess
Position and center the unit in the recess of the wall, using wooden wedges.
Align the unit vertically and make sure that the frame is flush with the invert
of the channel. The frame includes two threaded holes, which must be used to
secure vertical alignment supports (see Figure 3). Note that the supports are
not supplied, unless otherwise specified (two metal or wooden plates are
required).
Align the unit horizontally and make sure that the Frame Guide is flush with
the channel side wall. Additionally, make sure that the gate is perpendicular
to the side walls of the channel (See Figure 3). For aluminum frames, use
wooden wedges to center the unit in the recess. As an option, stainless steel
frames include “Lateral Centering Fittings”. In that case, adjust the hex bolts
for centering the frame.

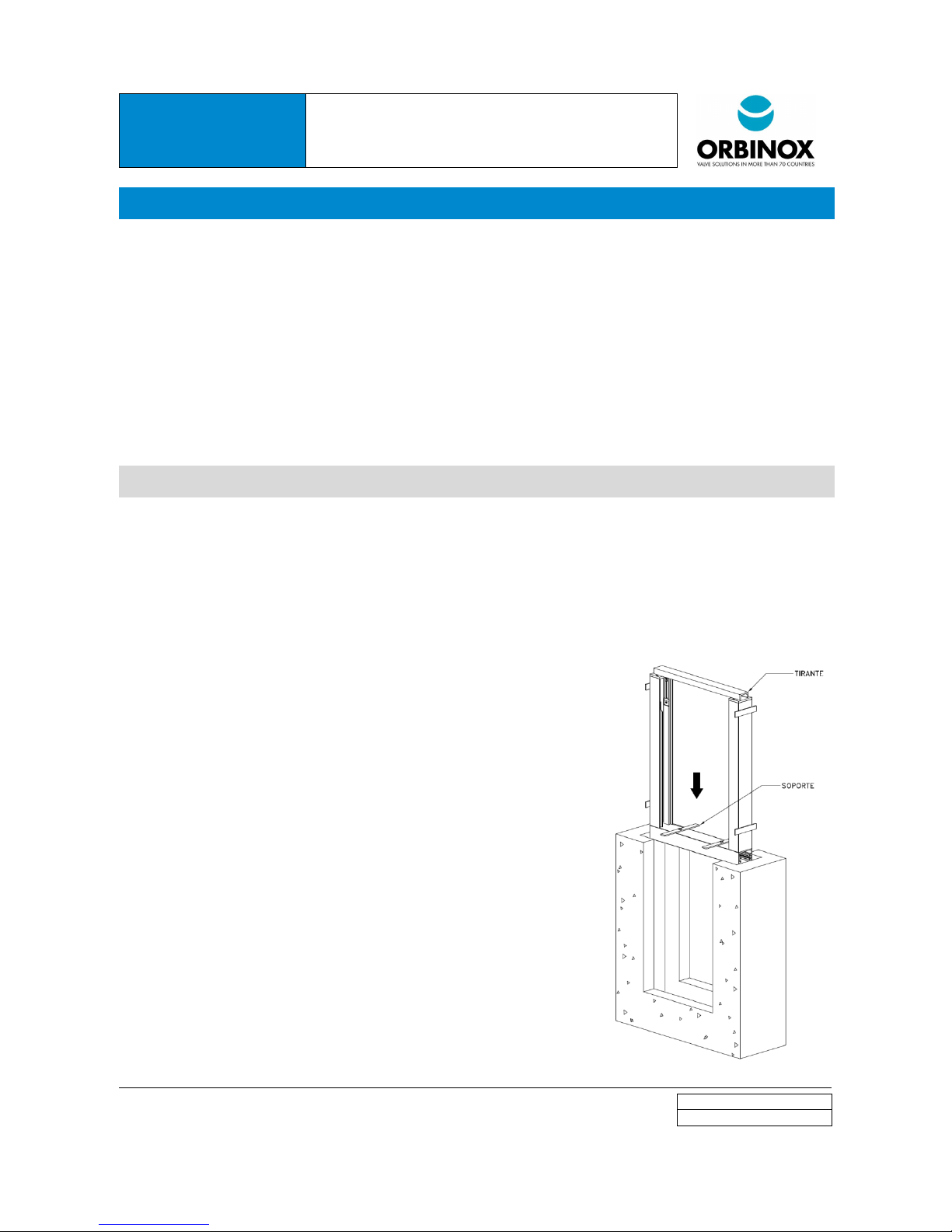

Step 3: Frame embedment in the wall recess
Pour the second phase of concrete. Take special care not to damage the
seals (see Figure 4).
Do not pour in more than one meter concrete columns to avoid damage to
the frame.
Remove the frame tensioning top beam if applicable.
Figure 2

IOM MANUAL
SA ALUMINUM STOP LOG
www.orbinox.com
EDITION 12/2017
IOM-SA

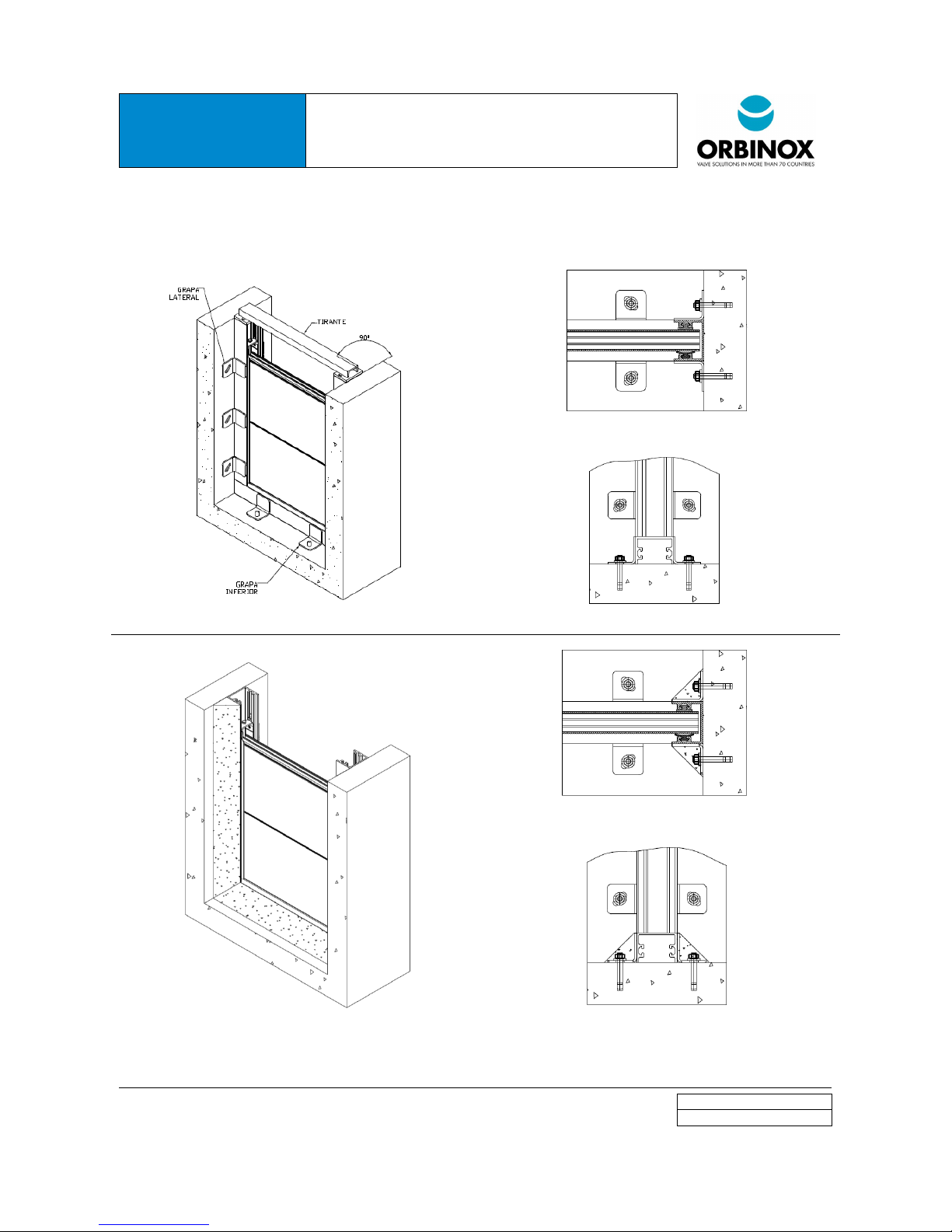

Figure 3
Figure 4
Figure 5
4.2.FACE MOUNTED (IN EXISTING CHANNEL WITHOUT RECCESSES)
Step 1: Initial assessment
Check that the concrete wall meets the requirements described in Section 4.
Verify that all installation materials specified on the GAD are available. Anchor bolts and grout are used for this
type of installation.
If the frame is made of aluminum, it is coated a special coating (PoliuretaneAP-3102-E distributed by Polifluor o
equivalent). If the frame is made of stainless steel, bolts that secure the vertical guides and seals must be greased
(on the outside) to avoid getting bonded to the concrete.
Step 2: Anchor the gate to the side of the channel
Position the unit in the existing channel. Make sure that the gate is perfectly aligned and centered in the channel
(see Figure 6).
Install the bottom anchor bolts, and then the lateral anchor bolts (see Figure 7). All Face Mounted Channel Gates
include lateral mounting
Step 3: Grout fill
Grout-fill the remaining voids (See Figure 9), both at the bottom (See Figure 8) and laterals of the gate (See Figure
7). Remember that the objective of the grout fill is twofold:
oFill the voids between the frame, frame invert and the channel.
oMake a smooth transition for water flow.

IOM MANUAL
SA ALUMINUM STOP LOG
www.orbinox.com
EDITION 12/2017
IOM-SA
CAUTION! Make sure not to get grout or any other foreign material on the gate’s seals, guides or stem as this may
cause leakage or damage.
Figure 6
Figure 7
Figure 8
Figure 9
Figure 10
Figure 11

IOM MANUAL
SA ALUMINUM STOP LOG
www.orbinox.com
EDITION 12/2017
IOM-SA
4.3.WALL MOUNTED (AT THE END OF THE CHANNEL)
Step 1: Concrete construction inspection
Check that the concrete wall meets the requirements described in Section 4.
Verify that all installation material specified on the GAD is available. The equipment is installed by means of
anchor bolts. Construction sealant shall be used between the frame and the concrete wall. Alternatively, sponge
EPDM rubber can be used.
Step 2: Equipment pre-installation
Present the unit to its required position and ensure that the invert of the frame is flush with the civils. Also make
sure that the equipment is centered with respect to the channel opening (See Figure 12).
Drill and install one anchor bolt on each side of the frame. After installing the first anchor bolt, and prior to
drilling the hole on the other side, make sure the frame is perfectly leveled.
Step 3: Construction sealant application
Remove the unit from the wall (first remove the nuts of the anchor bolts).
Apply construction sealant all around the perimeter of the frame. Be sure not to get sealant on the gate’s seals
and/or guides, as this may cause leakage or damage. (See Figure 13).
Re-install the slide gate on the wall and tighten both anchor bolts.
Step 4: Final installation
Drill and install the rest of the anchor bolts (See Figure 14).
CAUTION! If the unit is not completely in contact with the wall, do not over-tighten the anchor bolts. Over
tightening may bend or distort the frame. If the wall flatness and levelness is according to the specified standards,
the construction sealant will fill in the remaining voids.
Apply construction sealant around the frame perimeter in order to fill in any existing gap between the wall and
the frame (200ml/meter) Wipe away the excess sealant to leave a smooth finish.

IOM MANUAL
SA ALUMINUM STOP LOG
www.orbinox.com
EDITION 12/2017
IOM-SA
Figure 12
Figure 13
Figure 14

IOM MANUAL
SA ALUMINUM STOP LOG
www.orbinox.com
EDITION 12/2017
IOM-SA
5. START-UP AND COMMISSIONING
Do not operate the gate unless it is completely necessary. Typically the plant (i.e.: waste water treatment plant) has
not been finished when the commissioning occurs. Therefore, dust and dirt tends to accumulate on the seals and
stems. Do not apply extra grease on the seal and/or stem until the construction of the plant has been completely
finished as it forms a sticky paste with the dust. If the equipment needs to be operated previously wet the seals.
Clean the unit with clear water and make sure there are no foreign deposits or materials on the seals, guides or
sealing area. Use plastic tools to remove any foreign material in order not to contaminate the stainless steel
equipment.
Visual Inspection
Verify that all installation instructions defined in the GAD and the IOM manual have been followed.
Verify that the seal is in compression against the logs. Use a 0.5mm (1/32”) gauge.
Embedded In concrete installation:
oCheck that the frame (or other embedded parts) has not been distorted during installation. Measure the
opening width every 1 meter. The maximum deviation should be +-width/1000.
oVerify that the frame invert has been embedded in concrete.
Wall mounted at the end of the channel installation. Verify that there are no voids between the concrete wall and
the back of the frame (open the gate and look on the sides). No light must go through the frame and the wall. Clean
water can also be used to verify water tightness between the concrete wall and frame.
Face mounted in existing channel installation:
oCheck that the frame has not been distorted during installation. Measure the opening width every 1 meter.
The maximum deviation should be +-width/1000.
oCheck that the frame has been grouted as indicated in the GAD
Field Operational Test:
Before cycling the unit, make sure there are no foreign deposits or materials on the seals, guides or sealing area.
Clean the unit with clear water. Gate seals could be damaged if the area is not cleaned and coated with grease.
Please refer to Section 7.1 for detailed information.
Seals shall be wetted with clear water before operating the slide gate, and stems and stem nuts shall be greased.
Field Leakage Test
Close the slide and pressurize the unit at the design water head.
Collect the leaked water during a period of time of 10 minutes (LT10)
Calculate the leakage rate: LR(L/min and m) = LT10/(10*P), where P is the sealing perimeter in meters.

IOM MANUAL
SA ALUMINUM STOP LOG
www.orbinox.com
EDITION 12/2017
IOM-SA
6. OPERATION
Seals shall be wet while operating. If the slide gate has not been used for a long period of time under dry
conditions, the seals shall be wetted with clear water before operating the slide gate. Operating the gate with dry
seals may damage them, and additional thrust might be required to operate the slide. Please refer to section 7.1 for
detailed information about the required grease type.
The following equipment can be used to lift up the gate or logs:
oHand-pull: the slide or logs are equipped with handles. ORBINOX recommends the use of other methods
for pull out forces higher tan 50kg [110 pounds], or 25kg per person [55 pounds]. Refer to the GAD for
pull out force detailed information. Hand poles can be supplied for remote operation.
oExternal crane: the slide or logs are equipped with bull eyes to be lifted with an external crane.
Optionally, a lifting device (beam) can be supplied.

IOM MANUAL
SA ALUMINUM STOP LOG
www.orbinox.com
EDITION 12/2017
IOM-SA
7. MAINTENANCE
7.1.CLEANING AND LUBRICATION
Orbinox equipment is designed to give trouble free operation with minimum maintenance work. However, it is very
important to follow the next simple maintenance activities at the defined frequency to ensure an optimum
performance of the equipment.
Every six months or 100 cycles (whatever occurs first):
Visually inspect the unit for signs of misalignment, damage or corrosion. Also, verify that all parts are in place.
Clean the unit with clear water and remove any deposits, especially on the seals and guides.
Lightly grease all moving parts.
Check the seals and make sure they are not damaged. Seals shall be replaced if damaged (see section 7.2).
Check tightness of all unit assembly bolts and anchor bolts.
Spare parts: Orbinox does not recommend stocking any spare parts by the owner of the equipment. If a repair part
is required, please contact an Orbinox representative and provide the following information:
Orbinox sales order number.
GAD number.
Project name (if applicable) and vendor’s company name.
Materials needed for maintenance and seal replacement:
Material
Application
Type
Recommended
Grease
Seal and guides
Silica-Gel Silicone Grease
Vercol-Verkosil G-2
General purpose (seals, guides, threads) -
Drinking water applications
ACS and NSF61 approved Silicone Grease
Dow Corning-Molykote 111
WRAS approved Silicone-Grease
Rocol-Sapphire Aqua-sil High Load
Adhesive
Seal joints
Instant Adhesive
Loctite 406 or 495

IOM MANUAL
SA ALUMINUM STOP LOG
www.orbinox.com
EDITION 12/2017
IOM-SA
7.2.SEAL REPLACEMENT: HORIZONTAL AND BOTTOM SEAL
Each log includes two horizontal seals which are used to seal between logs. Additionally, some logs include a
separate bottom seal (only for the first log, please refer to the GAD).
Horizontal seal replacement
oStep 1: Remove the log from the frame (See Figure 15, part#2).
oStep 2: Remove the damaged seals and replace it by the new ones (See Figure 16, part#1). Add general
purspose Loctite to secure the seal in position.
Bottom seal replacement
oStep 3: Remove the first log from the frame.
oStep 4: Remove and replace the bottom seal (see Figure 18, part#3). Some logs include bolted bottom
seals (See Figure 17, part#4) by means of a stainless steel retainer (See Figure 17, part#5)
Figure 15
Figure 16
Figure 17
Figure 18

IOM MANUAL
SA ALUMINUM STOP LOG
www.orbinox.com
EDITION 12/2017
IOM-SA
7.3.SEAL REPLACEMENT: VERTICAL SEAL
Remove all logs from the frame.
Remove the “Seal and guide Locking System”.
Remove the vertical seals and replace by the new ones. For stainless steel frames, the seals are secured with
stainless steel retainers.
Secure the Locking System in position, making sure the seal is in compression against the bottom part of the
frame.
Figure 19

IOM MANUAL
SA ALUMINUM STOP LOG
www.orbinox.com
EDITION 12/2017
IOM-SA
8. TROUBLESHOOTING
SYMPTOM
CAUSE
SOLUTION
LEAKAGE (Between frame and
concrete wall, for Face Mounted In
Existing Channel Configuration)
Concrete Wall does not meet the
required tolerance specification
Uninstall unit, repair the concrete
wall and re-install the unit
Gaps between frame and face of
wall due to miss-application of
grout fill
Grout Fill remaining gaps
LEAKAGE (Leakage between frame
and concrete wall, for Wall Mounted
Configuration).
Concrete Wall does not meet the
required tolerance specification
Uninstall unit, repair the concrete
wall and re-install the unit
Insufficient construction sealant
(refer to the GAD)
Uninstall the unit, clean the
concrete wall, and apply new
construction sealant (refer to the
GAD for type and quantity).
Loose anchor bolts
Incorrect anchor bolts (refer to the
GAD)
Tighten anchor bolts
Install appropriate anchor bolts
(refer to the GAD for type and
quantity)
LEAKAGE (through the bottom seal
or between logs)
Foreign deposits trapped in
between the frame invert and bottom
seal or between logs
Open slightly the log(s) and
remove all foreign deposits. Check
if seals have been damaged.
Damaged bottom and/or horizontal
seal
Replace seal
Not enough compression between
logs
Adjust log locking system device
EXCESSIVE FORZE REQUIRED FOR
OPERATION
Dry seals
Wet seals

IOM MANUAL
SA ALUMINUM STOP LOG
www.orbinox.com
EDITION 12/2017
IOM-SA
9. ANNEX: CIVIL WORK TOLERANCES
X: opening width
Y: opening height
YY: invert to coping distance
DLx: linear deviation (with respect to X dimension)
DLy: linear deviation (with respect to Y dimension)
DLyy: linear deviation (with respect to YY dimension)
DAx: angular deviation (with respect to X dimension)
DAy: angular deviation (with respect to Y dimension)
DAy-z angular deviation (with respect to Y
dimension in z direction)
DAyy-z angular deviation (with respect to YY
dimension in z direction)
DFy: flatness deviation (with respect to Y dimension)
DFx: flatness deviation (with respect to X dimension)
DFyy: flatness deviation (with respect to YY
dimension)
Deviations shall be within the tolerances defined in DIN 18202:
Deviation
Maximun deviation
Linear deviation (DLx, DLy, DLyy):
DIN 18202, table 1, group 2 (for DLx and DLy)
DIN 18202, table 1, group 5 (for DLyy)
Angular deviation (DAx, DAy, Day-z, DAyy-z)
DIN 18202, table 2
Flatness deviation (DFx, DFy, DFyy)
DIN 18202, table 3, group 7
The following tables show the tolerances defined in DIN18202:
DIN 18202
TABLE 1
Group
Applicable to
Max. admissible deviation (mm) for target size (m)
<=1
>1 <=3
>3 <=6
>6 <=15
>15-<=30
>30
Linear deviation
Group 2
DLx, DLy
+-10
+-12
+-16
-
-
-
Group 5
DLyy
+-10
+-16
+-16
+-20
+-30
+-30
DIN 18202
TABLE 2
Group
Applicable to
Max. admissible deviation (mm) for target size (m)
<=0,5
>0,5 <=1
>1 <=3
>3 <=6
>6 <=15
>15-
<=30
>30
Angular deviation
DAx, DAy, Day-z, DAyy-z
3
6
8
12
16
20
30
DIN 18202
TABLE 3
Group
Applicable to
Max. admissible deviation (mm) for target size (m)
<0,1
>0,1 <=1
>1 <=4
>4 <=10
>4 <=10
Flatness deviation
Group 7
DFx, DFy, DFyy
2
3
8
15
20
Table of contents
Other Orbinox Other manuals
Popular Other manuals by other brands

Mercedes-Benz
Mercedes-Benz Conecto manual

Accel
Accel 59107 installation instructions

American Bath Factory
American Bath Factory Sistine Stone Neo Corner-Hnf installation guide

ActSafe
ActSafe ACX POWER ASCENDER quick start guide

ADEMCO
ADEMCO 5800RL Installation and setup guide

Sony
Sony PMW-500 Operation manual
