Parkeon StradaPAL User manual

Ref.: 504015710_1
StradaPAL
Rapide, Transfer and Cashless
Installation manual

StradaPAL –Installation manual
2/43
Copyright November 2013 Parkeon. All rights reserved.
Parkeon reserves all proprietary rights relating to the contents of this
document. Parkeon reserves all rights over usage, reproduction,
representation, marketing, translation, adaptation or modification, and
generally all rights over present and future utilisation by any means, for
any purpose and in any territory, throughout the period of protection. All
use of the contents of this document requires the express written
permission of Parkeon. Parkeon may change data, drawings and
descriptions of without prior notice. Certain characteristics can vary
according to customer specifications and do not represent a commitment
from Parkeon.
Parkfolio, EPSUM are trademarks belonging to Parkeon.
Parkeon S.A.S.
Parc La Fayette, 6 rue Isaac Newton, 25075 Besançon Cedex 9 - France
Tel: +33 (0)3 81 54 56 00 –Fax: +33 (0)3 81 54 49 96
Registered office: 100 avenue Suffren, 75015 Paris - France
Tel: +33 (0)1 58 09 81 10 –Fax: +33 (0)1 58 09 81 26
PARKEON, S.A.S with capital of € 30,382,146
Reg. 444 719 272 Paris
Printed in France.

StradaPAL –Installation manual
3/43
Contents
1. Safety ........................................................................................5
2. About this document…....................................................................8
3. Recommendations for terminal transport ............................................9
3.1 Transport and storage conditions ................................................... 9
3.2 Transport of terminals after they are taken off the transport pallets ........ 9

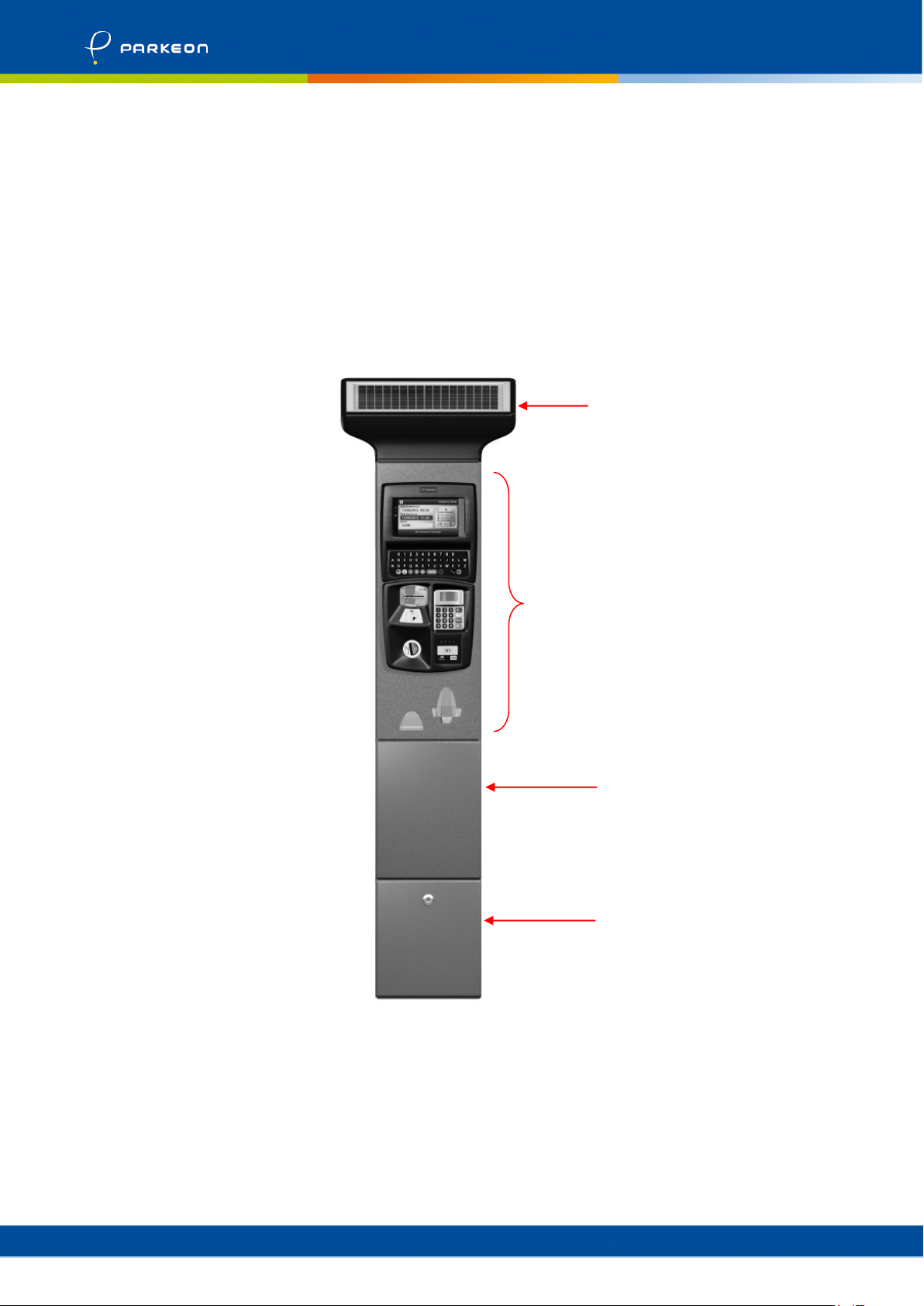

4. Description of the terminal............................................................ 10
4.1 Overview ............................................................................. 10
4.2 Dimensions and weight of the terminal .......................................... 11
5. Installation chart......................................................................... 12
6. Preparing the installation .............................................................. 13
6.1 Dimensions ........................................................................... 13
6.2 Mains supply cable passage (if present) ......................................... 14
7. Excavation anchoring ................................................................... 15
7.1 Earth work............................................................................ 15
7.2 Choice of installation height with excavation anchoring...................... 15
7.3 Equipment required (other than for construction work) ...................... 16
7.4 Anchoring in an excavation at minimum height ................................ 17
7.5 Anchoring in an excavation at variable height.................................. 19
8. Chemical anchoring on flat ground................................................... 22
8.1 Recommended ground .............................................................. 22
8.2 Equipment required................................................................. 22
8.3 Chemical anchoring on flat ground without base box ......................... 24
8.4 Chemical anchoring on flat ground with base box ............................. 26
9. Recommendations for anchoring protection ....................................... 28
10. Opening the maintenance door ....................................................... 29
11. Opening the power supply door ...................................................... 30
12. Taking the terminal off the pallet .................................................... 31
13. Terminal installation and levelling ................................................... 32
14. Final installation diagram and user interface height ............................. 33
14.1 Installation with excavation anchoring at minimum height................... 33
14.2 Installation with excavation anchoring and variable height .................. 34
14.3 Installation with chemical anchoring on flat ground without base box ..... 35
14.4 Installation with chemical anchoring on flat ground with base box ......... 36

StradaPAL –Installation manual
4/43
15. Installing the protective top and the antenna with or without zone indicator
37
16. Applying the stickers ................................................................... 39
17. Installing the batteries ................................................................. 40
17.1 Installing the mains battery (if present) .........................................40
17.2 Installing the solar batteries (if present)......................................... 41
18. Putting into service ..................................................................... 43

1 - Safety
StradaPAL –Installation manual
5/43
1. Safety
Parkeon products are designed to minimise risks to users and operators from electrical power
supplies, high temperature, fires, mechanical injuries, radiation and chemicals.
The product complies with the following directive:
Directive 2004/40/CE of the European Parliament and of the Council of 29 April 2004
on the minimum health and safety requirements regarding the exposure of workers to the
risks arising from physical agents (electromagnetic fields) (18th individual directive within
the meaning of article 16, paragraph 1, of Directive 89/391/EEC).
Take the basic precautions given below for the safety of personnel and the environment.The
list is not comprehensive and is only aimed at drawing your attention to the potential risks of poorly
performed work and negligence:
Any work on the product may only be performed by appropriately trained personnel. Only
correctly trained persons may work on the mains power supply.
Wear personal protective equipment appropriate for the type of work required.
Use appropriate tools that are in good condition, for the purpose for which they are
designed.
Mark out the anchoring system in the street while the concrete is setting in order to inform
others of the risk of obstruction. The marking may be as shown below, providing it is in
accordance with local regulations:
CE Marking - Europe
This product complies with CE marking regulations. The applicable directives depend on the radio
communication option:
With a radio communication option (GPRS, Wi-Fi, short-range device etc.)
The product complies with the following standards:
-Directive 1999/5/EC of the European Parliament and of the Council of 9 March 1999
on radio equipment and telecommunications terminal equipment and the mutual
recognition of their conformity.
-Council recommendation 1999/519/EC of 12 July 1999 on the limitation of
exposure of the general public to electromagnetic fields (0 Hz to 300 GHz).
Without the GPRS option:
The product complies with the following standards:
-Directive 2006/95/EC of the European Parliament and of the Council of 12
December 2006 on the harmonisation of the laws of Member States relating to
electrical equipment designed for use within certain voltage limits.
-Directive 2004/108/EC of the European Parliament and of the Council of 15
December 2004 on the approximation of the laws of the Member States relating to
electromagnetic compatibility and repealing Directive 89/336/EEC.
Canada
This product complies with the Canadian standard ICES-003 (Interference Causing Equipment
Standard).
D3979
D4136

1 - Safety
StradaPAL –Installation manual
6/43
Electricity
Any work on the product may only be performed by appropriately trained personnel.
Only correctly trained persons may work on the power supply.
Protect personnel from electrical shocks with the help of appropriate electrical and earth
connections.
Always switch off the power before beginning some repairs, as instructed in this guide.
Make sure that the electrical parts are installed in accordance with national standards.
Keep the mains power supply disconnected throughout these operations. Protect all
electrical wires from the rain. Never undertake repairs on equipment connected to the
mains or the telephone network during thunderstorms.
While repairing a circuit breaker installed in a machine, the main circuit breaker located in
an equipment room must be disconnected and a maintenance board is to be put up to
protect the worker from electric shocks.
Isolate the mains power supply with a cut-out and switch off the low voltage with the on/off
button of the main board.
Make sure that the earth cable is in good condition.
Follow the instructions relating to the earth connections of product components in order to
ensure compliance with EMC immunity and emissions standards.
The earth conductor that protects the power cable must be green and yellow.
Minimum section of the incoming mains cable: 2.5 mm² (AWG 12).
Depending on the country of installation, the equipment may be connected to a single-phase
230V IT network.
Ask for a signed certificate from the contractor.
Mechanical parts
Always remove any metal jewellery (rings, bracelets and wristwatches) before servicing the
electrical parts (power supply, battery, wiring) or beginning work on or close to moving
parts.
Keep your hands away from moving and sharp parts, door hinges and locks, wheels and
blades.
Take care not to hurt yourself with the open door or any other projecting parts or parts
fixed on the terminal.
Temperature
Always wait for a few minutes after turning the Pay & Display machine off before you start
working close to hot areas of the intermittent heating devices.

1 - Safety
StradaPAL –Installation manual
7/43
Dry cells/Batteries
Always take care to comply with the polarity of batteries and cells.
Do not obstruct the operating of the lithium cell of the main board. It may explode.
Never discard burn or open the buffer batteries or cells. Use appropriate disposal
procedures as recommended by the competent health and safety authorities. Comply with
the applicable local regulations while disposing of these items.
IMPORTANT: Parkeon shall not be liable in the event of any changes or incorrect use of
the Pay & Display machine other than as described in this document.
Environment
The product complies with the following standards:
Directive 2011/65/UE of the European Parliament and of the Council of 08 June 2011 on
the restriction of the use of certain hazardous substances in electrical and electronic
equipment.
Directive 2012/19/UE of the European Parliament and of the Council of 04 July 2012 on
Waste Electrical and Electronic Equipment (WEEE).
Disposal of used equipment
The presence of this symbol on a product or its packaging means that it may not be disposed of with
ordinary waste.
Products bearing this symbol require special treatment in accordance with European Directive
2012/19 on Waste Electrical and Electronic Equipment.

2 - About this document…
StradaPAL –Installation manual
8/43
2. About this document…
This document is intended for:
civil engineering and masonry personnel,
personnel responsible for installing and starting up the terminal.
It describes the procedure and provides advice for the correct and efficient
installation of a StradaPAL Transfer, Rapide and Cashless terminal.
Installation requires the simultaneous presence of a qualified electrician (for the
connections) and a maintenance agent (for the general installation of the
terminal).
These instructions reflect the procedure applicable on the date of publication.
The data and illustrations in this document are subject to change. Please check
with your Parkeon contact if your document is still valid.
The warranty on Parkeon equipment and software is dependent on compliance by
the customer with the transport, storage, installation, operation and
maintenance conditions set out by Parkeon in installation, operation and
maintenance manuals.
Please refer to the Operation manual for general instructions.
Please refer to the Maintenance manual for terminal initialisation,
troubleshooting and subassembly replacement.
Unless otherwise indicated, dimensions in this document are stated in
millimetres.

3 - Recommendations for terminal transport
StradaPAL –Installation manual
9/43
3. Recommendations for terminal transport
3.1 Transport and storage conditions
Tolerated transport and storage temperature: -40°C to +70°C
Tolerated humidity: up to 95% RH at 55°C
Solar radiation tolerated on the ground: 1120 kW/m² at +55°C
Follow the handling instructions below:
-transport the terminals in their original packaging,
-transport the terminals on their original pallets,
-do not put the terminals in the horizontal position,
-do not stack terminals,
-do not stack terminal pallets.
3.2 Transport of terminals after they are taken off the transport pallets
While moving terminals after they are taken off their transport pallets, Parkeon
recommends the use of trucks:
with star wheels in order to make it easier to move the terminal on the site
(climbing onto pavements etc.),
with a small base depth to make it easier to position the terminal on the
threaded rods.
Example: truck with star wheels
and small base depth
The terminal must be strapped onto the truck in order to keep it from tilting over.

4 - Description of the terminal
StradaPAL –Installation manual
10/43
4. Description of the terminal
4.1 Overview
The terminal comprises four main areas:
top,
area devoted to the user interface and maintenance,
collection compartment,
power supply compartment.
Collection
module
Power supply
module
Area devoted to users
and maintenance
Top
D9773

4 - Description of the terminal
StradaPAL –Installation manual
11/43
4.2 Dimensions and weight of the terminal
The terminal has the following dimensions:
The terminal weighs approximately 90 kg (without the battery - the weight may
vary depending on the optional equipment present).
D9776
379
328
275
D9775
290
475
226
1488
798
752
974
1120
1210
1336
90
or
180
(optional)
92.5

5 - Installation chart
StradaPAL –Installation manual
12/43
5. Installation chart
Opening the maintenance door
and the mains door
Preparing the installation
Anchoring
Taking the terminal off the pallet
Terminal installation and levelling
Installing the protective top
and the antenna
Installing the batteries

6 - Preparing the installation
StradaPAL –Installation manual
13/43
6. Preparing the installation
6.1 Dimensions
Make sure that there is sufficient space around the terminal to allow use by
maintenance agents and motorists:
20 cm at the rear and on the sides of the terminal,
1 metre in front of the terminal.
That means that the space stated below must be provided in relation to any
obstacles that may be present (walls, trees etc.):
Dimensions
from the centre of the base of the terminal
35 cm
Rear
35 cm
35 cm
115 cm

6 - Preparing the installation
StradaPAL –Installation manual
14/43
6.2 Mains supply cable passage (if present)
Carry out the required civil engineering works in order to route the cable in its
tube so that it arrives at the centre of the underside of the housing.
Recommended characteristics of the mains supply cable:
60 cm length available outside the anchoring in order to allow connection to
the electrical equipment.
Mains supply cable tube: 50 cm diameter.
Minimum mains supply cable section: 2.5 mm² (AWG 12).
Overview of the arrival of the tube at the centre of the housing:

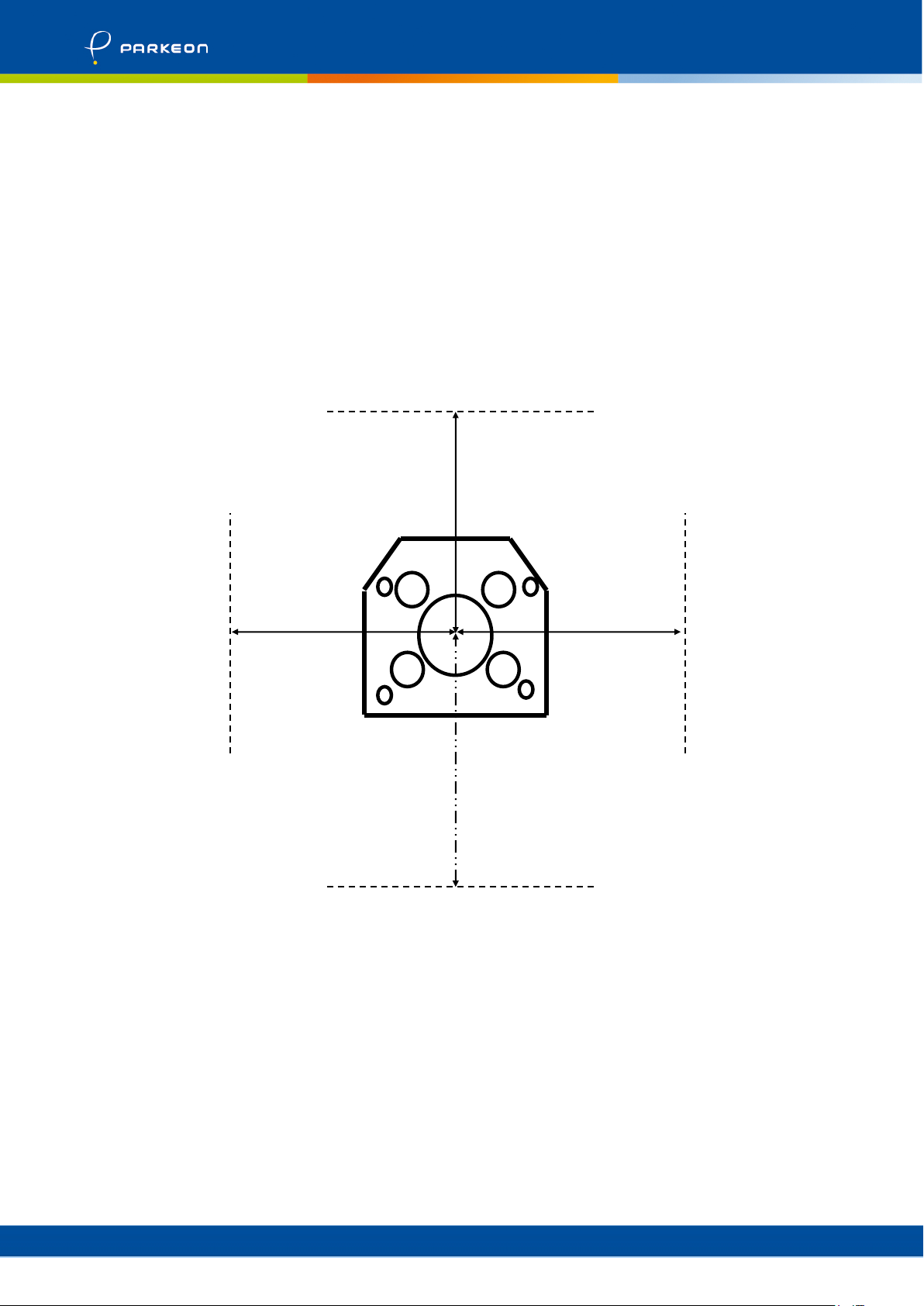

Terminal base (top view)
1
50
mm
90 mm
1: mains supply
cable tube

7 - Excavation anchoring
StradaPAL –Installation manual
15/43
7. Excavation anchoring
7.1 Earth work
Make a hole measuring 600 x 600 x 600 mm in accordance with the dimensional
constraints of the terminal specified in the relevant section.

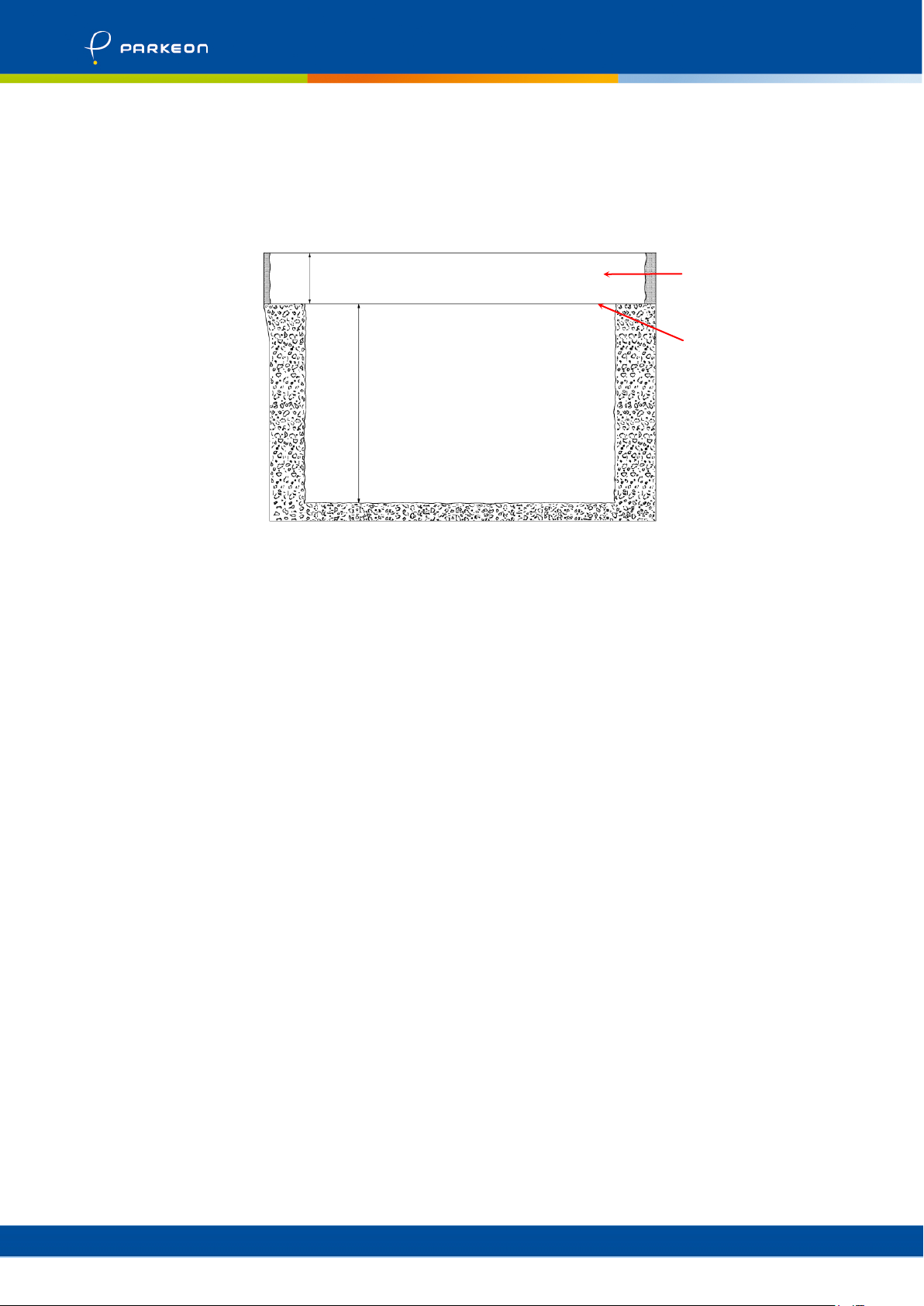

Sectional view of excavation hole
7.2 Choice of installation height with excavation anchoring
Excavation anchoring allows different terminal installation heights (base box buried
at variable depths):
For minimum installation height, the terminal is installed level with the
ground.
For variable-height installation, the terminal is raised in relation to the
ground.
The type of installation is to be chosen depending on the type of use: access to
persons with reduced mobility, etc.
For more details about the various installation heights, please refer to the section
"Final installation diagram and user interface height".
500
D6112
100
Top level of
concrete
Finishing:
pavement,
concrete etc.

7 - Excavation anchoring
StradaPAL –Installation manual
16/43
7.3 Equipment required (other than for construction work)
Tools required:
- rule,
- spirit level,
- excavation fastening kit,
- one or two removal protection nuts (optional).
Quantity

Description
Illustration
Excavation fastening kit
1
Pedestal
1
Form
16
M16 nut
4
M16 washer
4
M16 anchoring rod
(length: 500 mm)
1
Anchoring guard
plate
(for variable height
installation only)
Removal
protection
nuts
1 or 2
(optional)
Removal protection nut(s)
The removal protection nut (or nuts) is (are) not supplied with the
excavation fastening kit, but with the terminal.

7 - Excavation anchoring
StradaPAL –Installation manual
17/43
7.4 Anchoring in an excavation at minimum height
For this installation height (minimum height):
The form may be used but is not indispensable.
The anchoring guard plate is not used.
Fix the anchoring rods to the base box using 8x M16 nuts so that the ends of

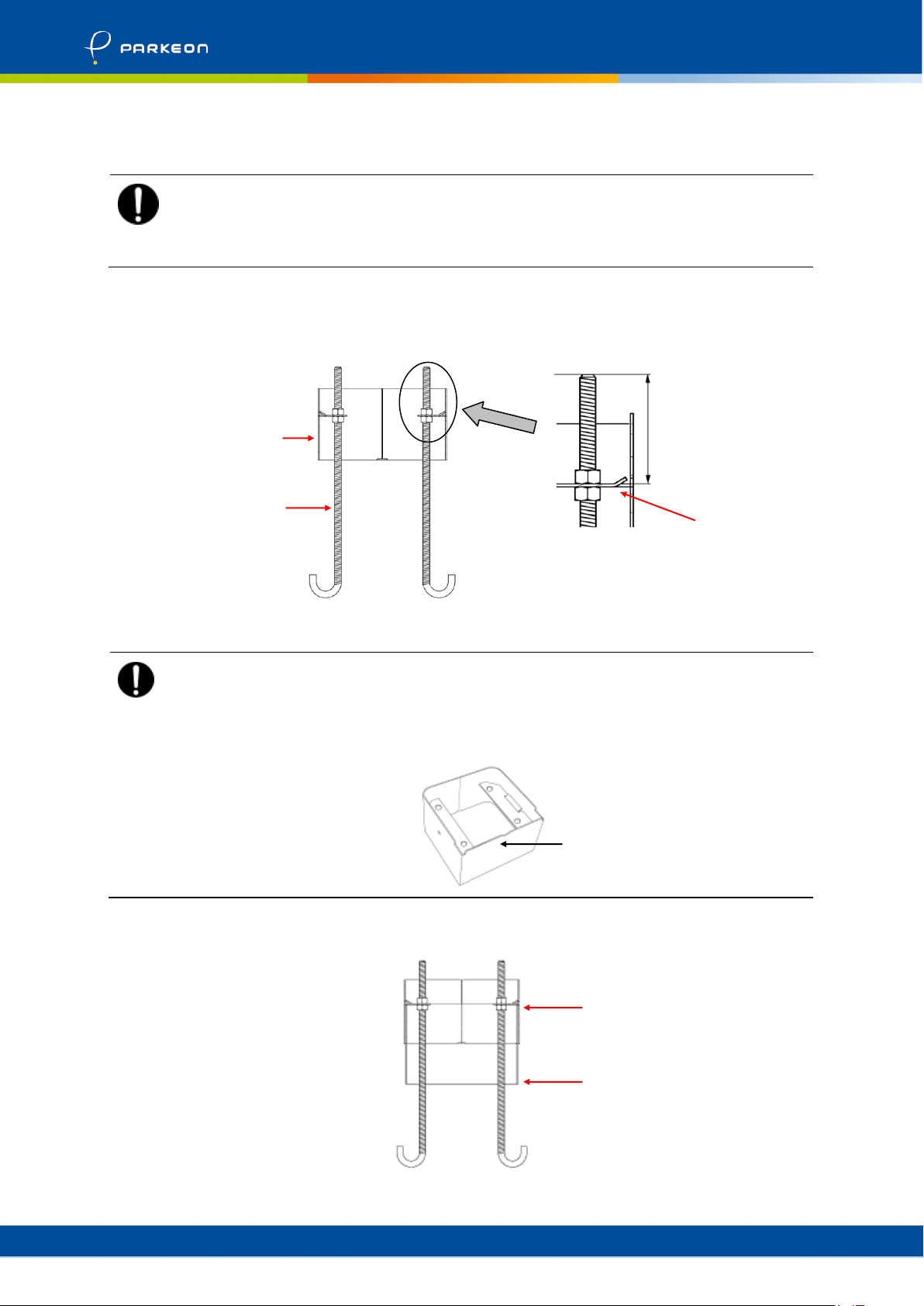

the rods are 104 mm away from the fastening brackets.
- The nuts are to be placed (104 mm away from the end of the anchoring rods)
as instructed for secure installation.
- Mind the positioning direction: the front of the base box must be placed
according to the direction of the terminal to be installed on it.
Put in place the form in the base box (if used).
Front of the base
box
Base
box
104+/- 1 mm
Anchoring
rod
D9729
Fastening
bracket
Base
box
Form
D8761

7 - Excavation anchoring
StradaPAL –Installation manual
18/43
Fill the hole with concrete (B25 quality as a minimum) over a height of
500 mm.
Set in the base box, pushing the anchoring rods into the concrete so that the
top of the base box is at the final ground level.
With the help of a spirit level, level the base box.
Fill the base box with concrete.
View of the base box in place before finishing
Comply with the setting time recommended by the concrete supplier.
Finish the ground (if the ground has a concrete or pavement finish, you need
not wait for the concrete to set).
Screw 4 nuts on the anchoring rods up to the base box.
These 4 nuts, which are used to level the terminal, are called
"lower nuts" in the rest of the procedure.
D8762

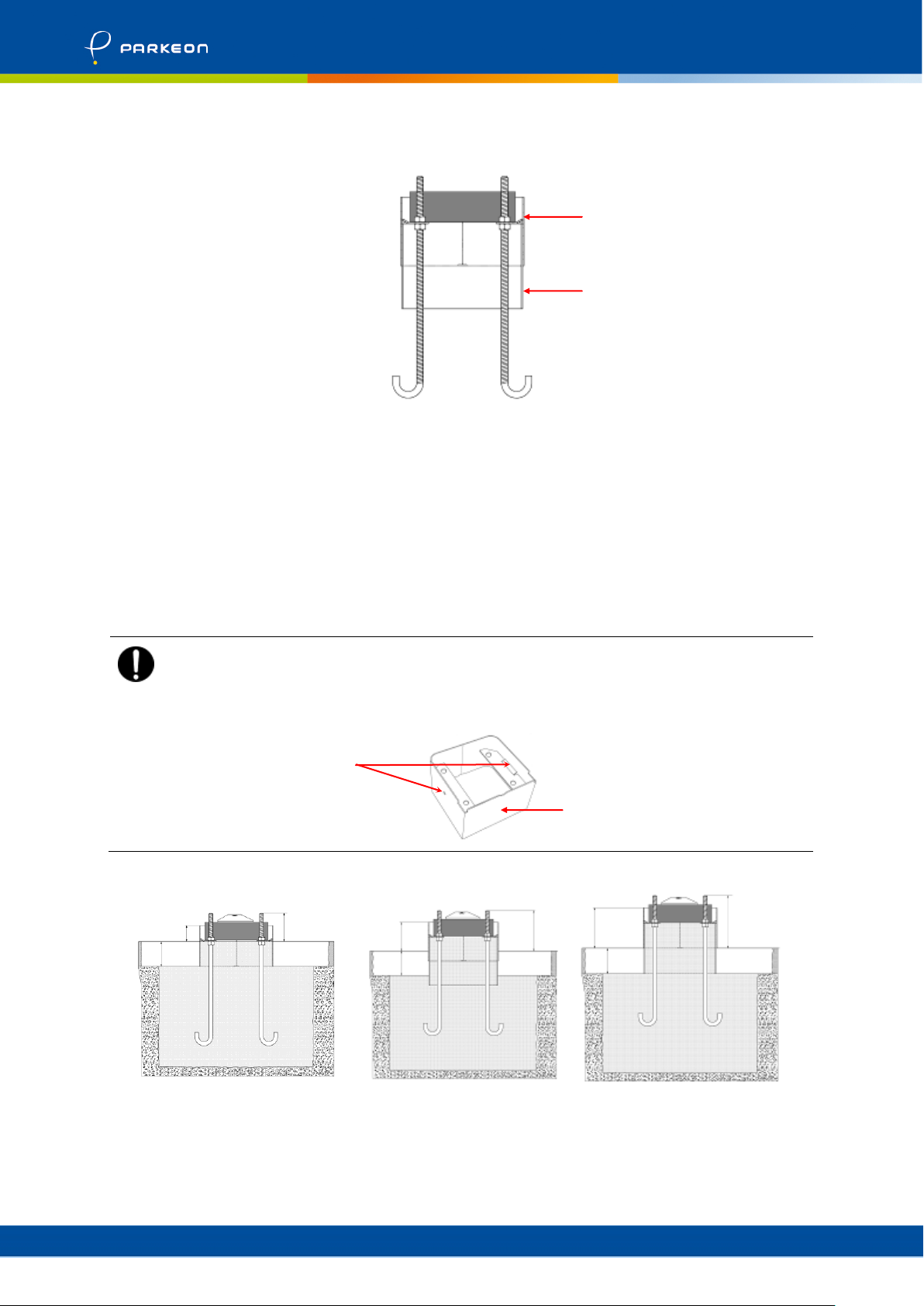

Final ground
level
500 mm
D8763
Finishing
Lower
nut

7 - Excavation anchoring
StradaPAL –Installation manual
19/43
7.5 Anchoring in an excavation at variable height
This type of installation makes it possible to raise the terminal by 41 to 137 mm
in relation to the height of the ground.
Installation at variable height:
The form may be used but is not indispensable.
The anchoring protection plate is required.
Install the protection plate in the base box, against the front.
Fix the anchoring rods to the base box using 8x M16 nuts so that the ends of
the rods are 104 mm away from the fastening brackets.
The nuts are to be placed (104 mm away from the end of the anchoring rods) as
instructed for secure installation.
Front of the base
box
Protection
plate
D9730
Base
box
104+/- 1 mm
Anchoring
rod
D9731
Fastening
bracket
Protection
plate

7 - Excavation anchoring
StradaPAL –Installation manual
20/43
Put in place the form in the base box (if used).
Fill the hole with concrete (B25 quality as a minimum) over a height of 500
mm.
Lower the base box to the required height (see examples below), pushing
the anchoring rods into the concrete.
With the help of a spirit level, level the base box.
Fill the base box with concrete (fill the base box according to its position in
the hole) and level it.
- Mind the positioning direction: the front of the base box must be placed
according to the direction of the terminal to be installed on it.
- Check that the holes for letting water out of the base box are not blocked.
Height 1
Height 2
Height 3

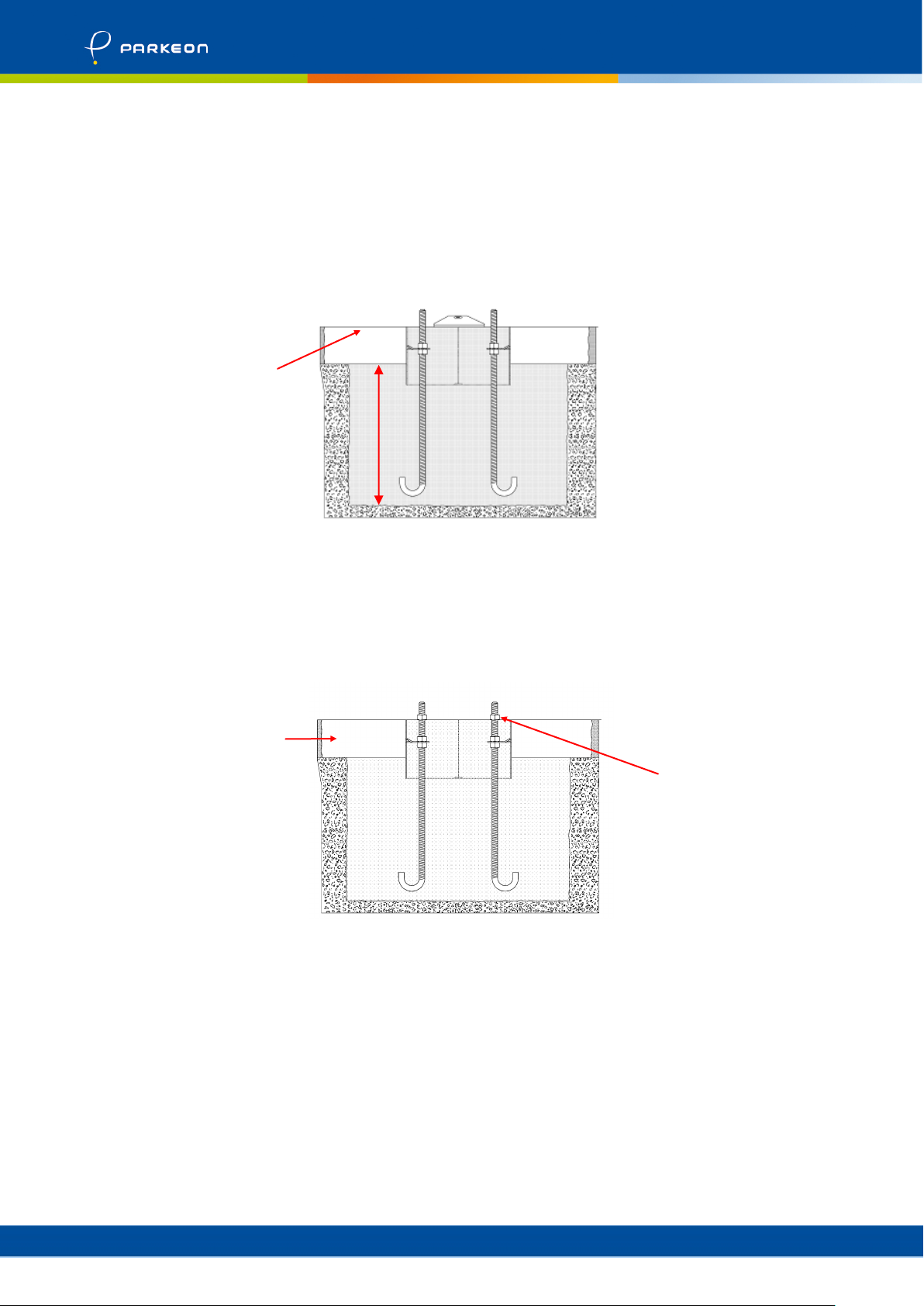

106
59
96
D8932
155
108
D8933
100
202
D8934
100
155
Base
box
Form
D8761
Front of the base
box
Draining holes
Table of contents
Other Parkeon Automobile Electronic manuals
