Advanced Air 0160 Series User manual

Due to continuous product development Advanced Air (U.K.) Ltd
reserves the right to change any information without prior notice.
Burrell Way,
Thetford, Norfolk,
IP24 3QU, England
Tel: +44 (0) 1842 753624
Fax: +44 (0) 1842 762032
Email: sales@advancedair.co.uk
0160 Series
Curtain Fire Dampers
Date Issue Spec. No. Page No.
13/01/15 Rev 4 CE –FD Sub
PATENT APPLIED FOR
1
Installation Damper/Model Classification
Blockwork
Wall
0160-Standard
Fire Damper E120 (ve i<—>o)
Drywall 0160-Standard
Fire Damper E120 (ve i<—>o)
Blockwork
Wall
2550- Motorised
Fire Dampers E120 (ve i<—>o) s
Drywall 2550- Motorised
Fire Dampers E120 (ve i<—>o) s
General Description
Construction Product Regulation
The 0160 series curtain fire dampers
are designed to stop the spread of fire
through ductwork, walls and floors in
ventilation systems. When the fusible
link reaches elevated temperature, it
releases interlocking blades closing
the damper by locking into the blade
ramp sealing the damper closed.
With the introduction of Construction
Product Regulation on the 1st July
2013 all fire dampers are required to
meet the product standard BS EN
15650. To achieve this standard the
damper has to be tested to BS EN
1366-2 dynamic fire test. The
dampers are then classified to BS EN
13501-3 that clearly states the
integrity of the damper also in the way
that damper was installed in the
furnace. The standard also now
included testing of fusible link to ISO
10294-4 that comprises of a dynamic
release and holding tests.
The biggest change in the current
Building regulations Part B and
Section 7 and the CPR is fire
dampers have to be CE marked and
that the dampers must be installed as
tested.
The maximum single section unit
tested was 1000mm x 1000mm for
both the HEVAC and AFS frame.
Sizes above the maximum will be
supplied as multi-section and are not
CE labelled due to the current issues
with the extended fields of application
that we will shortly have an answer
on.
To meet the requirements of the Construction
Products Regulation 1st July 2013 Advanced Air fire
dampers meet the requirements of the Product
Standard BS EN 15650 with a classification under BS
EN 13501-3 as stated in our Declaration Of
Performance that has been assessed by the notified
certification body BRE who have issued a Certificate
of Consistency of Performance No: 0832-CPR-
P0004.
(PATENT PENDING)

Due to continuous product development Advanced Air (U.K.) Ltd
reserves the right to change any information without prior notice.
Burrell Way,
Thetford, Norfolk,
IP24 3QU, England
Tel: +44 (0) 1842 753624
Fax: +44 (0) 1842 762032
Email: sales@advancedair.co.uk
0160 Series
Curtain Fire Dampers
Date Issue Spec. No. Page No.
13/01/15 Rev 4 CE –FD Sub
PATENT APPLIED FOR
2

Due to continuous product development Advanced Air (U.K.) Ltd
reserves the right to change any information without prior notice.
Burrell Way,
Thetford, Norfolk,
IP24 3QU, England
Tel: +44 (0) 1842 753624
Fax: +44 (0) 1842 762032
Email: sales@advancedair.co.uk
0160 Series
Curtain Fire Dampers
Date Issue Spec. No. Page No.
13/01/15 Rev 4 CE –FD Sub
PATENT APPLIED FOR
Blades: Material: 0.8 mm galvanised mild steel
Casing: Spigot Length: 50mm
Case length: 180mm
Material: 1.2mm galvanised mild steel.
Springs: Constant force springs made from heat treated stainless steel coil.
Ramps: 1.2 mm galvanised mild steel.
Fusible Link: 1.0 mm Brass soldered for release at 72°C –0/+2. Easy Maintenance Link for easy
testing and reset
Performance: Damper suitable for low, medium and high velocity casing (ductwork) leakage.
Spigotted Type – Class C DW144
Further Options: Easy maintenance link (EML) Release Mechanism Visual Positioner Indicator (VPI)
Micro switches
Note: Size limitations apply to some options, refer to chart
Product Details
Test House & Test Fire Test Integrity Classification BS EN 13501-3
Warrington No: 110372
Effectis No: R0345a
0160 HEVAC Frame In Blockwork
Wall
BS EN 1366-2 132 min E120 (ve i↔o)
Efectis - No. R0169a, R0169d
0160 HEVAC Frame In Floor BS EN 1366-2 132 min E120 (ho i↔o)
Effectis No: R0320a, R0320b
0160 AFS in Blockwork Wall BS EN 1366-2 132 min E120 (ve i↔o)
Effectis No: R0279a, R0279b
0160 AFS in Plasterboard BS EN 1366-2 60 min E60 (ve i↔o)
Effectis No:R0319a, R0319b
0160 AFS in Plasterboard BS EN 1366-2 132 min E120 (ve i↔o)
Fire Damper Testing Details
New AFS installation for Blockwork and Drywalls - (PATENT PENDING)
3
For Blockwork walls we had
to ensure there was no added
cost to the installation. The
unit design allowed the fixing
bracket to be on one side. In
testing the drop rods were
connected to a bracket
attached directly to the wall
therefore offering a simple
low cost site installation
For drywall installation both
options are available, drop
rods positioned within the
wall & drop rods positioned
outside the wall with the
fixing to the AFS brackets,
which have been successfully
tested to BS EN 1366-2

Due to continuous product development Advanced Air (U.K.) Ltd
reserves the right to change any information without prior notice.
Burrell Way,
Thetford, Norfolk,
IP24 3QU, England
Tel: +44 (0) 1842 753624
Fax: +44 (0) 1842 762032
Email: sales@advancedair.co.uk
0160 Series
Curtain Fire Dampers
Date Issue Spec. No. Page No.
13/01/15 Rev 4 CE –FD Sub
PATENT APPLIED FOR
4
Sizing Information — 0160 Damper With Rectangular Spigot & AFS Hanging System
———————————————————————————————————————————————————————————————-
Sizing Information — 0160 Damper With Rectangular Spigot & HEVAC/HVCA Installation Frame
Note;
Access Side Is Defined As The Side That Permits
Testing & Resetting Of The Damper (Without The
Need For Pull Rings To Unlock The Blade Pack)

Due to continuous product development Advanced Air (U.K.) Ltd
reserves the right to change any information without prior notice.
Burrell Way,
Thetford, Norfolk,
IP24 3QU, England
Tel: +44 (0) 1842 753624
Fax: +44 (0) 1842 762032
Email: sales@advancedair.co.uk
0160 Series
Curtain Fire Dampers
Date Issue Spec. No. Page No.
13/01/15 Rev 4 CE –FD Sub
PATENT APPLIED FOR
Minimum and Maximum Dimensions
Accessories Min & Max Dimensions Weights
5
1. The nett weights above are relevant to dampers using
AFS hanging system.
2. Where a HEVAC/HVCA installation frame is included, a
multiplier of 1.5 should be utilised.

Due to continuous product development Advanced Air (U.K.) Ltd
reserves the right to change any information without prior notice.
Burrell Way,
Thetford, Norfolk,
IP24 3QU, England
Tel: +44 (0) 1842 753624
Fax: +44 (0) 1842 762032
Email: sales@advancedair.co.uk
0160 Series
Curtain Fire Dampers
Date Issue Spec. No. Page No.
13/01/15 Rev 4 CE –FD Sub
PATENT APPLIED FOR

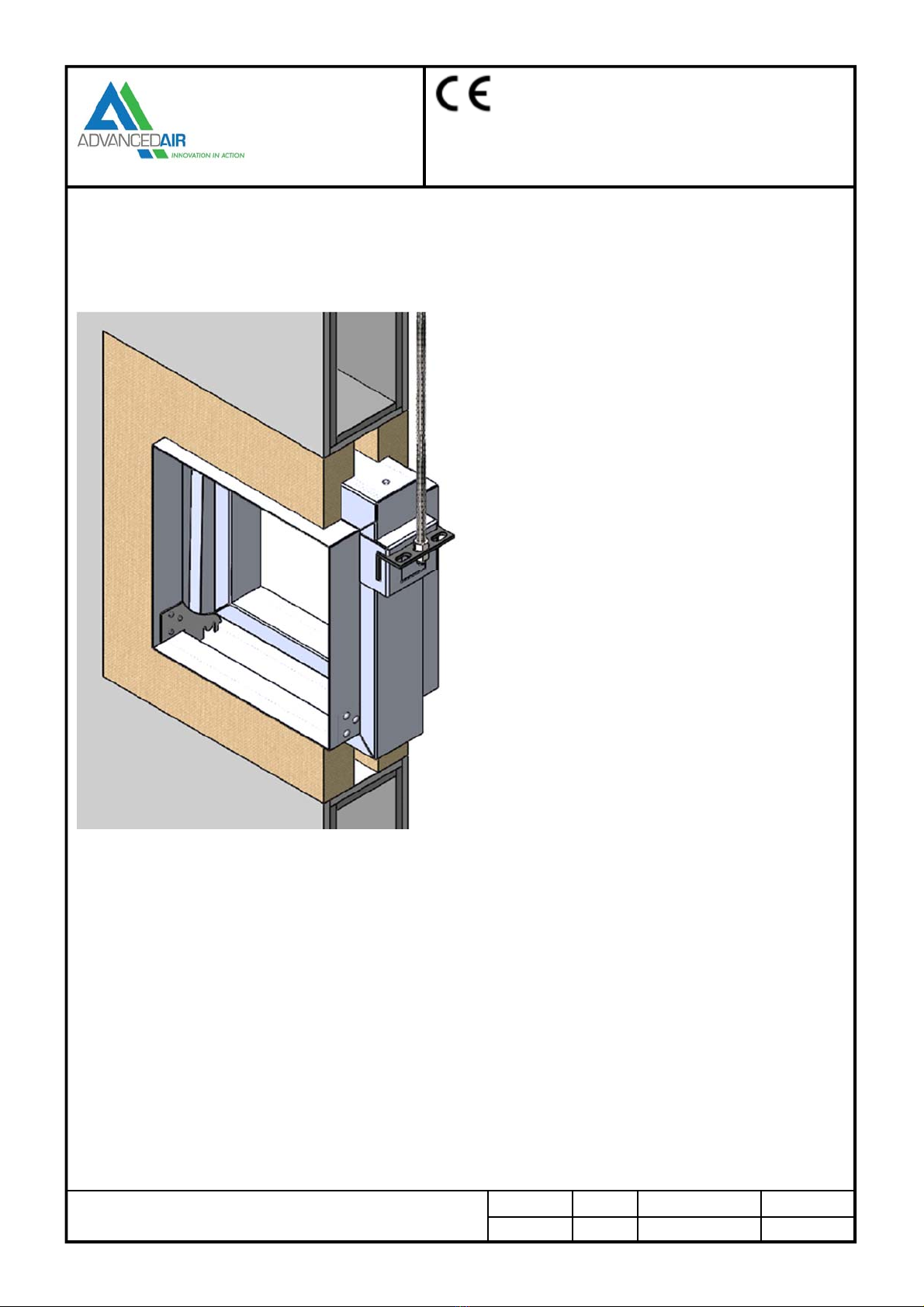

6
HEVAC Wall Installation - E120
Installation & Maintenance Instructions
Installation Procedure
1. Vertical builders work barrier to have an appropriately
sized lintel to ensure an opening clearance for the
expansion frame.
2. The opening in the wall must be cleaned, free of dust
and any other contaminants which could impair the
mortar adhesion. A clearance gap 25mm (min) to 50mm
(max) must be maintained around the expansion frame
of the fire damper (barrier contractor).
3. The damper shall be fitted centrally in the wall opening.
4. The tabs on the factory fitted galvanized steel expansion
frame shall be bent out to tie the damper into the wall
with the penetration seal.
5. The “Penetration Seal” must have a structural and fire
rated compatibility with both the barrier and the damper
and have sufficient strength to retain the fire damper
within the wall in a fire situation. (4:1 Mortar Mix).
6. The Mortar Mix will be applied up to the installation
frame face, take care not to leave any air pockets in the
mix.
7. The ductwork connecting to the damper spigots must
overlap by 40mm, leaving a 10mm clearance for any
duct expansion in a fire situation.
8. All ductwork connections must be sealed with an
approved ductwork sealer, and fixed with low resistance
fixings such as: aluminium alloy rivets or nylon bolts.
9. All connecting ductwork must be independently
supported within 1meter of the connections.
10. An Access cover should be fitted on the appropriate side
of the barrier to enable inspections and maintenance
work.
Pre Installation Notes
1. Ensure that the damper is kept in a clean dry
environment and that there is no damage to the damper.
2. Remove all packaging and transit ties before installation.
Maintenance Procedure
These dampers are installed as a life-safe product and will require regular physical and visual examinations. It is essential
that that the assembly is kept in a clean, dust free condition at all times.
It is essential that an access door has been provided in the adjacent ductwork to facilitate the inspection and maintenance.
Ensure that no physical restriction of the blades has occurred during the installation process.
Remove any dirt or debris built up in the damper, apply a little WD lubricant or light oil, any excessive oils should be wiped
away.
Check the operation of any ancillary products that may be fitted.
Examine the fusible link to ensure that no corrosion has occurred and that the plates are free from distortion and are in good
condition to operate when required.
Close the blade pack by manual operation and examine the blades to ensure;
They are in the fully closed position and have located in the ramps.
They are all position in the frame correctly i.e. square to the frame.
They are all in a clean condition.
The period between maintenance checks can best be ascertained by system conditions or as directed by local regulations
for ventilation plant and ancillaries, but should not exceed a maximum interval in excess of twelve months.
The report should be completed following the Maintenance Procedure included within this document.

Due to continuous product development Advanced Air (U.K.) Ltd
reserves the right to change any information without prior notice.
Burrell Way,
Thetford, Norfolk,
IP24 3QU, England
Tel: +44 (0) 1842 753624
Fax: +44 (0) 1842 762032
Email: sales@advancedair.co.uk
0160 Series
Curtain Fire Dampers
Date Issue Spec. No. Page No.
13/01/15 Rev 4 CE –FD Sub
PATENT APPLIED FOR
HEVAC Floor Installation - E120
Pre Installation Notes
1. Ensure that the damper is kept in a
clean dry environment and that there
is no damage to the damper.
2. Remove all packaging and transit ties
before installation.
Installation Procedure
1. The opening in the floor slab must be cleaned, free of dust and any other contaminants which could impair the mortar
adhesion. A clearance gap 25mm (min) to 50mm (max) must be maintained around the expansion frame of the fire
damper (barrier contractor).
2. The tabs on the factory fitted galvanized steel expansion frame will be bent out to tie the damper into the floor with the
penetration seal.
3. The damper should be fitted flush to the top edge of the opening.
4. The underside of the damper should be shuttered up with 25mm rigid rock wool Firebatt Min Density 140kg/m3 cut to
interference fit and supported from below, this must be left in situ.
5. The “Penetration Seal” must have a structural and fire rated compatibility with both the barrier and the damper and
have sufficient strength to retain the fire damper within the floor slab in a fire situation. (4:1 Mortar Mix).
6. Pour the Mortar Mix into the gap between damper and floor slab to half way and ensure all the small gaps are filled,
leaving no air pockets. Then pour the top layer up to the installation frame face smoothing off if necessary.
7. The ductwork connecting to the dampers long spigot must overlap by 40mm. The ductwork connecting to the short
spigot must overlap the spigot by 40mm, leaving 10mm clearance for any duct expansion in a fire situation.
8. All ductwork connections must be sealed with an approved ductwork sealer, and fixed with low resistance fixings such
as: aluminium alloy rivets or nylon bolts.
9. All connecting ductwork must be independently supported within 1meter of the connections.
Maintenance Procedure
These dampers are installed as a life-safe product and will require regular physical and visual examinations. It is essential
that that the assembly is kept in a clean, dust free condition at all times.
It is essential that an access door has been provided in the adjacent ductwork to facilitate the inspection and maintenance.
Ensure that no physical restriction of the blades has occurred during the installation process.
Remove any dirt or debris built up in the damper, apply a little WD lubricant or light oil, any excessive oils should be wiped
away.
Check the operation of any ancillary products that may be fitted.
Examine the fusible link to ensure that no corrosion has occurred and that the plates are free from distortion and are in good
condition to operate when required.
Close the blade pack by manual operation and examine the blades to ensure;
They are in the fully closed position and have located in the ramps.
They are all position in the frame correctly i.e. square to the frame.
They are all in a clean condition.
The period between maintenance checks can best be ascertained by system conditions or as directed by local regulations for
ventilation plant and ancillaries, but should not exceed a maximum interval in excess of twelve months.
The report should be completed following the Maintenance Procedure included within this document.
Installation & Maintenance Instructions
7

Due to continuous product development Advanced Air (U.K.) Ltd
reserves the right to change any information without prior notice.
Burrell Way,
Thetford, Norfolk,
IP24 3QU, England
Tel: +44 (0) 1842 753624
Fax: +44 (0) 1842 762032
Email: sales@advancedair.co.uk
0160 Series
Curtain Fire Dampers
Date Issue Spec. No. Page No.
13/01/15 Rev 4 CE –FD Sub
PATENT APPLIED FOR
8
AFS Drywall Installation
1 Hour - E60
(PATENT PENDING)
Maintenance Procedure
These dampers are installed as a life-safe product and will require regular physical and visual examinations. It is essential
that that the assembly is kept in a clean, dust free condition at all times.
It is essential that an access door has been provided in the adjacent ductwork to facilitate the inspection and maintenance.
Ensure that no physical restriction of the blades has occurred during the installation process.
Remove any dirt or debris built up in the damper, apply a little WD lubricant or light oil, any excessive oils should be wiped
away.
Check the operation of any ancillary products that may be fitted.
Examine the fusible link to ensure that no corrosion has occurred and that the plates are free from distortion and are in good
condition to operate when required.
Close the blade pack by manual operation and examine the blades to ensure;
They are in the fully closed position and have located in the ramps.
They are all position in the frame correctly i.e. square to the frame.
They are all in a clean condition.
The period between maintenance checks can best be ascertained by system conditions or as directed by local regulations for
ventilation plant and ancillaries, but should not exceed a maximum interval in excess of twelve months.
The report should be completed following the Maintenance Procedure included within this document.
Installation Procedure
1. The Drywall which will consist of two layers of 15mm
plasterboard each side of steel studwork with a 50mm
Rockwool insulation. The opening will be a letterbox
construction with overlapping layers of plasterboard with
an opening clearance of 25mm (min) - 100mm (max) all
around the fire damper casing (barrier contractor).
2. Two M10 drop rods per fire damper shall be fitted
centrally within the drywall fixed by steel anchors into the
slab or soffit above.
3. The damper should be fitted centrally in the wall opening
and hung by drop rods using the slotted rail and bolted
tight keeping the damper in the centre of the wall
opening.
4. The gap between the damper and the wall opening will
need filing in with 140kg/m3 50mm Firebatt cut to
interference fit and pushed in place.
5. The ductwork connecting to the damper spigots must
overlap by 40mm, leaving a 10mm clearance for any duct
expansion in a fire situation.
6. All ductwork connections must be sealed with an
approved ductwork sealer, and fixed with low resistance
fixings such as: aluminium alloy rivets or nylon bolts.
7. All connecting ductwork must be independently
supported within 1meter of the connections.
8. An Access cover should be fitted on the appropriate side
of the barrier to enable inspections and maintenance
work.
Pre Installation Notes
1. Ensure that the damper is kept in a clean dry
environment and that there is no damage to the damper.
2. Remove all packaging and transit ties before installation.
Installation & Maintenance Instructions

Due to continuous product development Advanced Air (U.K.) Ltd
reserves the right to change any information without prior notice.
Burrell Way,
Thetford, Norfolk,
IP24 3QU, England
Tel: +44 (0) 1842 753624
Fax: +44 (0) 1842 762032
Email: sales@advancedair.co.uk
0160 Series
Curtain Fire Dampers
Date Issue Spec. No. Page No.
13/01/15 Rev 4 CE –FD Sub
PATENT APPLIED FOR
Maintenance Procedure
These dampers are installed as a life-safe product and will require regular physical and visual examinations. It is essential
that that the assembly is kept in a clean, dust free condition at all times.
It is essential that an access door has been provided in the adjacent ductwork to facilitate the inspection and maintenance.
Ensure that no physical restriction of the blades has occurred during the installation process.
Remove any dirt or debris built up in the damper, apply a little WD lubricant or light oil, any excessive oils should be wiped
away.
Check the operation of any ancillary products that may be fitted.
Examine the fusible link to ensure that no corrosion has occurred and that the plates are free from distortion and are in good
condition to operate when required.
Close the blade pack by manual operation and examine the blades to ensure;
They are in the fully closed position and have located in the ramps.
They are all position in the frame correctly i.e. square to the frame.
They are all in a clean condition.
The period between maintenance checks can best be ascertained by system conditions or as directed by local regulations for
ventilation plant and ancillaries, but should not exceed a maximum interval in excess of twelve months.
The report should be completed following the Maintenance Procedure included within this document.
Pre Installation Notes
1. Ensure that the damper is kept in a clean dry
environment and that there is no damage to the damper.
2. Remove all packaging and transit ties before installation.
Installation Procedure
1. The Drywall which will consist of two layers of 15mm
plasterboard each side of steel studwork with a 50mm
Rockwool insulation. The opening will be a letterbox
construction with overlapping layers of plasterboard with
an opening clearance of 25mm (min) - 100mm (max) all
around the fire damper casing (barrier contractor).
2. Two M10 drop rods per fire damper shall be fitted on one
side of the drywall fixed by steel anchors into the slab or
soffit above.
3. The damper should be fitted flush to the one side of the
wall opening and hung by drop rods using the slotted rail
and bolted tight keeping the damper within the wall
opening.
4. The gap between the damper and the wall opening will
need filing in with 140kg/m3 50mm Firebatt cut to
interference fit and pushed in place.
5. The ductwork connecting to the damper spigots must
overlap by 40mm, leaving a 10mm clearance for any duct
expansion in a fire situation.
6. All ductwork connections must be sealed with an approved
ductwork sealer, and fixed with low resistance fixings such
as: aluminium alloy rivets or nylon bolts.
7. All connecting ductwork must be independently supported
within 1meter of the connections.
AFS Drywall Installation
1 Hour - E60
(PATENT PENDING)
Installation & Maintenance Instructions
9

Due to continuous product development Advanced Air (U.K.) Ltd
reserves the right to change any information without prior notice.
Burrell Way,
Thetford, Norfolk,
IP24 3QU, England
Tel: +44 (0) 1842 753624
Fax: +44 (0) 1842 762032
Email: sales@advancedair.co.uk
0160 Series
Curtain Fire Dampers
Date Issue Spec. No. Page No.
13/01/15 Rev 4 CE –FD Sub
PATENT APPLIED FOR
AFS Blockwork Installation -
2 Hour - E120
(PATENT PENDING)
Maintenance Procedure
These dampers are installed as a life-safe product and will require regular physical and visual examinations. It is essential
that that the assembly is kept in a clean, dust free condition at all times.
It is essential that an access door has been provided in the adjacent ductwork to facilitate the inspection and maintenance.
Ensure that no physical restriction of the blades has occurred during the installation process.
Remove any dirt or debris built up in the damper, apply a little WD lubricant or light oil, any excessive oils should be wiped
away.
Check the operation of any ancillary products that may be fitted.
Examine the fusible link to ensure that no corrosion has occurred and that the plates are free from distortion and are in good
condition to operate when required.
Close the blade pack by manual operation and examine the blades to ensure;
They are in the fully closed position and have located in the ramps.
They are all position in the frame correctly i.e. square to the frame.
They are all in a clean condition.
The period between maintenance checks can best be ascertained by system conditions or as directed by local regulations for
ventilation plant and ancillaries, but should not exceed a maximum interval in excess of twelve months.
The report should be completed following the Maintenance Procedure included within this document.
Pre Installation Notes
1. Ensure that the damper is kept in a clean dry
environment and that there is no damage to the damper.
2. Remove all packaging and transit ties before installation.
Installation Procedure
1. Vertical builders work barrier to have an appropriately
sized lintel and opening clearance for the fire damper and
Firebatt.
2. The opening in the wall must be cleaned, free of dust and
any other contaminants which could impair the acrylic
sealant. A clearance gap of 25mm (min) - 100mm (max)
gap for the Firebatt must be maintained around the fire
damper (barrier contractor).
3. The damper shall be mounted so that the supported side
of the damper is flush with the wall opening. It shall be
hung by M10 drop rods using the slotted rail and bolted
tight to steel anchors in the slab or soffit above.
4. The gap between the damper and the wall opening will
need filing in with 3 layers of 140kg/m3 50mm Firebatt cut
to interference fit and pushed in place.
5. All joints and gaps shall be sealed using intumescent
Acrylic Sealant.
6. The ductwork connecting to the damper spigots must
overlap by 40mm, leaving a 10mm clearance for any duct
expansion in a fire situation.
7. All ductwork connections must be sealed with an
approved ductwork sealer, and fixed with low resistance
fixings such as: aluminium alloy rivets or nylon bolts.
8. All connecting ductwork must be independently supported
within 1meter of the connections.
9. An Access cover should be fitted on the appropriate side
of the barrier to enable inspections and maintenance
work.
Installation & Maintenance Instructions
10

Due to continuous product development Advanced Air (U.K.) Ltd
reserves the right to change any information without prior notice.
Burrell Way,
Thetford, Norfolk,
IP24 3QU, England
Tel: +44 (0) 1842 753624
Fax: +44 (0) 1842 762032
Email: sales@advancedair.co.uk
0160 Series
Curtain Fire Dampers
Date Issue Spec. No. Page No.
13/01/15 Rev 4 CE –FD Sub
PATENT APPLIED FOR
AFS Drywall Installation
2 Hour - E120
(PATENT PENDING)
Maintenance Procedure
These dampers are installed as a life-safe product and will require regular physical and visual examinations. It is essential
that that the assembly is kept in a clean, dust free condition at all times.
It is essential that an access door has been provided in the adjacent ductwork to facilitate the inspection and maintenance.
Ensure that no physical restriction of the blades has occurred during the installation process.
Remove any dirt or debris built up in the damper, apply a little WD lubricant or light oil, any excessive oils should be wiped
away.
Check the operation of any ancillary products that may be fitted.
Examine the fusible link to ensure that no corrosion has occurred and that the plates are free from distortion and are in good
condition to operate when required.
Close the blade pack by manual operation and examine the blades to ensure;
They are in the fully closed position and have located in the ramps.
They are all position in the frame correctly i.e. square to the frame.
They are all in a clean condition.
The period between maintenance checks can best be ascertained by system conditions or as directed by local regulations for
ventilation plant and ancillaries, but should not exceed a maximum interval in excess of twelve months.
The report should be completed following the Maintenance Procedure included within this document.
Pre Installation Notes
1. Ensure that the damper is kept in a clean dry
environment and that there is no damage to the damper.
2. Remove all packaging and transit ties before installation.
Installation Procedure
1. The Drywall which will consist of two layers of 15mm
plasterboard each side of steel studwork with a 50mm
Rockwool insulation. The opening will be a letterbox
construction with overlapping layers of plasterboard with
an opening clearance of 25mm (min) - 100mm (max) all
around the fire damper casing (barrier contractor).
2. Two M10 drop rods per fire damper shall be fitted centrally
within the drywall fixed by steel anchors into the slab or
soffit above.
3. The damper should be fitted centrally in the wall opening
and hung by drop rods using the slotted rail and bolted
tight keeping the damper in the centre of the wall opening.
4. The gap between the damper and the wall opening will
need filing in with 140kg/m3 50mm Firebatt cut to
interference fit and pushed in place.
5. A closure face board of 15mm plasterboard is screwed to
each side of the wall, it must fully cover the Firebatt and
overlap the opening by 50mm.
6. The ductwork connecting to the damper spigots must
overlap by 40mm, leaving a 10mm clearance for any duct
expansion in a fire situation.
7. All ductwork connections must be sealed with an approved
ductwork sealer, and fixed with low resistance fixings such
as: aluminium alloy rivets or nylon bolts.
8. All connecting ductwork must be independently supported
within 1meter of the connections.
Installation & Maintenance Instructions
11

Due to continuous product development Advanced Air (U.K.) Ltd
reserves the right to change any information without prior notice.
Burrell Way,
Thetford, Norfolk,
IP24 3QU, England
Tel: +44 (0) 1842 753624
Fax: +44 (0) 1842 762032
Email: sales@advancedair.co.uk
0160 Series
Curtain Fire Dampers
Date Issue Spec. No. Page No.
13/01/15 Rev 4 CE –FD Sub
PATENT APPLIED FOR
Installation Safety Information
The installation of Fire Dampers must be done by competent trained persons who are familiar with
the type of product. They should follow the following essential safety practices:
Wear appropriate PPE gloves, footwear, safety hat etc. comply with the safety policies of the
particular site.
Ensure that access to the installation position has been made safe and is suitable for the
handling of the damper.
Use correct manual handling techniques when moving the damper, use team lifting techniques
when installing large dampers.
If lifting equipment is used; inspect the condition of the equipment before using it.
12

Due to continuous product development Advanced Air (U.K.) Ltd
reserves the right to change any information without prior notice.
Burrell Way,
Thetford, Norfolk,
IP24 3QU, England
Tel: +44 (0) 1842 753624
Fax: +44 (0) 1842 762032
Email: sales@advancedair.co.uk
0160 Series
Curtain Fire Dampers
Date Issue Spec. No. Page No.
13/01/15 Rev 4 CE –FD Sub
PATENT APPLIED FOR
13

Due to continuous product development Advanced Air (U.K.) Ltd
reserves the right to change any information without prior notice.
Burrell Way,
Thetford, Norfolk,
IP24 3QU, England
Tel: +44 (0) 1842 753624
Fax: +44 (0) 1842 762032
Email: sales@advancedair.co.uk
0160 Series
Curtain Fire Dampers
Date Issue Spec. No. Page No.
13/01/15 Rev 4 CE –FD Sub
PATENT APPLIED FOR
Operation / Task Result
Damper reference
Date of inspection
Check actuator wiring for damage (where applicable)
Check end-switch wiring for damage (where applicable)
Check damper for cleanliness and clean where necessary
Check the condition of the blades and seals, rectify and report where
necessary
Confirm the safety closure operation of the fire damper according to
the manufacturer’s instructions
Confirm operation of the damper to OPEN and CLOSE by use of
physical observation of the damper, rectify and report where neces-
sary
Confirm operation of OPEN and CLOSED end-switches, rectify and
report (where necessary)
Confirm that the damper fulfills its function as part of the control sys-
tem (where necessary)
Confirm that the damper is left in its normal working position
Maintenance Report
14
Other manuals for 0160 Series
1
Table of contents
Other Advanced Air Fire And Smoke Damper manuals
Popular Fire And Smoke Damper manuals by other brands

actionair
actionair SmokeShield PTC Installation, operating, & maintenance instructions

Trox Technik
Trox Technik EK2-EU-FF installation manual

GILBERTS
GILBERTS SMOKEGARD manual

Mandik
Mandik SEDS-L manual

mercor
mercor mcr WIP PRO Technical manual

VENCO
VENCO ES Series Installation, operation and maintenance manual

KOOLAIR
KOOLAIR SAFEAIR BDK60 Technical documentation

KOOLAIR
KOOLAIR CCR Series manual

mercor
mercor mcr LAM Operation and maintenance manual

Trox Technik
Trox Technik VFR Assembly and operating instructions

SOLID AIR
SOLID AIR FD Series product manual

Maico
Maico BSB VC Series Installation, Operating and Maintenance Instruction
