DCM SOLUTION ESV710 User manual

Versión: 1.0 05/01/2021
DCM Solution S.A.
Sanitizing tunnel
ESV710
Installation Manual
All information contained in this document, including illustrations and specifications are reliable
at the date of its publication but is subject to change without notice.

Sanitizing tunnel ESV710
www.dcm.com.ar Installation Manual Page.: 2of20
© 2021 DCM Solution S.A.
This publication or any part thereof, must not be reproduced or transmitted in
any form or by any means, electronic or mechanical, including photocopying,
recording, storage in an information retrieval system, or otherwise, without the
prior written permission of DCM Solution SA.
The information contained in this manual, including illustrations and
specifications, has been carefully checked and is reliable as of the date of its
publication but is subject to change without prior notice.
DCM Solution S.A., assumes no liability for any inaccuracy, error or omission in
this manual.
Under any circunstances, DCM Solution S.A., will be liable for direct, indirect,
special, incidental or consequential damages resulting from any defect or
omission of this manual, even if the possibility of damage was advised.
In the interest of product development, DCM Solution S.A., reserves the right to
make improvements to this manual and the products described at any time,
without prior notice or obligation.
2021 –Sanitizing tunnel ESV710–Installation Manual
.

Sanitizing tunnel ESV710
www.dcm.com.ar Installation Manual Page.: 3of20
Table of contents
1Introduction _______________________________________________ 4
2Object description__________________________________________ 4
2.1 General _______________________________________________ 4
2.2 Technical specification __________________________________ 4
2.2.1 Standard characteristics _______________________________ 4
2.2.2 Optionals___________________________________________ 4
2.2.3 Models ____________________________________________ 4
2.2.4 Electric power supply _________________________________ 5
2.2.5 Electric consumption__________________________________ 5
2.2.6 Environmental conditions ______________________________ 5
2.2.7 Weight_____________________________________________ 5
2.2.8 Dimensions_________________________________________ 6
3Technical information_______________________________________ 7
3.1 Location of the components______________________________ 7
4Installation________________________________________________ 8
4.1 Required tools _________________________________________ 8
4.2 Preliminary work on site _________________________________ 8
4.3 Unpacking_____________________________________________ 9
4.4 Assembly ____________________________________________ 12
5Wiring___________________________________________________ 15
5.1 Pre requisites _________________________________________ 15
5.2 Power supply _________________________________________ 15
6Start up__________________________________________________ 16
6.1 Filling the tank ________________________________________ 16
6.2 Purge________________________________________________ 16
6.3 Pressure valve ________________________________________ 17
7Operation________________________________________________ 18
8Maintenance _____________________________________________ 19
8.1 Spray nozzle cleaning __________________________________ 19
8.2 Platform draining ______________________________________ 20
8.3 Principal tank draining _________________________________ 20

Sanitizing tunnel ESV710
www.dcm.com.ar Installation Manual Page.: 4of20
1 Introduction
Please carefully read this manual which contains information that will assist you
in the operation and commissioning of the unit.
2 Object description
2.1 General
The ESV is a sanitizing tunnel for supermarket carts that allows a quick
sanitization to provide users hygienic safety before starting their purchases.
2.2 Technical specification
2.2.1 Standard characteristics
SAE1010 epoxy painted Steel cabinet
Exposure time from 6 to 10 sexonds
Capacity of more than 500 cars/hour
2 rows of 4 industrial spray nozzles with anti-drip
1 liquid tank 45liters
System consumption: 10 liters per 2500 cars
Pressurizing unit
Low voltaje supply
Easy installation and operation
Does not include sanitizing liquid
It MUST be used with sanitizing products approved by an oficial entity
2.2.2 Optionals
Stainless steel cabinet
Automatic ignition by presence sensor
2.2.3 Models
ESV710 : SAE 1010 painted with epoxy sanitizing tunnel for supermaket
carts
ESV711 : Stainless steel sanitizing tunnel for supermarket carts

Sanitizing tunnel ESV710
www.dcm.com.ar Installation Manual Page.: 5of20
2.2.4 Electric power supply
Voltage
12VDC @ 5A
2.2.5 Electric consumption
Electric consumption
50 W max
2.2.6 Environmental conditions
Operating Temperature
+0 °C to +40 °C
Storage Temperature
-10 °C to +55 °C
Relative Humidity
95% non-condensible maximum
2.2.7 Weight
Weight
250 Kg

Sanitizing tunnel ESV710
www.dcm.com.ar Installation Manual Page.: 6of20
2.2.8 Dimensions
Characterist
mm
Length
1290
Width
1320
Height
1480

Sanitizing tunnel ESV710
www.dcm.com.ar Installation Manual Page.: 7of20
3 Technical information
3.1 Location of the components

Sanitizing tunnel ESV710
www.dcm.com.ar Installation Manual Page.: 8of20
4 Installation
4.1 Required tools
Industrial hammer drill
10mm Widia Solid CarbideDrill for concrete
4 10mm expansion metal plugs (type FISCHER steel MR10).
14 and 17mmwrench.
Mm Hexkey set.
Please carefully read all sections before starting the installation.
4.2 Preliminary work on site
Verify the position and location of the equipment according to the general
installation.
Depending on the area of installation of the equipment, there are two posible
variants.
1. If the floor is concrete, the installation can be carried out, with the help of
steel or chemical drills, by placing the drills in a position that matches
with the anchoring holes of the cabinet, either by means of the
installation plane or with a template.
2. In all the cases where the floor is not concrete, the installation should be
done on a bulk head plate. It must be made with threaded rods ØM10,
according to the installation blueprint, and tacked to the existing ground
with cement. It has to be 10cm below the level of the floor. It must also
be taken into account in this instance, that the threaded rods that are part
of the plate exceed the level of the floor by 5 cm.
Check that the floor or concrete base where the cabinets will be mounted is
even and leveled +/- 5mm in the area of attachment of the cabinets.

Sanitizing tunnel ESV710
www.dcm.com.ar Installation Manual Page.: 9of20
4.3 Unpacking

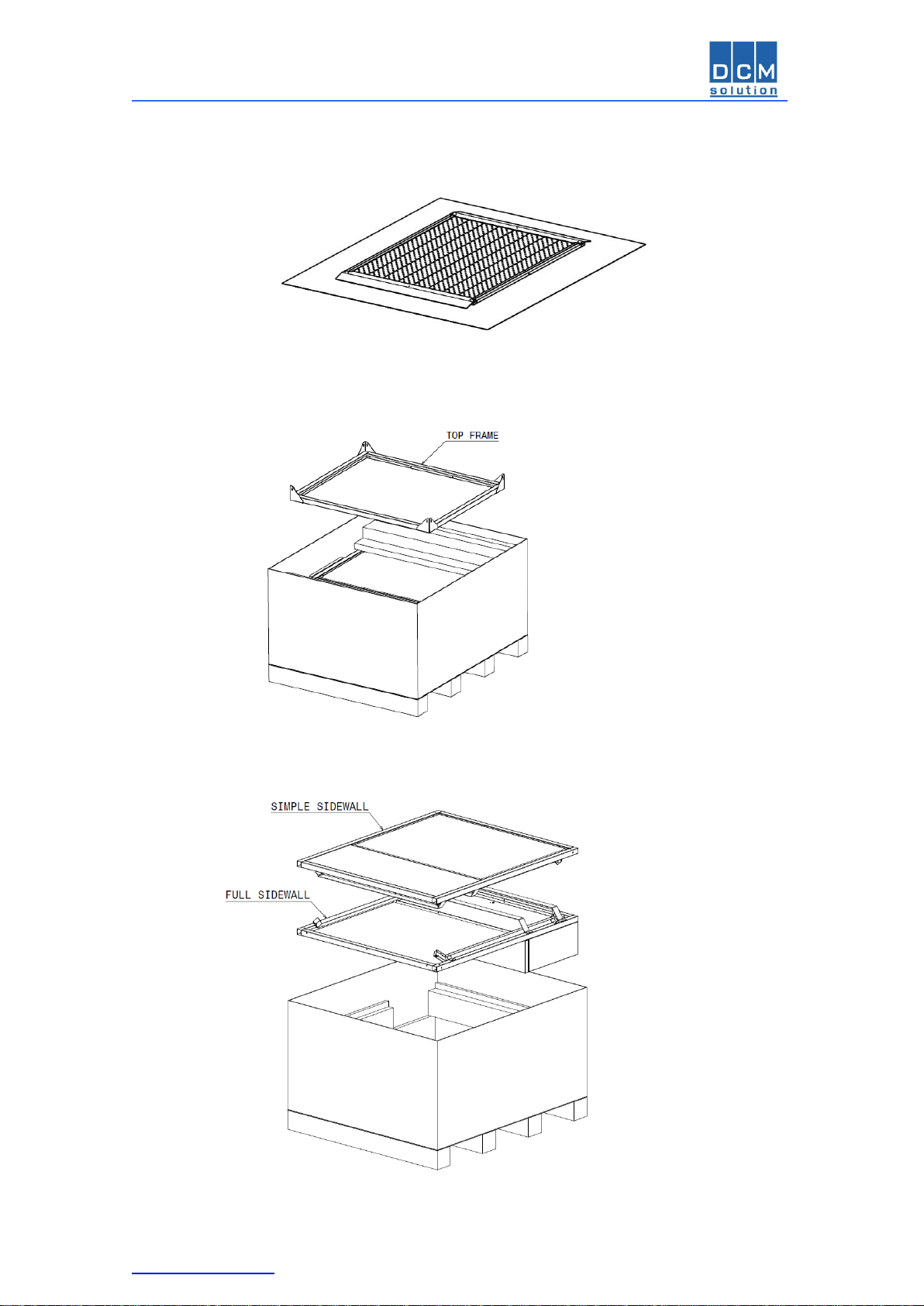

1. Place the package on the floor without turning it around.
2. Take the upper cover off.
3. Remove the styrofoam and grasp the platform.

Sanitizing tunnel ESV710
www.dcm.com.ar Installation Manual Page.: 10of20
4. Place the platform where the sanitizer will be installed.
5. Take the ceiling out of the box and leave it aside.
6. Remove the sidewalls from the box.
7. Discard packaging.

Sanitizing tunnel ESV710
www.dcm.com.ar Installation Manual Page.: 11of20
NOTE: You will find each item in its position. For each step you will have to
unscrew it, put the part and screw it back.

Sanitizing tunnel ESV710
www.dcm.com.ar Installation Manual Page.: 12of20
4.4 Assembly
1. Join the sidewalls to the platform as shown in the illustrations and
screw.

Sanitizing tunnel ESV710
www.dcm.com.ar Installation Manual Page.: 13of20
2. Place the ceiling in position and screw.
3. Take the hoses located at each inferior corner of the top frame and
connect them to their respective coupling.

Sanitizing tunnel ESV710
www.dcm.com.ar Installation Manual Page.: 14of20
To connect the hose to the coupling push the blue part of the coupling and hold
it down while inserting the hose.
4. Connect the draining hose coming out from the full sidewall to the
platform ecoupling.

Sanitizing tunnel ESV710
www.dcm.com.ar Installation Manual Page.: 15of20
5 Wiring
5.1 Pre requisites
For equipment a power supply of 12Vdc 5Amp (not provided) should be used.
For greater electrical safety of the installation it is necessary to comply with the
following:
Power to equipmentmust come from an electrical board (not
provided).
The electric panel must be equipped with:
oConnection terminal block.
oCircuit Breaker.
o10A termal key.
oHave an excellent land fill.
5.2 Power supply

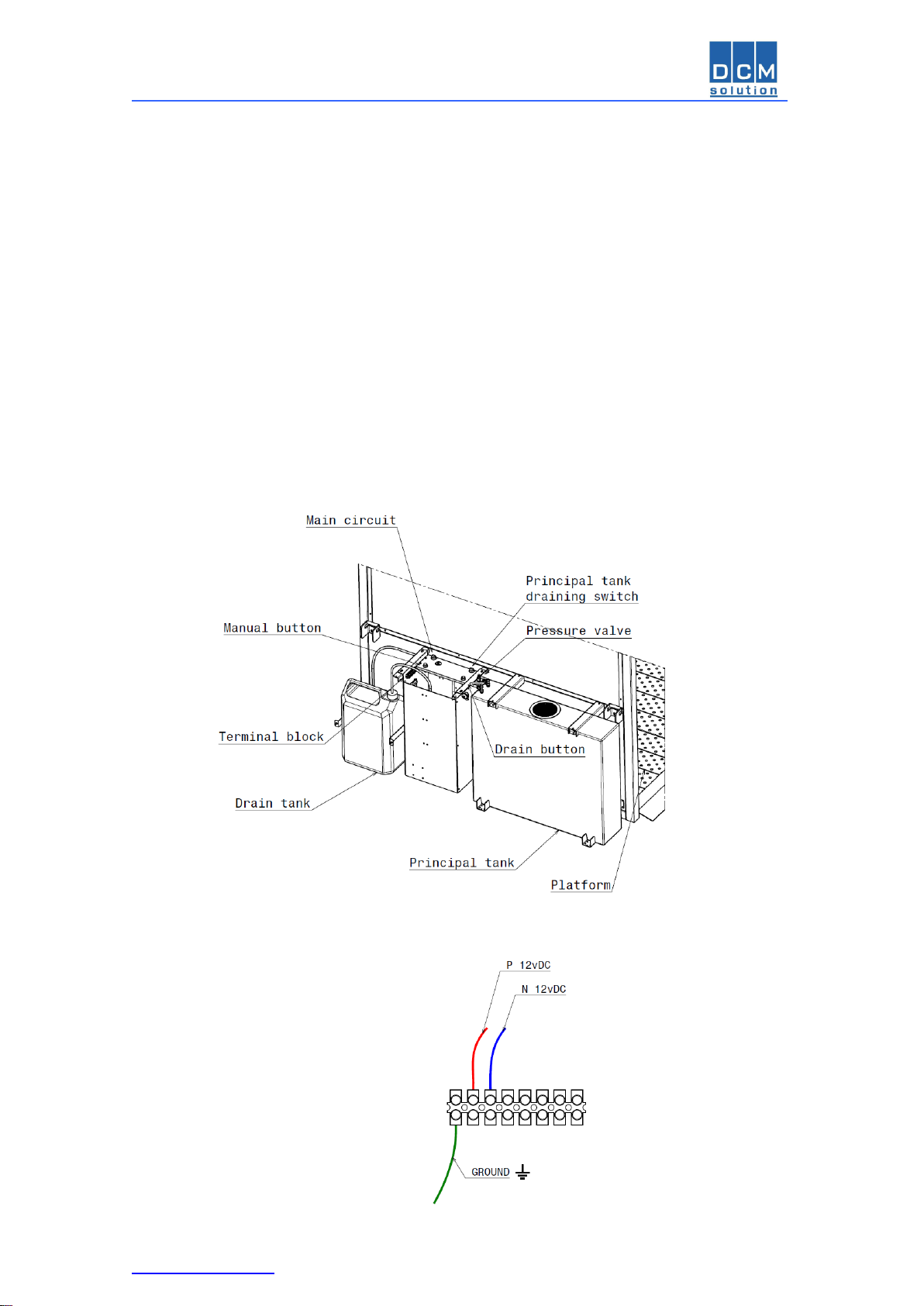

1. Open the full sidewall's door and identify the terminal block.
2. Connect the electric supply to the terminal block as shown in the
illustration.

Sanitizing tunnel ESV710
www.dcm.com.ar Installation Manual Page.: 16of20
6 Start up
6.1 Filling the tank
Fill the tank directly through the filter placed on the top of the tank.
6.2 Purge
Connect the unit to the power source with 12vDC.
Check if the main circuitis in the same position as shown in the image.
Hold down the manual button, do not release until liquid comes from each of the
8 spray nozzles.

Sanitizing tunnel ESV710
www.dcm.com.ar Installation Manual Page.: 17of20
6.3 Pressure valve
In case of willing to correct the pressure, you can change it through the
pressure valve as shown in the pressure valve page.

Sanitizing tunnel ESV710
www.dcm.com.ar Installation Manual Page.: 18of20
7 Operation
Put the carton the platform and push the ON/OFF button. Wait until it finishes or
press the button again to stop it manually. Spraying duration: 7 seconds.

Sanitizing tunnel ESV710
www.dcm.com.ar Installation Manual Page.: 19of20
8 Maintenance
8.1 Spray nozzle cleaning
1. Pull out the nozzle from the product while holding down the blue part.
1. Disassemble the nozzle very carefully as it has tiny components
inside.
2. Clean all the components (Do not use chemical solvents).
3. Put back in position.
4. Repeat with all of the nozzles.

Sanitizing tunnel ESV710
www.dcm.com.ar Installation Manual Page.: 20of20

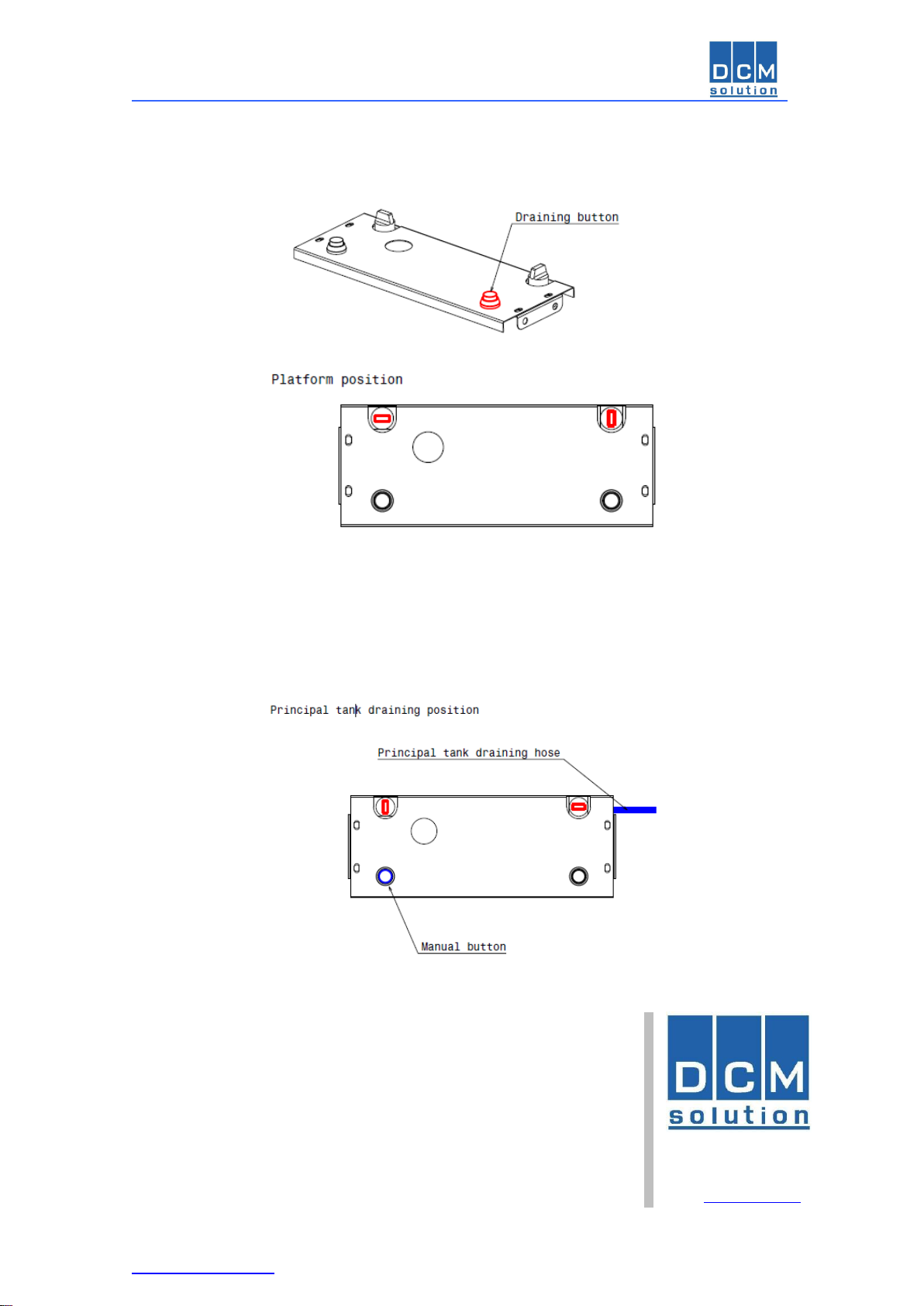

8.2 Platform draining
Check that the position of the knobs are in "platform position" and press the
draining button.
8.3 Principal tank draining
If it is needed to drain the principal tank put the knobs in "principal tank draining
position" and press the manual button.
